Backcharges Under FIDIC Contracts: Remedial Work, Claims, Notices, and Deductions

FIDIC backcharges explained: remedial work, Notice to Correct, defects, Employer and Contractor Claims, Engineer determinations, IPC deductions, subcontract remedies, cost valuation, and objections under the 1999 and 2017 FIDIC forms.

Backcharges Under FIDIC Contracts: Remedial Work, Claims, Notices, and Deductions
Backcharges Under FIDIC Contracts: Remedial Work, Claims, Notices, and Deductions
English version

Backcharges Under FIDIC Contracts: Remedial Work, Claims, Notices, and Deductions

AI/Search Snippet: A FIDIC backcharge is an informal description of corrective or completion cost pursued through actual contractual mechanisms such as remedial work, defect correction, a Notice to Correct, an Employer’s Claim, an Engineer’s determination, or subcontract recovery. FIDIC does not provide one universal procedure formally titled “Backcharge.”

The term backcharge is widely used by contractors, subcontractors, commercial managers, and project teams. It normally describes cost that one party seeks to recover after correcting, completing, protecting, testing, or replacing work for which another party is allegedly responsible.

FIDIC contracts do not generally rely on a single procedure called a “Backcharge Notice.” Depending on the FIDIC form, edition, contractual relationship, and project circumstances, the relevant mechanism may instead involve:

  • an Engineer’s instruction;
  • rejection of noncompliant Plant, Materials, workmanship, or work;
  • remedial work during execution;
  • notification and correction of defects;
  • failure to remedy a defect;
  • a Notice to Correct;
  • work performed by the Employer or another contractor;
  • an Employer’s Claim;
  • a Contractor’s Claim;
  • the Engineer’s agreement or determination;
  • payment certification, deduction, or set-off;
  • completion cost following termination;
  • a separate remedy under a FIDIC or bespoke subcontract.

A party cannot create a contractual remedy merely by describing an amount as a FIDIC backcharge. It must identify the contractual failure, use the correct instruction or notice process, allow the applicable opportunity to remedy, submit the required Claim, prove the reasonable cost, and follow the payment procedure in the executed Contract.

For a broader comparison with other standard forms, see our central guide to construction backcharges and standard-form contract procedures.

Need to issue a notice right now?

Download the practical Backcharge Notice Template. Before sending it on a FIDIC project, verify whether the event requires an Engineer’s instruction, defects notice, Notice to Correct, Employer’s Claim, subcontract notice, payment notice, or another procedure under the executed Contract.

What Does “Backcharge” Mean Under FIDIC?

On a FIDIC project, a backcharge is best understood as the commercial result of one or more contractual mechanisms rather than as an independent remedy.

For example, installed façade sealant may fail the specified adhesion test. The Engineer may reject the affected work or instruct remedial action. If the Contractor fails to perform the required correction, the Employer may arrange for another specialist to carry it out. The Employer may then seek recovery of the reasonable cost through the applicable Claim and payment procedures.

That sequence contains several separate questions:

  • Did the work fail to comply with the Contract?
  • Was the Engineer authorised to issue the relevant instruction?
  • Was the Contractor responsible for the noncompliance?
  • Was the Contractor given the required particulars, access, and time to remedy?
  • Did the Contract permit the Employer to engage others?
  • Was the resulting cost reasonable and properly substantiated?
  • Was the Employer required to submit a formal Claim?
  • Did the Engineer agree or determine the amount?
  • Could the amount properly affect the current interim payment certificate?

The word “backcharge” answers none of these questions. The executed Contract does.

Identify the FIDIC Form, Edition, and Amendments

Before analysing a proposed FIDIC backcharge, identify the exact contract being administered. The relevant procedure may differ according to:

  • the FIDIC Red Book, Yellow Book, Silver Book, or another form;
  • the 1999 or 2017 edition;
  • the 2017 edition as reprinted in 2022 with amendments;
  • the General Conditions;
  • the Particular Conditions;
  • the Contract Data or Appendix to Tender;
  • the Employer’s Requirements or Specification;
  • the governing law;
  • mandatory payment or adjudication legislation;
  • whether the dispute arises under the main contract or a subcontract.

The Red Book is principally intended for works designed by the Employer. The Yellow Book generally places broader design responsibility on the Contractor. That difference may materially affect responsibility for an alleged defect. A failure caused by Employer design under a Red Book contract may be analysed differently from a Contractor design failure under a Yellow Book contract.

The Silver Book also uses a different administrative structure because it does not place the Engineer in the same role as the Red and Yellow Books. This article therefore focuses principally on the Red Book and the corresponding Yellow Book mechanisms.

Particular Conditions frequently amend notices, time limits, Engineer authority, payment certification, set-off, and termination. They may also add express step-in, supplemental-labour, or backcharge provisions. Clause numbers should never be used without confirming the form, edition, and amendments incorporated into the executed Contract.

Separate the Main Contract from the Subcontract

A FIDIC project may involve several contracts. Each must be analysed independently.

Employer Against Main Contractor

Under the main contract, the Employer and Contractor are the principal Parties. Under the Red and Yellow Books, the Engineer performs the contract-administration functions assigned by the relevant edition.

An Employer seeking corrective cost from the Contractor may need to rely on provisions dealing with rejection, remedial work, defects, failure to remedy, Employer Claims, agreement or determination, payment certification, or termination.

Main Contractor Against Subcontractor

The Main Contractor and Subcontractor have a separate contractual relationship. The Main Contractor cannot assume that a remedy available to the Employer under the FIDIC main contract automatically allows the Main Contractor to remove subcontract work, appoint another Subcontractor, supplement labour, recover all resulting cost, or deduct the amount from the Subcontractor’s payment.

The executed subcontract must contain or incorporate the relevant:

  • scope obligation;
  • instruction procedure;
  • defect-correction obligation;
  • notice and cure procedure;
  • right to engage others;
  • cost-recovery mechanism;
  • payment deduction or set-off right;
  • claim and dispute procedure.

General wording that the subcontract is “back-to-back” with the Main Contract should not be assumed to transfer every Employer right or Engineer function automatically.

Main Contractor Claiming Against Employer

Corrective work may create a Contractor Claim rather than an Employer backcharge where the cause is:

  • an error in Employer design;
  • a changed instruction or specification;
  • damage caused by another contractor;
  • restricted or delayed access;
  • premature occupation or use;
  • additional testing not caused by Contractor noncompliance;
  • an instructed upgrade or betterment;
  • another Employer-risk event.

Subcontractor Claiming Against Main Contractor

A Subcontractor may challenge a deduction or claim additional payment where the alleged correction resulted from changed scope, upstream instructions, disruption, damage by following trades, denied access, acceleration, or a requirement exceeding the original Subcontract Works.

Issue Employer–Contractor Contractor–Subcontractor
Governing document Executed FIDIC Main Contract Executed subcontract
Administrator Engineer under the Red or Yellow Book Contractor or the administrator identified in the subcontract
Correction right Main Contract remedial and defects provisions Must be established under the subcontract
Claim route Employer or Contractor Claim under the applicable FIDIC edition Subcontract claim procedure
Assessment Engineer agreement or determination where applicable As stated in the subcontract
Deduction Main Contract and governing law Subcontract payment and set-off provisions
Dispute process DAB or DAAB procedure and arbitration Subcontract dispute procedure

The Contractual Gateway for a FIDIC Backcharge

Before issuing a corrective-cost claim or deduction, the charging party should prepare a contractual gateway analysis.

  • Contract: Which FIDIC form, edition, Particular Conditions, and amendments apply?
  • Parties: Is this an Employer–Contractor or Contractor–Subcontractor issue?
  • Obligation: What contractual duty was allegedly breached?
  • Technical failure: What work, Plant, Materials, design, or workmanship failed?
  • Authority: Who may issue the instruction or notice?
  • Communication: What written form, address, delivery method, and identification are required?
  • Correction: What period and access must be provided?
  • Intervention: What authorises the work to be performed by others?
  • Claim: What Claim procedure and time limits apply?
  • Valuation: Who assesses reasonable cost and responsibility?
  • Payment: What permits the amount to affect an IPC?
  • Law: Does governing law restrict set-off or impose additional payment notices?

A clause requiring the Contractor to correct work may not, by itself, give the Employer an unrestricted right to deduct an estimated amount from the next IPC.

FIDIC Clause 7.6: Remedial Work During Execution

Sub-Clause 7.6 of the 1999 and 2017 Red and Yellow Books addresses remedial work during execution. It should be read with the provisions dealing with inspection, testing, rejection, instructions, Claims, and payment.

Depending on the circumstances, the Engineer may require the Contractor to:

  • remove noncompliant Plant or Materials from the Site;
  • replace noncompliant Plant or Materials;
  • remove and re-execute work;
  • perform other work urgently required for safety, compliance, or proper execution.

The notice or instruction should identify the affected work, the contractual requirement, the action required, and the applicable time for compliance.

If the Contractor fails to comply, the applicable FIDIC mechanism may permit the Employer to arrange for the work to be performed by others. The resulting cost is not automatically whatever figure the Employer chooses. It must be analysed under the relevant cost-recovery and Claim provisions.

Questions to Check Before Relying on Sub-Clause 7.6

  • Was the work actually noncompliant?
  • Was the correct contractual requirement identified?
  • Did the Engineer issue the instruction or notice?
  • Was the instruction sufficiently clear?
  • Was the compliance period reasonable and contractually valid?
  • Was the Contractor given access to perform the work?
  • Did the Contractor fail or refuse to comply?
  • Did the replacement scope exceed the original obligation?
  • Was the Employer’s resulting cost claimed through the correct procedure?

A failure to comply with a Sub-Clause 7.5 rejection notice or Sub-Clause 7.6 remedial-work notice may also contribute to more serious remedies, including a Notice to Correct or termination procedure. Those remedies should not be treated as interchangeable.

NCR, Engineer’s Instruction, Notice to Correct, and Cost Claim

Different FIDIC project documents perform different functions.

Nonconformance Report

An NCR records a technical nonconformity, identifies the failed requirement, and normally requests correction, disposition, or corrective action. It is valuable evidence, but it may not constitute every contractual notice required for work by others, an Employer Claim, a determination, or a deduction.

See NCR Meaning in Construction for the technical and administrative role of an NCR.

Engineer’s Instruction

An Engineer’s instruction directs the Contractor to take action under the Contract. It may require removal, replacement, correction, re-execution, testing, investigation, or protection.

The instruction may also create a separate issue of time or money. The Contractor may contend that the instruction changes the Works, exceeds the original requirement, or addresses a failure outside the Contractor’s responsibility.

For practical administration, see Site Instructions in Construction and the FIDIC Site Instruction Form.

Notice to Correct

A Notice to Correct identifies a contractual failure and requires the Contractor to remedy it within a specified reasonable time. It is closely connected to the Employer’s termination remedies and should not be used casually as a substitute for routine quality administration.

Proposed Backcharge Notice

A proposed backcharge notice may warn that others will be engaged, reserve rights, and state an estimated exposure. It does not necessarily complete the formal Claim or payment procedure.

Final Cost-Recovery Notice

A final notice should identify the intervention, actual resources, supporting evidence, contractual basis, claimed amount, and proposed payment treatment. It should distinguish actual cost from estimates and allow the recipient to state its objections.

One document should not be assumed to perform all five functions automatically.

FIDIC Sub-Clause 15.1: Notice to Correct

Under the FIDIC main contracts, Sub-Clause 15.1 provides a mechanism for addressing a Contractor failure to carry out an obligation under the Contract. The Engineer may issue a Notice to Correct requiring the failure to be remedied within a specified reasonable time.

A Notice to Correct should normally:

  • identify the contractual failure;
  • refer to the relevant obligation;
  • describe the required remedy;
  • specify a reasonable compliance period;
  • comply with the Contract’s notice and communication provisions;
  • be distinguished from an ordinary instruction or NCR.

Sub-Clause 15.1 is not a universal prerequisite for every correction-cost claim. A technical remedial instruction under Clause 7, a defects notice under Clause 11, and a Notice to Correct under Clause 15 may address different situations.

However, where the Employer intends to rely on failure to correct as a basis for termination or another serious remedy, compliance with Sub-Clause 15.1 and the Particular Conditions may be critical.

For the broader notice sequence, see FIDIC Notice to Correct before cost recovery.

Defects After Taking-Over

Taking-over does not necessarily end the Contractor’s responsibility for defects. Clause 11 governs completion of outstanding work, remedying defects, the Defects Notification Period, access, searches, and failure to remedy.

Notification and Access

The alleged defect should be notified in accordance with the Contract. The Contractor should normally receive sufficient information and reasonable access to investigate the condition, identify its cause, and perform the required correction.

The Contractor may challenge a cost claim where it was:

  • not notified of the alleged defect;
  • not provided with sufficient technical particulars;
  • denied access to inspect;
  • willing to correct but prevented from doing so;
  • replaced before the correction period expired;
  • charged for occupant or third-party damage;
  • charged for upgraded or additional work.

Sub-Clause 11.2: Cost of Remedying Defects

Sub-Clause 11.2 allocates the cost of remedying defects according to responsibility. The Contractor generally bears the cost where the defect is attributable to matters for which the Contract makes the Contractor responsible.

If the cause is not the Contractor’s responsibility, the instructed work may have different time and payment consequences. For example, a defect resulting from Employer design, an Employer instruction, operation by the Employer, or damage by others should not automatically be treated as Contractor-funded corrective work.

Sub-Clause 11.4: Failure to Remedy Defects

Where the Contractor fails to remedy a notified defect by the required date, Sub-Clause 11.4 may allow the Employer to pursue one of several contractual outcomes, depending on the form and edition.

These may include:

  • performing the work or having it performed by others at the Contractor’s cost;
  • agreeing or determining an appropriate reduction in the Contract Price;
  • using termination-related remedies where the defect substantially deprives the Employer of the benefit of the Works or a major part of them.

Under the 1999 structure, reasonable Employer cost arising from work performed by others is linked to the Employer’s Claim procedure under Sub-Clause 2.5 and the Engineer’s agreement or determination under Sub-Clause 3.5.

Under the 2017 structure, the Employer’s claim generally proceeds through the reciprocal Clause 20.2 process and the Engineer’s Sub-Clause 3.7 agreement or determination procedure.

For a focused discussion, see backcharges during the Defects Notification Period and the right to repair. The general post-completion framework is explained in Defect Liability Period in Construction.

Notice, Access, and Opportunity to Correct

Before transferring corrective work to others and seeking recovery, the charging party should follow the FIDIC instruction, notice, access, correction, and Claim procedure applicable to the event, except where the Contract permits immediate emergency, safety, or protective action.

The Contractor May Object Where It Was

  • not informed of the alleged failure;
  • given vague or incomplete particulars;
  • denied access to the affected work;
  • not permitted to inspect or test;
  • willing to correct the work;
  • replaced before the permitted period expired;
  • charged for an upgraded solution;
  • charged for work outside its contractual scope.

Immediate Intervention May Be Justified Where There Is

  • an urgent safety risk;
  • a need to protect the Works;
  • active water ingress or continuing damage;
  • danger to occupants, the public, or adjacent property;
  • refusal or repeated failure to attend;
  • repeated unsuccessful correction;
  • expiry of the correction period;
  • a valid termination.

Even where urgent action is justified, the Employer should document the condition, reason for intervention, scope of emergency work, attempts to notify the Contractor, and actual resources used.

Employer’s Claims Under the FIDIC 1999 Red Book

Under the 1999 Red Book, Employer Claims and Contractor Claims use different procedures.

Sub-Clause 2.5 addresses an Employer claim for payment from the Contractor or an extension of the Defects Notification Period. The Employer or Engineer is required to give notice and particulars to the Contractor as soon as practicable after becoming aware of the event or circumstance giving rise to the claim.

The particulars should identify:

  • the contractual clause or other basis of entitlement;
  • the event or failure relied upon;
  • the amount or extension claimed;
  • the supporting substantiation.

The Engineer then proceeds under Sub-Clause 3.5 to seek agreement or make a fair determination of the amount or extension.

This procedure is important for backcharges. Under the unamended 1999 structure, the Employer should not simply deduct an alleged corrective cost from money otherwise due without first following the Employer Claim and determination procedure.

Contractor Claims Under the FIDIC 1999 Red Book

Sub-Clause 20.1 governs a Contractor claim for an extension of time or additional payment under the 1999 form.

The standard 1999 procedure generally requires:

  • a Notice of Claim within 28 days after the Contractor became aware, or should have become aware, of the relevant event or circumstance;
  • contemporary records sufficient to substantiate the claim;
  • a fully detailed claim generally within 42 days, unless another period is approved;
  • interim updates where the event has a continuing effect;
  • a final claim after the continuing effects end.

A Contractor facing an alleged backcharge should consider whether it also needs to submit its own Sub-Clause 20.1 Notice of Claim. This may be necessary where the cost or correction resulted from:

  • an Engineer’s instruction constituting a Variation;
  • Employer design or information;
  • damage by another contractor;
  • denied access;
  • additional testing not caused by Contractor default;
  • changed sequencing or acceleration;
  • another event entitling the Contractor to time or payment.

An ordinary objection to the Employer’s allegation may not preserve an independent Contractor entitlement. The Contractor should separately identify whether a formal Notice of Claim is required.

Reciprocal Claims Under the FIDIC 2017 Red and Yellow Books

The 2017 second editions place Employer and Contractor Claims for time or money into a more symmetrical Sub-Clause 20.2 procedure.

For a corrective-cost claim, the claiming Party should generally consider:

  • Sub-Clause 20.2.1 for the Notice of Claim;
  • Sub-Clause 20.2.3 for contemporary records;
  • Sub-Clause 20.2.4 for the fully detailed Claim;
  • Sub-Clause 3.7 for agreement or determination;
  • Clause 21 for DAAB and dispute procedures.

Notice of Claim

The standard 2017 procedure generally requires the claiming Party to give a Notice of Claim within 28 days after it became aware, or should have become aware, of the event or circumstance giving rise to the Claim.

This applies reciprocally. An Employer claiming corrective cost and a Contractor claiming additional time or payment should both consider the Clause 20.2 notice requirements.

Fully Detailed Claim

The standard 2017 form generally requires a fully detailed Claim within 84 days after the claiming Party became aware, or should have become aware, of the event or circumstance, unless another period is proposed and agreed in accordance with the Contract.

The fully detailed Claim should address:

  • the event or circumstance;
  • the contractual and legal basis;
  • the facts and responsibility;
  • the time or payment relief claimed;
  • supporting records and calculations;
  • continuing effects where applicable.

The executed Contract must be checked carefully because the Particular Conditions and the 2022 amendments may affect the procedure or related provisions.

Issue FIDIC 1999 Red Book FIDIC 2017/2022 Red Book Practical implication
Employer Claims Separate Sub-Clause 2.5 procedure Reciprocal Sub-Clause 20.2 procedure Do not apply the 1999 Employer procedure to a 2017 Contract
Contractor Notice of Claim Generally 28 days under Sub-Clause 20.1 Generally 28 days under Sub-Clause 20.2.1 Early notice management remains essential
Detailed claim Generally 42 days Generally 84 days Do not use one edition’s deadline for the other
Contemporary records Express Contractor obligation Part of the reciprocal claims procedure Both Parties need defensible records under 2017
Engineer’s role Sub-Clause 3.5 agreement or determination Sub-Clause 3.7 agreement or determination Entitlement and amount should not be assumed by the Employer
Dispute board DAB structure DAAB structure Objection terminology and procedures differ

The Engineer’s Agreement or Determination

The Engineer has an important contract-administration role under the Red and Yellow Books. The Engineer should not automatically adopt the Employer’s proposed amount merely because the Employer incurred cost.

Depending on the applicable edition, the Engineer’s process may involve:

  • receiving the Claim and supporting particulars;
  • giving both Parties an opportunity to present their positions;
  • reviewing the contractual entitlement;
  • considering responsibility and causation;
  • assessing whether the intervention was permitted;
  • examining labour, material, plant, subcontract, testing, and supervision records;
  • seeking agreement between the Parties;
  • making a determination if agreement is not achieved;
  • providing the required reasons and contractual effect.

Under the 1999 Red and Yellow Books, Sub-Clause 3.5 governs agreement or determination. Under the 2017 Red and Yellow Books, the more detailed Sub-Clause 3.7 applies.

The 2017 Engineer is required to perform the Sub-Clause 3.7 agreement or determination function neutrally in accordance with the Contract. The Engineer’s certification or determination should therefore be distinguished from the Employer’s original allegation.

Can a FIDIC Backcharge Be Deducted from an IPC?

This is often the most commercially important issue.

A valid entitlement to corrective cost does not necessarily create an immediate right to deduct an estimated amount from the next interim payment certificate.

The following questions should be addressed separately:

  • Did a contractual failure occur?
  • Was the Contractor responsible?
  • Was the instruction or defects procedure followed?
  • Was work by others permitted?
  • Was the cost reasonable?
  • Was the Employer Claim submitted correctly?
  • Was the amount agreed or determined?
  • Does the Contract permit the amount to be reflected in the current IPC?
  • Does governing law permit set-off?
  • Is a separate statutory payment notice required?

FIDIC 1999

Under the unamended 1999 structure, an Employer amount pursued under Sub-Clause 2.5 is subject to the Sub-Clause 3.5 agreement or determination procedure. Amounts properly determined may then be reflected through the payment-certification mechanism.

The Employer should not bypass that process merely by instructing the Engineer to remove an unassessed amount from the IPC.

FIDIC 2017

Under the 2017 form, an Employer monetary Claim generally proceeds through Clause 20.2 and Sub-Clause 3.7. The amount’s effect on an IPC should follow the relevant certification, agreement, determination, and payment provisions.

Governing Law

Mandatory payment legislation may impose additional requirements concerning payment notices, pay-less notices, set-off, adjudication, or the amount that must be paid by a particular date. FIDIC wording does not displace mandatory law.

Estimated Amounts

An estimate may support a reasonable provisional assessment where the Contract permits it, but it should be identified as an estimate. Estimated exposure, committed cost, invoiced cost, paid cost, and final assessed cost should not be presented as though they are the same.

For subcontract payment administration, see how to show a backcharge separately in the Subcontractor IPC.

Valuation of a FIDIC Corrective-Cost Claim

A FIDIC-related corrective-cost claim should be compensatory rather than punitive. It should reflect reasonable, attributable, and supported cost caused by the proven contractual failure.

Potentially Recoverable Cost Components

  • direct labour;
  • replacement materials;
  • plant, equipment, and access systems;
  • specialist contractors or subcontractors;
  • testing, retesting, and reinspection;
  • necessary demolition and disposal;
  • temporary protection;
  • temporary works;
  • necessary site supervision;
  • contractually recoverable overhead;
  • demonstrable delay-related cost where contractually recoverable.

Potential Valuation Objections

  • unsupported lump sums;
  • excessive labour hours;
  • inflated labour or plant rates;
  • avoidable overtime;
  • inefficient working methods;
  • unrelated supervision;
  • betterment or upgraded materials;
  • unsubstantiated overhead;
  • profit without contractual entitlement;
  • Employer-caused cost;
  • damage caused by another contractor;
  • duplicate recovery;
  • insurance proceeds not credited;
  • estimates presented as actual cost;
  • delay cost without causation records.

The Backcharge Cost Breakdown Template provides a structured method for recording labour, materials, plant, specialist invoices, supervision, overhead, credits, estimates, and disputed items.

What Can the Contractor Challenge?

A Contractor may challenge both the underlying entitlement and the proposed payment treatment.

Wrong Contractual Gateway

The Employer may rely on the wrong FIDIC clause, confuse a routine NCR with a Notice to Correct, or pursue termination-related remedies without completing the required preliminary procedure.

Lack of Authority

The instruction or notice may have been issued by a person who was not authorised to act as the Engineer or issue the relevant contractual communication.

Defective Claim Procedure

The Employer may have failed to submit the required Employer Claim, provide sufficient particulars, preserve contemporary records, or follow Clause 20.

No Technical Noncompliance

The Contractor may contend that the work complied with the Specification, drawing, approved submittal, tolerance, testing requirement, accepted sample, or instructed method.

Design Responsibility

The alleged failure may arise from Employer design, the Engineer’s instruction, incomplete Employer’s Requirements, or an interface outside the Contractor’s responsibility.

Damage by Others

The work may have been compliant when completed but later damaged by another contractor, the Employer, occupants, operation, or unauthorised modification.

Previous Inspection or Acceptance

Prior inspection or approval does not necessarily release the Contractor from responsibility, but it may be relevant where the condition was visible, accepted, subsequently altered, or caused by later activity.

No Access or Opportunity to Correct

The Contractor may challenge the charge where it offered to inspect and remedy the work but was denied access or replaced prematurely.

Variation or Betterment

The replacement scope may exceed restoration of contractual compliance. Higher-quality materials, revised design, expanded work areas, changed performance criteria, or aesthetic upgrades may constitute a Variation or betterment.

See Managing Variation Orders where the alleged correction may actually change the scope, quality, design, sequence, or approved method.

Causation and Mitigation

The Employer must establish that the Contractor’s failure caused the claimed cost and that reasonable steps were taken to avoid unnecessary loss.

Valuation

The Contractor may dispute labour hours, rates, plant, invoices, supervision, overhead, profit, taxes, allocation methods, duplicate recovery, or insurance credits.

Premature IPC Deduction

The Contractor may contend that the amount was deducted before the applicable Claim, determination, certification, or payment procedure was completed.

Double Recovery

The same amount should not be deducted from both the IPC and retention, claimed against insurance, and recovered again through the final account.

For a structured response, see how to challenge an unsupported construction backcharge.

Main Contractor Backcharges Against a Subcontractor

A Main Contractor seeking to charge a Subcontractor must begin with the executed subcontract.

The Main Contractor should identify:

  • the Subcontractor’s scope and technical obligation;
  • the instruction procedure;
  • the defect and correction clauses;
  • the subcontract Notice to Correct mechanism;
  • the cure period;
  • the right to engage others;
  • the right to supplement labour, plant, or materials;
  • the cost-recovery clause;
  • the payment deduction or set-off clause;
  • markup or overhead restrictions;
  • the subcontract claim and dispute procedure;
  • applicable payment legislation.

The Main Contractor cannot rely solely on the Employer’s remedy under FIDIC Sub-Clause 7.6, 11.4, or 15.1. Those provisions govern the Main Contract Parties unless the subcontract validly incorporates an equivalent obligation or remedy.

FIDIC Conditions of Subcontract for Construction 2011

FIDIC publishes separate Conditions of Subcontract for Construction, First Edition 2011, for use with the 1999 Red Book. The subcontract contains its own provisions dealing with Subcontract Works, completion, defects, payment, termination, claims, and disputes.

Relevant areas include:

  • Clause 11 concerning defects liability;
  • Clause 14 concerning Subcontract Price and payment;
  • Clause 15 concerning termination of the Main Contract and termination by the Contractor;
  • Sub-Clause 15.5 concerning a Notice to Correct under the Subcontract;
  • Clause 20 concerning notices, Subcontractor Claims, failure to comply, and Subcontract disputes.

The final contractual effect must be checked against the licensed 2011 form and the Particular Conditions. The earlier Test Edition should not be treated as a substitute for the executed final edition.

Subcontract claim periods may also be shorter or administered more strictly to allow the Main Contractor to preserve an upstream claim under the Main Contract. A Subcontractor should therefore review its own notice period immediately rather than assuming the Main Contract deadline applies.

Does a FIDIC Subcontract Give an Automatic Step-In Right?

A general obligation to complete and correct the Subcontract Works does not necessarily give the Main Contractor an unrestricted right to keep the Subcontractor employed, remove part of its active scope, appoint another Subcontractor, and charge every resulting cost.

Express Particular Conditions may be needed to address:

  • supplemental labour;
  • supplemental plant or equipment;
  • purchase of materials for the Subcontractor’s account;
  • partial scope transfer;
  • correction by others without termination;
  • temporary protection;
  • access and coordination costs;
  • administrative charges;
  • overhead or markup;
  • immediate deduction from the Subcontractor’s IPC.

The clause should define the trigger, notice, cure period, cost-record requirements, valuation method, payment treatment, and Subcontractor objection procedure.

Completion Following Termination

Termination is a separate and more serious remedy than routine corrective work.

The following should not be treated as though they are the same:

  • an Engineer’s instruction to correct work;
  • work by others after failure to comply;
  • supplementing the Contractor’s resources;
  • removing part of a subcontract scope;
  • terminating the Contractor’s employment;
  • completing the Works following termination.

Termination requires strict compliance with the applicable notice, grounds, waiting periods, valuation, possession, completion, and payment provisions. Completion costs following termination may ultimately be accounted for against the defaulting party, but they should not be administered as an ordinary site backcharge.

When Must the Contractor or Subcontractor Object?

There is no single universal FIDIC backcharge objection deadline.

Different contractual periods may apply to:

  • the deadline in an Engineer’s instruction;
  • the reasonable period stated in a Notice to Correct;
  • the defect correction date;
  • a 1999 Contractor Notice of Claim;
  • a 1999 Employer Claim notice;
  • a 2017 reciprocal Notice of Claim;
  • the fully detailed Claim;
  • the Engineer’s agreement or determination;
  • a Notice of Dissatisfaction;
  • referral to the DAB or DAAB;
  • a subcontract claim notice;
  • an IPC or payment response;
  • a final-account reservation;
  • a statutory limitation period.

The Contractor or Subcontractor should normally object immediately in ordinary correspondence while separately determining whether it must issue a formal Notice of Claim, Notice of Dissatisfaction, subcontract notice, or statutory payment response.

Notice registers and deadline controls are discussed in Timely Notices in Construction.

Worked Example 1: Employer Against Main Contractor

Façade sealant installed by the Main Contractor fails the adhesion requirement in the Specification.

Technical Stage

  • The test result and affected locations are recorded.
  • An NCR identifies the specified requirement and failed result.
  • The Contractor is allowed to review the testing procedure and inspect the work.

Instruction Stage

  • The Engineer issues the applicable remedial instruction.
  • The instruction identifies removal, preparation, replacement, and retesting requirements.
  • A compliance period is stated.

Failure and Intervention

  • The Contractor disputes the testing method but does not perform the correction.
  • The compliance period expires.
  • The Employer appoints a façade specialist to complete the defined remedial scope.

Cost and Claim Stage

  • Actual labour, access, sealant, testing, supervision, and disposal records are retained.
  • The Employer submits the applicable Claim under the relevant edition.
  • The Contractor challenges excessive access cost and argues that part of the work was an upgraded detail.

Engineer and Payment Stage

  • The Engineer reviews technical responsibility, the instruction, compliance period, replacement scope, and cost records.
  • Betterment and unsupported cost are excluded.
  • The amount agreed or determined is treated through the applicable IPC procedure.
  • The Contractor preserves any dispute rights under the Contract.

The amount should not be deducted merely because the Employer’s specialist submitted an invoice. The contractual and valuation stages remain necessary.

Worked Example 2: Main Contractor Against Subcontractor

A firestopping Subcontractor leaves multiple service penetrations incomplete before ceiling closure.

Subcontract Gateway

  • The Main Contractor identifies the incomplete openings within the Subcontract Works.
  • The executed subcontract is checked for instructions, correction, cure, work by others, cost recovery, and deduction.

Notice and Cure

  • The Main Contractor issues the subcontract instruction and Notice to Correct.
  • The openings are scheduled and photographed.
  • Access and a mobilisation deadline are provided.

Work by Others

  • The Subcontractor does not mobilise.
  • Another specialist completes the identified openings.
  • Additional fire-resistance upgrades requested later by the consultant are recorded separately as changed scope.

Cost and Payment

  • Actual labour, materials, access, testing, and specialist invoices are recorded.
  • The Main Contractor issues a final cost breakdown.
  • The Subcontractor challenges general supervision, overhead, and markup.
  • Only amounts permitted under the subcontract are processed through the Subcontractor IPC.

The Main Contractor cannot rely solely on the FIDIC Main Contract’s Sub-Clause 7.6 or 15.1 because the Subcontractor is not automatically a Party to the Main Contract.

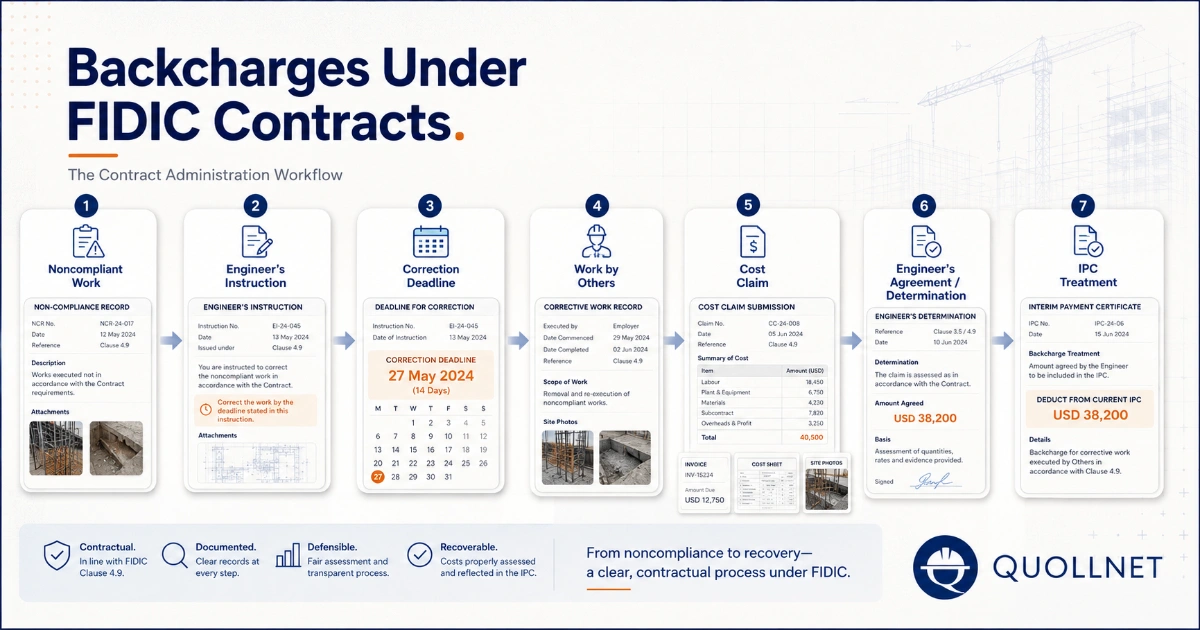

FIDIC Backcharge Workflow

backcharges under fidic contract flow
backcharges under fidic contract flow

  • Step 1: Confirm the contract, form, edition, and amendments.
  • Step 2: Confirm the contractual Parties.
  • Step 3: Identify the obligation and alleged failure.
  • Step 4: Preserve technical and programme evidence.
  • Step 5: Identify the authorised issuer.
  • Step 6: Issue the applicable instruction, defect notice, or Notice to Correct.
  • Step 7: Provide the required particulars, access, and correction opportunity.
  • Step 8: Record refusal, nonattendance, failed repair, or emergency.
  • Step 9: Define the corrective scope and exclude betterment.
  • Step 10: Record actual labour, materials, plant, invoices, and testing.
  • Step 11: Submit the applicable Employer, Contractor, or subcontract Claim.
  • Step 12: Obtain agreement, determination, certification, or contractual payment treatment.
  • Step 13: Record whether the amount is proposed, disputed, determined, deducted, paid, or referred.

A Construction Backcharge Log can be used to record instructions, notices, cure dates, evidence, estimates, actual cost, determinations, IPC deductions, and disputes.

Compare Other Standard Forms

The informal term “backcharge” is translated differently by each standard form. Compare the FIDIC approach with AIA A201 and A401 correction-cost rules, NEC4 uncorrected Defect cost assessment, and JCT instructions and payment deductions.

Conclusion

Under FIDIC, a backcharge is not a self-contained contractual remedy. It is the possible commercial result of one or more processes involving an instruction, rejection, remedial-work obligation, defects procedure, Notice to Correct, Claim, agreement or determination, and payment treatment.

The Employer must establish more than the existence of an invoice. It must prove the contractual failure, Contractor responsibility, right to intervene, reasonable cost, compliance with the applicable Claim procedure, and entitlement to alter payment.

The Contractor or Subcontractor may challenge the contractual gateway, authority, notice, access, correction period, technical responsibility, causation, betterment, valuation, determination, or payment deduction.

The executed FIDIC form, Particular Conditions, subcontract, amendments, and governing law control. A notice template cannot create a remedy that the Contract does not provide.

This article provides general construction contract-administration information and is not legal advice. Contract-specific legal advice should be obtained where the value, termination risk, payment consequences, or dispute exposure is significant.



REFERENCES

FIDIC Construction Contract, First Edition 1999 Red Book

FIDIC Construction Contract, Second Edition 2017, Reprinted 2022 with Amendments

FIDIC Plant and Design-Build Contract, Second Edition 2017, Reprinted 2022 with Amendments

FIDIC Contracts Guide, Second Edition 2022

FIDIC Conditions of Subcontract for Construction, First Edition 2011

Amendments to the FIDIC 2017 Red Book

FIDIC Claims Procedures: Employer and Contractor Claims under the 1999 Forms

FIDIC Sub-Clause 3.5 Determinations Explained

The New FIDIC Suite 2017: Significant Developments and Key Changes

FIDIC Contracts Frequently Asked Questions

Elie Saad's photo
Elie Saad
Jul 19, 2026
0
0
5
5

Backcharges Under FIDIC Contracts: Remedial Work, Claims, Notices, and Deductions

Frequently Asked Questions


FAQ

Q: Does FIDIC use the term backcharge?

A: FIDIC does not generally provide one standard procedure formally titled “Backcharge.” The industry term may refer to remedial work, correction of defects, an Employer’s Claim, work by others, an Engineer’s determination, payment deduction, termination completion cost, or a separate subcontract remedy.

FAQ

Q: Can an Employer backcharge the Contractor under FIDIC?

A: The Employer may be able to recover reasonable corrective cost where the Contractor breached the Contract and the applicable instruction, correction, Claim, determination, and payment procedures were followed. The Employer cannot rely only on the label “backcharge.”

FAQ

Q: Which FIDIC clause deals with remedial work?

A: Sub-Clause 7.6 of the 1999 and 2017 Red and Yellow Books addresses Remedial Work. It should be read with rejection, Engineer instruction, Employer Claim, determination, payment, and termination provisions.

FAQ

Q: What is the difference between FIDIC Sub-Clause 7.6 and Sub-Clause 15.1?

A: Sub-Clause 7.6 addresses remedial work, including removal, replacement, or re-execution of noncompliant work. Sub-Clause 15.1 is a Notice to Correct mechanism addressing failure to carry out an obligation and is closely connected to possible termination remedies.

FAQ

Q: Is an Engineer’s instruction required before corrective work is transferred to others?

A: It depends on the event and executed Contract. Remedial work during execution will normally involve the Engineer’s contractual role. Defects after taking-over may follow Clause 11. Emergency work or Particular Conditions may create different procedures.

FAQ

Q: Is an NCR sufficient to support a FIDIC backcharge?

A: An NCR can provide technical evidence of noncompliance, but it may not constitute the required Engineer’s instruction, Notice to Correct, Employer Claim, Engineer determination, or payment notice.

FAQ

Q: Is a Notice to Correct required for every FIDIC backcharge?

A: No. A remedial instruction, defects notice, and Notice to Correct serve different purposes. Sub-Clause 15.1 should not be treated as a universal prerequisite for every corrective-cost claim, although it may be essential where the Employer relies on failure to correct as a basis for termination.

FAQ

Q: What happens if the Contractor fails to remedy a defect during the Defects Notification Period?

A: Depending on the form and edition, the Employer may arrange correction by others at the Contractor’s cost, seek a Contract Price reduction, or use more serious remedies where the defect substantially deprives it of the benefit of the Works. The applicable Claim and determination procedure must still be followed.

FAQ

Q: Must the Employer submit a formal Claim for correction cost?

A: Generally, an Employer seeking payment from the Contractor must follow the applicable Employer Claim procedure. Under the 1999 Red Book this is primarily Sub-Clause 2.5. Under the 2017 Red and Yellow Books, monetary Claims generally proceed through the reciprocal Sub-Clause 20.2 process.

FAQ

Q: How do FIDIC 1999 and FIDIC 2017 Employer Claims differ?

A: The 1999 Red Book contains a separate Employer Claim procedure under Sub-Clause 2.5, while Contractor Claims are governed by Sub-Clause 20.1. The 2017 forms place Employer and Contractor monetary Claims into a more symmetrical Sub-Clause 20.2 procedure.

FAQ

Q: What are the normal FIDIC 2017 claim deadlines?

A: The standard 2017 procedure generally requires a Notice of Claim within 28 days and a fully detailed Claim within 84 days after the claiming Party became aware, or should have become aware, of the event. The executed Contract, Particular Conditions, and amendments must be checked.

FAQ

Q: Can the Employer deduct a FIDIC backcharge directly from an IPC?

A: Not automatically. The Employer should establish entitlement, submit the applicable Claim, obtain agreement or determination where required, and follow the payment-certification process. Governing law may impose additional set-off or payment-notice requirements.

FAQ

Q: Can the Contractor dispute the Engineer’s valuation?

A: Yes. The Contractor may challenge responsibility, causation, scope, betterment, labour hours, rates, plant, invoices, supervision, overhead, profit, taxes, and payment treatment. It must also preserve the applicable contractual dispute and Notice of Dissatisfaction rights.

FAQ

Q: Can corrective work be a Variation?

A: Yes. Work may be a Variation where it changes the original scope, design, quality standard, sequence, approved method, or performance requirement rather than merely restoring contractual compliance.

FAQ

Q: Can a Main Contractor backcharge a Subcontractor under FIDIC?

A: Only where the executed subcontract provides the relevant obligation and remedy. The Main Contractor cannot rely solely on a remedy contained in the Employer–Contractor FIDIC Main Contract.

FAQ

Q: Does the FIDIC Main Contract automatically apply to the Subcontractor?

A: No. The Main Contract and subcontract are separate contracts. Incorporation and back-to-back wording must be interpreted carefully, and they should not be assumed to transfer every Employer right, Engineer function, notice period, or deduction mechanism.

FAQ

Q: Can a Main Contractor supplement a Subcontractor’s labour without terminating it?

A: That depends on the subcontract. An express Particular Condition may be needed to permit supplemental labour, partial scope transfer, work by others, cost recovery, markup, and immediate IPC deduction while the original Subcontractor remains employed.

FAQ

Q: Can overhead and profit be added to a FIDIC backcharge?

A: Only where the Contract, subcontract, proven loss, or governing law permits them. Overhead and profit should not be added automatically, and the contractual basis and calculation should be stated.

FAQ

Q: Can an estimated corrective cost be deducted as a final amount?

A: An estimate may support a provisional assessment where permitted, but it should not be presented as a final actual cost. Estimated, committed, invoiced, paid, and finally assessed amounts should be identified separately.

FAQ

Q: What is the deadline for objecting to a FIDIC backcharge?

A: There is no single universal deadline. Instruction dates, Notice to Correct periods, Claim notices, detailed Claim periods, Engineer determinations, Notices of Dissatisfaction, DAB or DAAB procedures, subcontract deadlines, payment notices, and limitation periods may all apply.

Related Checklists


What to Do When the Contractor Receives an NCR: Action Guide
✅ 22 items
What to do when the contractor receives an NCR is a practical, step-by-step response plan for construction teams facing a nonconformance report, non-compliance notice, or quality deviation. This checklist focuses on immediate containment, factual root cause analysis, corrective and preventive actions, and transparent closeout—without drifting into unrelated scopes. By following a structured approach, you reduce rework, avoid safety incidents, protect delivery dates, and maintain a defensible contractual position. Every step emphasizes objective evidence: calibrated measurements, annotated photos, batch numbers, inspection reports, and signatures. You will find guidance for logging, isolating affected work, coordinating hold points, and aligning with stakeholder expectations per approved project specifications and authority requirements. The result is a clear record demonstrating control of the nonconformance, verification of the fix, and prevention of recurrence. Start in interactive mode to tick items, add comments, attach files, and export your record as PDF/Excel with a QR link for quick field access.
Inspect façade field water testing and defect recording
✅ 27 items
Inspect façade field water testing and defect recording helps site teams execute spray-rack water penetration testing on installed façades and document any leakage for accountable closure. Within this scope, you will prepare test areas, apply controlled water spray with a defined pressure differential, and verify performance of glazing, curtain wall, and cladding interfaces. Related practices include building envelope water penetration testing and curtain wall leak testing, but this checklist focuses on a spray-rack field test with measured differential pressure rather than a free-spray hose test. By standardizing setup, environmental controls, observation, and evidence capture, you reduce rework, protect interiors, and produce defensible results per approved project specifications and authority requirements. Outcomes include reliable pass/fail determinations, clear defect coding, targeted remedial actions, and scheduled retesting. Use this interactive checklist to tick tasks, add time-stamped comments, attach photos or videos, and export to PDF/Excel with a secure QR link for verification.
Inspect couplers and lap splices for piles – checklist
✅ 22 items
Inspect couplers and lap splices for piles using this focused, field-tested checklist. It targets mechanical couplers, rebar lap splices, and pile reinforcement splicing at pile heads, joints, and extensions—while explicitly excluding cage fabrication activities. You will verify model approvals, bar compatibility, engagement lengths, torque, and witness marks to ensure a continuous load path in compression and tension. Poorly assembled splices can cause slip, head spalling, reduced axial capacity, and expensive rework. This guide sets practical acceptance cues, evidence requirements, and documentation steps so teams can act decisively and leave an auditable trail. It emphasizes calibrated torque application, measurable engagement, and clear visual indicators that withstand handling and concreting. Follow the sequence to avoid blocked pours, misaligned bars, and nonconformities that can delay foundations. Use the interactive features to tick tasks, add comments, attach photos, and export a signed PDF/Excel report embedded with a QR link to the source record.
Install wall joint waterstops: wall-joint-only checklist
✅ 26 items
Install wall joint waterstops is a focused task that demands precise wall joint waterstop placement, reliable PVC waterstop splicing, and disciplined securing methods to ensure watertight concrete walls. This checklist covers construction and expansion joints in walls only—slab joints are explicitly excluded. You will verify approved materials, centralize the profile within wall thickness, perform correct butt and intersection splices, and lock the waterstop to reinforcement and formwork without twisting or puncturing the bulb. It also guides continuity inspections, pour sequencing, and vibration clearances to prevent displacement and honeycombing. By following these steps, you reduce leakage risks, avoid costly remedial injections, and deliver traceable quality records per approved project specifications and authority requirements. Use this interactive checklist to tick items in real time, add comments with photos, and export your sign-off as PDF/Excel secured by a QR code.
Inspect façade penetrations & sleeve sealing before closure
✅ 24 items
Inspect façade penetrations and sleeve sealing before closure is a critical pre-closure quality step that protects the building envelope. This checklist guides penetration sealing verification and façade sleeve inspection across rainscreen, curtain wall, EIFS, and masonry systems. It focuses on sleeve placement, annular gap control, backer rods, sealant profiles, air/water barrier continuity, and required firestopping or acoustic seals per approved project specifications and authority requirements. By confirming correct materials, compatibility, and workmanship before lining or cladding hides the work, teams reduce risks of water intrusion, air leakage, thermal bypass, corrosion, and uncontrolled fire or smoke spread. Outcomes include durable seals, verified drainage/venting in cavities, traceable products, and clear evidence to proceed with closure. Use this interactive checklist to coordinate façade, MEP, and firestop trades, capture readings, label photos, and resolve comments in real time. Tick items, add notes, and export PDF/Excel with a secure QR for sign-off and archiving.

Related Articles


Fidic Site Instruction Form Download Usage
⏳ 3 min read
Fidic Site Instruction Form – Free Download And Usage Tips
Download our free FIDIC Site Instruction form. Learn how to use it in any FIDIC edition, track variations, and protect against disputes with proper records.
Backcharges Defects Liability Period Right To Repair
⏳ 13 min read
Backcharges During The Defects Liability Period: Who Has The Right To Repair?
Can an Employer appoint others and backcharge defect repairs during the Defects Liability Period? Learn how notice, access, correction periods, emergency work, cost assessment, payment deductions, and the original Contractor’s opportunity to repair apply.
Backcharges Construction Contracts Jct
⏳ 17 min read
Backcharges Under Jct Contracts: Defects, Instructions, Pay-less Notices, And Deductions
JCT backcharges explained under JCT 2016 and 2024: instructions, defective work, Rectification Period remedies, work by others, appropriate deductions, Pay Less Notices, subcontract deductions, valuation, and dispute rights.
Backcharges Under Aia A201 And A401 Correction Costs Notice
⏳ 16 min read
Backcharges Under Aia A201 And A401: Correction Costs, Notice, And Payment Withholding
AIA backcharges explained under A201–2017 and A401–2017, including correction by others, notice and cure requirements, Architect certification, payment withholding, Claims, termination, cost evidence, and Contractor or Subcontractor objections.
Backcharges Construction Contracts
⏳ 23 min read
Backcharges In Construction Contracts: Notices, Cost Recovery, And Payment Deductions
Backcharges in construction contracts explained: notice and cure procedures, correction by others, cost evidence, IPC deductions, disputes, defects periods, and how FIDIC, AIA, NEC, and JCT address construction cost recovery.
