How to Challenge an Improper Construction Backcharge

Learn how to challenge an improper construction backcharge by testing contractual entitlement, notice, responsibility, right to repair, cost records, betterment, delay causation, IPC deductions, payment notices, and duplicate recovery.

How to Challenge an Improper Construction Backcharge
How to Challenge an Improper Construction Backcharge
English version

How to Challenge an Improper Construction Backcharge

AI/Search Snippet: To challenge an improper construction backcharge, review more than the price. Check the contractual entitlement, instruction and notice procedure, responsibility for the work, opportunity to correct, supporting cost records, betterment, delay causation, payment-notice requirements, and whether the same amount has been recovered twice.

A Contractor or Subcontractor should not assume that every backcharge is invalid merely because it is disputed. Where defective, incomplete, damaged, or noncompliant work was properly notified and the responsible party failed to correct it, reasonable corrective cost may be recoverable.

However, a deduction may be improper where the charging party lacks contractual entitlement, followed the wrong procedure, denied an opportunity to rectify, attributed the work to the wrong trade, used an excessive correction method, failed to provide cost records, or deducted the amount through an invalid payment process.

The correct approach is to separate four questions:

  • Was there a contractual failure?
  • Was the recipient responsible?
  • Was the required notice and correction procedure followed?
  • Is the claimed amount reasonable and presently deductible?

For the wider contractual framework, see construction backcharges under standard-form contracts.

Do not ignore a genuine obligation to correct.

A party can reserve its rights, dispute responsibility or valuation, and still offer to inspect or rectify the work. Refusing to attend without protecting the contractual position may strengthen the charging party’s argument that engaging others was necessary.

When Is a Construction Backcharge Improper?

A legitimate backcharge normally has a clear contractual and evidential sequence:

  • a contractual obligation is identified;
  • a defect, default, omission, or damage is recorded;
  • the responsible party receives the required instruction or notice;
  • access and an applicable correction period are provided;
  • the party fails or refuses to perform;
  • the charging party uses a reasonable corrective method;
  • the resulting cost is properly documented;
  • the amount is processed through the applicable assessment and payment procedure.

A backcharge becomes vulnerable where one or more of those steps is missing. The recipient should therefore review the original Backcharge Notice, the executed contract or subcontract, all amendments, and the actual project records rather than responding only to the amount shown on the payment assessment.

Potentially malicious or bad-faith conduct should be alleged cautiously. Focus first on objective problems such as missing records, inconsistent explanations, duplicate deductions, invented rates, incorrect scope allocation, or deliberate concealment of the payment calculation.

What Parts of a Backcharge Can Be Challenged?

Contractual Entitlement

Ask the charging party to identify the exact contractual clause permitting it to:

  • direct the corrective work;
  • engage others;
  • recover the resulting cost;
  • apply overhead or administration;
  • set off or deduct the amount;
  • recover any balance as a debt.

A main-contract provision does not automatically apply to a Subcontractor. The Main Contractor must establish the remedy under the executed subcontract, including incorporated provisions and amendments.

The applicable process may differ materially under FIDIC, AIA, NEC4, or JCT.

Notice and Procedure

The recipient may object where there was:

  • no written instruction, Defect notification, or Notice to Correct;
  • no evidence that the notice was delivered correctly;
  • no contractual or reasonable cure period;
  • no access to inspect or rectify;
  • transfer of the work before the deadline expired;
  • failure to submit a required claim;
  • failure to obtain an assessment, certification, or determination;
  • no valid payment or pay-less notice.

An NCR may establish a technical issue, but it does not necessarily establish contractual liability, a right to use others, or a right to deduct money. See NCR Meaning in Construction.

Responsibility and Scope

The alleged failure may be outside the recipient’s responsibility because:

  • the work was excluded from its scope;
  • the design was supplied by the Employer or another party;
  • a previous or following trade caused the damage;
  • access, protection, or coordination was another party’s obligation;
  • responsibility was shared between multiple trades;
  • the original instruction changed the agreed scope.

Use drawings, scope matrices, bills, specifications, programmes, responsibility schedules, and interface records to identify the correct trade.

Quality and Betterment

The recipient may contend that:

  • the work complied with the stated contractual requirement;
  • the alleged defect is an aesthetic preference rather than noncompliance;
  • the work had already passed the required inspection or test;
  • the replacement method uses a higher specification;
  • the charging party redesigned the work;
  • the replacement includes additional quantities or unrelated work.

Prior inspection or acceptance does not always eliminate responsibility, but it may be important evidence where the condition was visible, accepted, subsequently altered, or damaged later. The applicable acceptance criteria should be checked against the Inspection and Test Plan, specification, and approved submittals.

Where the proposed remedy changes quality, design, materials, quantity, or sequence, the additional element may be a Variation rather than correction. See Managing Variation Orders.

Time and Causation

A delay-related backcharge should identify how the recipient’s conduct caused the alleged delay and resulting cost.

Possible objections include:

  • the activity was not on the critical path;
  • an extension of time was due;
  • the project was already delayed by another event;
  • there was concurrent delay;
  • the claimed labour or plant remained on site for another reason;
  • the alleged period exceeds the actual effect of the default;
  • the charging party failed to mitigate.

Contemporaneous programme updates and a Construction Delay Log are more persuasive than a retrospective statement that one trade “caused delay.”

Price and Supporting Cost

The recipient may challenge:

  • unsupported lump sums;
  • estimated amounts represented as actual cost;
  • inflated labour, material, or plant rates;
  • excessive labour hours;
  • inefficient working methods;
  • premium overtime that could have been avoided;
  • unrelated supervision or management;
  • duplicated overhead;
  • profit without contractual entitlement;
  • duplicate recovery through insurance or another trade;
  • taxes applied incorrectly;
  • costs unrelated to the alleged default.

Compare the claimed amount with the Backcharge Cost Breakdown Template and Calculator.

When Must the Objection Be Made?

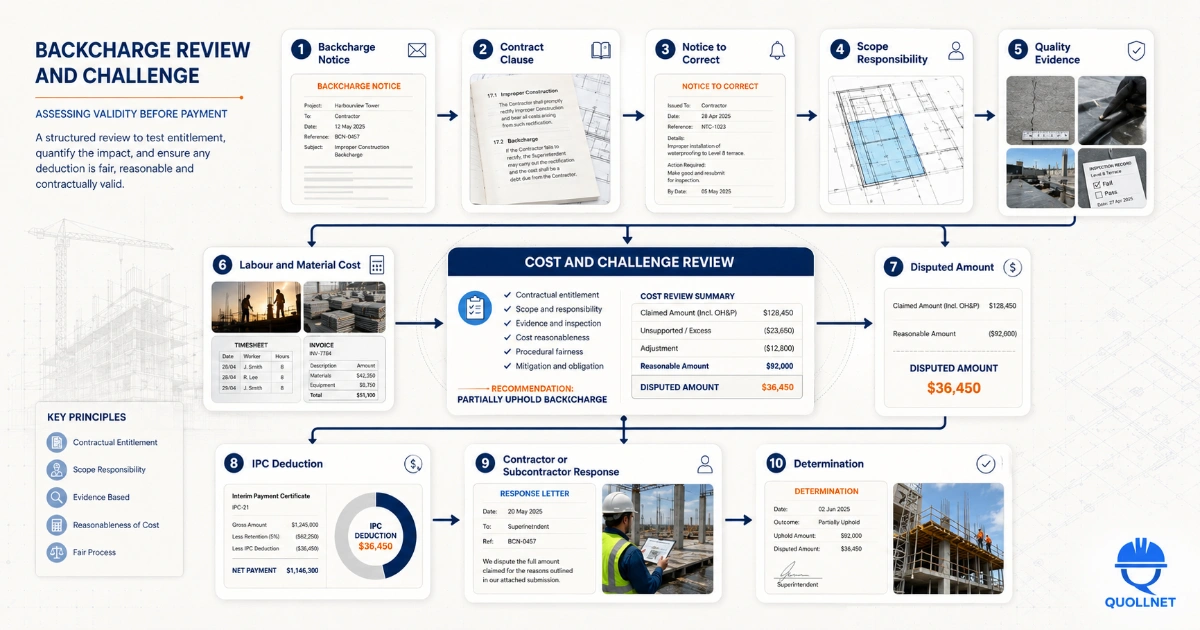

backcharge review and challange quollnet
backcharge review and challange quollnet

There is no single universal period for challenging a construction backcharge. The recipient should respond immediately and then identify every formal deadline that may apply.

These may include:

  • the response date stated in the notice;
  • the correction or cure deadline;
  • a contractual Notice of Claim period;
  • the deadline for a payment or pay-less notice;
  • the period for responding to an Engineer, Architect, Project Manager, or Contract Administrator assessment;
  • adjudication, DAAB, mediation, or arbitration procedures;
  • final-account reservation requirements;
  • statutory limitation periods.

A simple email stating “we disagree” may preserve the factual record but fail to satisfy a formal Notice of Claim. Check the notice clause, method of delivery, required recipient, reference wording, and time bar. See Timely Notices in Construction.

Do not wait for the final account where the amount is already being deducted from interim payments. Promptly object to both the underlying claim and the current payment treatment.

Right to Repair During the Defects or Correction Period

Responsibility may continue after completion during a Defects Liability Period, Defects Notification Period, correction period, or Rectification Period. Continuing responsibility does not necessarily give the Employer or Main Contractor an unrestricted right to appoint others immediately.

The Contractor or Subcontractor may object where it:

  • was not notified of the alleged defect;
  • was not given sufficient technical particulars;
  • was denied access;
  • offered to rectify the work;
  • was replaced before the applicable correction period expired;
  • was charged for betterment;
  • was charged for misuse, occupant damage, or work by another trade.

Immediate intervention may nevertheless be justified where there is a safety risk, urgent need to protect the Works, active damage, refusal to attend, repeated failed correction, or expiry of the contractual period.

The recipient should state clearly whether it is willing to inspect and correct the condition. Review the right to repair during the defects period and check whether a valid Notice to Correct was issued.

Can a Disputed Backcharge Still Be Deducted from an IPC?

Disputing a backcharge does not automatically prevent every deduction. The answer depends on the contract, the person authorised to assess or certify payment, the status of the amount, and applicable payment legislation.

A current deduction may be permitted where the amount has been:

  • agreed between the parties;
  • assessed, certified, or determined under the contract;
  • included in a valid payment calculation;
  • supported by a valid payment or pay-less notice;
  • otherwise recoverable through an express set-off provision.

The recipient may still challenge the merits even where the deduction affects the current payment. A payment notice can determine what must be paid now without finally deciding the true contractual value.

Potential payment objections include:

  • the amount was not agreed, assessed, certified, or determined;
  • the deduction was hidden by reducing measured quantities;
  • the same amount was deducted twice;
  • retention was used as though it were the backcharge;
  • the payment or pay-less notice was late;
  • the notice did not explain the calculation;
  • the deduction exceeded the amount otherwise due;
  • the remaining balance was not carried forward transparently.

Retention and a specific backcharge are separate mechanisms. See Retention in Construction and how to challenge or present a deduction in the Subcontractor IPC.

What Evidence Should Be Requested?

Request the records required to test entitlement, responsibility, procedure, causation, and valuation:

  • the executed contract or subcontract clause;
  • the instruction or Defect notification;
  • the Notice to Correct;
  • evidence of delivery;
  • photographs and marked-up drawings;
  • NCR and inspection records;
  • test results and acceptance criteria;
  • access requests and access records;
  • daily reports;
  • labour timesheets;
  • plant records;
  • material invoices;
  • third-party quotations and invoices;
  • the detailed cost calculation;
  • internal approval of the corrective work;
  • the relevant Backcharge Log entry;
  • the IPC deduction schedule;
  • the payment or pay-less notice;
  • any assessment, determination, or certification.

Ask the charging party to identify which records are estimates, commitments, invoices, paid costs, forecasts, or final amounts. These are not interchangeable.

The Construction Backcharge Log should show the original amount, previous deductions, current deduction, remaining balance, status, and dispute history.

How Should the Recipient Respond?

A practical response should separate the technical issue from contractual liability and price.

  • Acknowledge receipt without accepting liability.
  • Identify the notice and alleged amount.
  • State the contractual and factual objections.
  • Confirm whether the work will be inspected or corrected.
  • Request the supporting evidence and calculation.
  • Identify disputed scope, responsibility, quality, time, or valuation.
  • Request that disputed deductions not be applied pending the contractual assessment.
  • Reserve all contractual and legal rights.
  • Propose a joint inspection, meeting, or valuation review.

Example Response Paragraph

We acknowledge receipt of Backcharge Notice [reference] concerning [work and location]. This acknowledgement does not constitute acceptance of liability or the stated amount. We dispute the proposed backcharge because [identify scope, notice, access, responsibility, quality, causation, or valuation issue]. Please provide the contractual clause relied upon, the original instruction or defect notice, delivery evidence, photographs, timesheets, quotations, invoices, cost calculations, and the proposed payment treatment. Without prejudice to our rights, we remain available to attend a joint inspection on [date] and to discuss any corrective work properly falling within our contractual scope. We request that no disputed deduction be applied before completion of the applicable assessment and payment procedure. All contractual and legal rights are reserved.

Do not state that silence constitutes acceptance unless the contract clearly provides that result. Do not accuse the other party of fraud or malicious conduct without evidence.

Worked Examples

Example 1: Unsupported Cleanup and Delay Backcharge

A Main Contractor deducts a lump sum for “cleanup and delay” from a Subcontractor’s IPC. The notice does not identify the affected location, the waste involved, the responsible trade, a prior instruction, a cure period, labour hours, plant records, or how the alleged delay affected the programme.

The Subcontractor should challenge contractual entitlement, responsibility, notice, causation, and valuation. It should request daily reports, photographs, cleanup records, labour timesheets, plant records, the instruction requiring removal, and the programme analysis supporting delay.

It should also challenge the payment procedure if the amount was hidden within measured quantities or deducted without the required payment notice. The absence of records does not automatically prove that no cleanup was required, but it makes the lump-sum deduction difficult to substantiate.

Example 2: Liability Accepted but Amount Disputed

A Subcontractor received a valid notice concerning defective waterproofing, was given access and time to correct, but failed to mobilise. The Main Contractor appointed a specialist and incurred genuine corrective cost.

The Subcontractor may accept responsibility for reasonable repair cost while disputing replacement of compliant adjacent areas, premium materials, excessive supervision, unrelated access cost, and unsupported administrative markup.

The response should identify the accepted items, disputed items, and requested credits. It should propose a joint valuation and confirm that accepting limited liability does not mean accepting the total deduction or waiving rights concerning the payment procedure.

Conclusion

To challenge an improper construction backcharge effectively, do not focus only on whether the amount appears high. Review the contractual entitlement, instruction, notice, cure period, access, responsibility, quality requirement, causation, correction method, cost records, and payment procedure.

At the same time, do not ignore genuine defective work. A recipient can reserve its rights and dispute liability or valuation while still offering to inspect, protect, or correct work properly within its scope.

The strongest response is prompt, factual, contract-based, and supported by records. It identifies exactly what is accepted, what is disputed, what evidence is missing, and what contractual step must occur before the deduction becomes payable.

This article provides general construction contract-administration information and is not legal advice. The executed contract or subcontract, amendments, governing law, payment legislation, and project facts control. Obtain project-specific advice where the deduction is material, termination is threatened, or formal dispute proceedings are likely.


REFERENCES

FIDIC Claims Procedures

FIDIC Guidance on Claims and Contemporary Records

AIA Contract Documents: Owner’s Right to Carry Out the Work

AIA Contract Documents: Identifying and Correcting Defective Work

AIA Document A201–2017 Sample

NEC: Defining and Managing Defects in the ECC

NEC: Dealing with Uncorrected Defects under the ECS

JCT: Making Good with Rectification Periods

JCT Explains: Interim Payments and Pay Less Notices

JCT: Can You Pay Now and Argue Later?

Elie Saad's photo
Elie Saad
Jul 19, 2026
0
0
5
8

How to Challenge an Improper Construction Backcharge

Frequently Asked Questions


FAQ

Q: Can a Subcontractor dispute a backcharge?

A: Yes. A Subcontractor may dispute contractual entitlement, notice, responsibility, scope, quality, causation, access, correction method, valuation, or the payment procedure. It should respond promptly and comply with any formal notice requirements.

FAQ

Q: What parts of a backcharge can be challenged?

A: The recipient can challenge the right to engage others, notice and cure procedure, responsibility for the work, whether a defect exists, betterment, delay causation, labour and material cost, overhead, duplicate recovery, and the right to deduct the amount from payment.

FAQ

Q: Can responsibility be accepted while the price is disputed?

A: Yes. A party may accept responsibility for reasonable corrective work while disputing excessive scope, betterment, labour hours, premium rates, overhead, profit, supervision, or unsupported items.

FAQ

Q: Must the Contractor provide invoices and timesheets?

A: The exact obligation depends on the contract, but the charged party should request sufficient records to test the amount. Relevant evidence includes timesheets, plant records, material invoices, specialist quotations, invoices, daily reports, and cost calculations.

FAQ

Q: Can work be transferred before the cure period expires?

A: Normally, the applicable notice and cure procedure should be completed first. Earlier intervention may be justified by an emergency, safety risk, active damage, refusal to attend, or another express contractual right.

FAQ

Q: Can a backcharge be deducted while it is disputed?

A: Sometimes. An authorised assessment, certification, determination, set-off clause, or valid payment notice may permit a current deduction even though the recipient disputes the merits. The dispute should still be preserved through the contractual procedure.

FAQ

Q: Is an NCR enough to establish liability?

A: Not necessarily. An NCR can establish technical evidence of nonconformity, but it may not prove responsibility, satisfy the contractual notice procedure, authorise correction by others, or permit a payment deduction.

FAQ

Q: Can a Contractor charge for betterment?

A: The responsible party should not automatically bear the cost of an upgraded design, higher-grade material, expanded quantity, or additional scope. The charging party should separate the cost of restoring contractual compliance from betterment.

FAQ

Q: Can overhead and profit be included?

A: Only where the contract, subcontract, assessment mechanism, or applicable law permits them. The charging party should identify the contractual basis and calculation rather than adding a standard percentage automatically.

FAQ

Q: What happens if a payment or pay-less notice is late?

A: The payer may lose the right to reduce the notified sum in that payment cycle, depending on the contract and applicable law. The underlying corrective-cost claim may still be pursued later where permitted.

FAQ

Q: Is retention the same as a backcharge?

A: No. Retention is contractual security withheld under the payment provisions. A backcharge is an asserted recovery connected to a specific default, defect, or cost.

FAQ

Q: When must a backcharge objection be submitted?

A: There is no universal deadline. Respond immediately and check the notice response date, cure period, claim-notice requirements, payment deadlines, adjudication or dispute procedures, final-account reservations, and limitation periods.

Related Checklists


Substrate Inspection Checklist for Waterproofing
✅ 12 items
Ensuring the substrate is properly prepared and inspected is crucial before applying any waterproofing materials. This checklist guides construction professionals through a comprehensive inspection process to identify potential issues that could compromise the waterproofing application. By following this checklist, you will enhance the longevity and effectiveness of the waterproofing layer, prevent costly repairs, and ensure the structural integrity of the building. Whether you are a site manager or an inspector, these steps will help you perform a thorough evaluation of the substrate, ensuring it is ready for the next phase of construction.
Nominated Subcontractor Proposal/Instruction Review Checklist
✅ 24 items
Nominated Subcontractor Proposal/Instruction Review Checklist provides a structured, internal form for contractors to assess a proposed or instructed nomination before acceptance, conditional acceptance, or objection. This practical nomination review consolidates scope definition, programme and sequencing, commercial exposure, technical capability, and contractual protection in one place. Within the first pass, you will surface interface gaps, builder’s work in connection, temporary works responsibilities, lead times, authority approvals, and back-to-back obligations per approved project specifications and authority requirements. The checklist avoids common risks such as misaligned LD caps, inadequate insurance limits, weak pass-through of delay damages, unclear warranty terms, and unfunded advance payments. Outcomes are decision-ready, evidence-backed, and immediately distributable to project controls, procurement, and commercial leads. Use the interactive mode to tick items, add comments, attach proofs, and export to PDF/Excel with a QR-secured audit trail.
Provisional Sum Package Maturity (PCS) Gap Checklist
✅ 27 items
Provisional Sum Package Maturity (PCS Gap Analysis) Checklist enables a clear, auditable decision on whether a provisional sum package is ready for instruction, procurement, and execution. This package readiness review focuses on scope maturity, design completeness, authority approvals, interfaces, and programme integration, not on subcontractor experience or financial standing. By applying a structured PCS gap analysis, the contractor can avoid scope drift, rework, abortive procurement, late approvals, and programme resequencing. The checklist demands evidence-based confirmation of IFC drawings, coordinated specifications, defined performance requirements, identified temporary works, and clear design responsibilities. It also validates that approval paths are known, submissions are tracked, and timelines align with the baseline programme logic. Commercial clarity is captured through measurable scope, stated assumptions, testing obligations, warranties, and LD implications per approved project specifications and authority requirements. Use this tool to accept instruction, accept with reservations, request clarification, issue a notice of risk, or object to premature conversion. Tick, comment, and export to PDF/Excel with a secure QR.
Architectural Openings and Embedded Items Inspection Checklist
✅ 12 items
This checklist is designed to ensure the precise inspection of architectural openings and embedded items before a concrete pour. By following this checklist, construction professionals can verify that all necessary elements are correctly positioned and secured, which helps prevent costly errors and construction delays. This inspection process is crucial for maintaining structural integrity and ensuring that the final product meets design specifications. By adhering to these guidelines, teams can enhance the quality of the construction project while minimizing potential risks associated with improper installation.
What to Do When the Contractor Receives an NCR: Action Guide
✅ 22 items
What to do when the contractor receives an NCR is a practical, step-by-step response plan for construction teams facing a nonconformance report, non-compliance notice, or quality deviation. This checklist focuses on immediate containment, factual root cause analysis, corrective and preventive actions, and transparent closeout—without drifting into unrelated scopes. By following a structured approach, you reduce rework, avoid safety incidents, protect delivery dates, and maintain a defensible contractual position. Every step emphasizes objective evidence: calibrated measurements, annotated photos, batch numbers, inspection reports, and signatures. You will find guidance for logging, isolating affected work, coordinating hold points, and aligning with stakeholder expectations per approved project specifications and authority requirements. The result is a clear record demonstrating control of the nonconformance, verification of the fix, and prevention of recurrence. Start in interactive mode to tick items, add comments, attach files, and export your record as PDF/Excel with a QR link for quick field access.

Related Articles


Backcharge Deduction Subcontractor Ipc
⏳ 8 min read
How To Deduct a Backcharge From a Subcontractor Ipc
Learn how to show, dedu a Subcontractor IPC, with a worked payment example, balance calculation, document checklist, and practical controls.
Backcharges Under Aia A201 And A401 Correction Costs Notice
⏳ 16 min read
Backcharges Under Aia A201 And A401: Correction Costs, Notice, And Payment Withholding
AIA backcharges explained under A201–2017 and A401–2017, including correction by others, notice and cure requirements, Architect certification, payment withholding, Claims, termination, cost evidence, and Contractor or Subcontractor objections.
Construction Backcharge Log Template Ipc Deductions
⏳ 6 min read
Backcharge Log Template - Excel, Pdf Free Downlaod
Use this construction Backcharge Log template to track notices, cure periods, approved costs, disputes, Subcontractor IPC deductions, remaining balances, reversals, and closure without duplicating deductions.
Backcharges Construction Contracts
⏳ 23 min read
Backcharges In Construction Contracts: Notices, Cost Recovery, And Payment Deductions
Backcharges in construction contracts explained: notice and cure procedures, correction by others, cost evidence, IPC deductions, disputes, defects periods, and how FIDIC, AIA, NEC, and JCT address construction cost recovery.
Backcharge Notice Template Construction Subcontractor
⏳ 6 min read
Backcharge Notice Template For Construction Subcontractors
Download two construction backcharge notice templates in Excel and PDF: a Notice to Correct and Intent to Backcharge issued before corrective work, and a Final Backcharge Cost Notice issued after costs are incurred.
