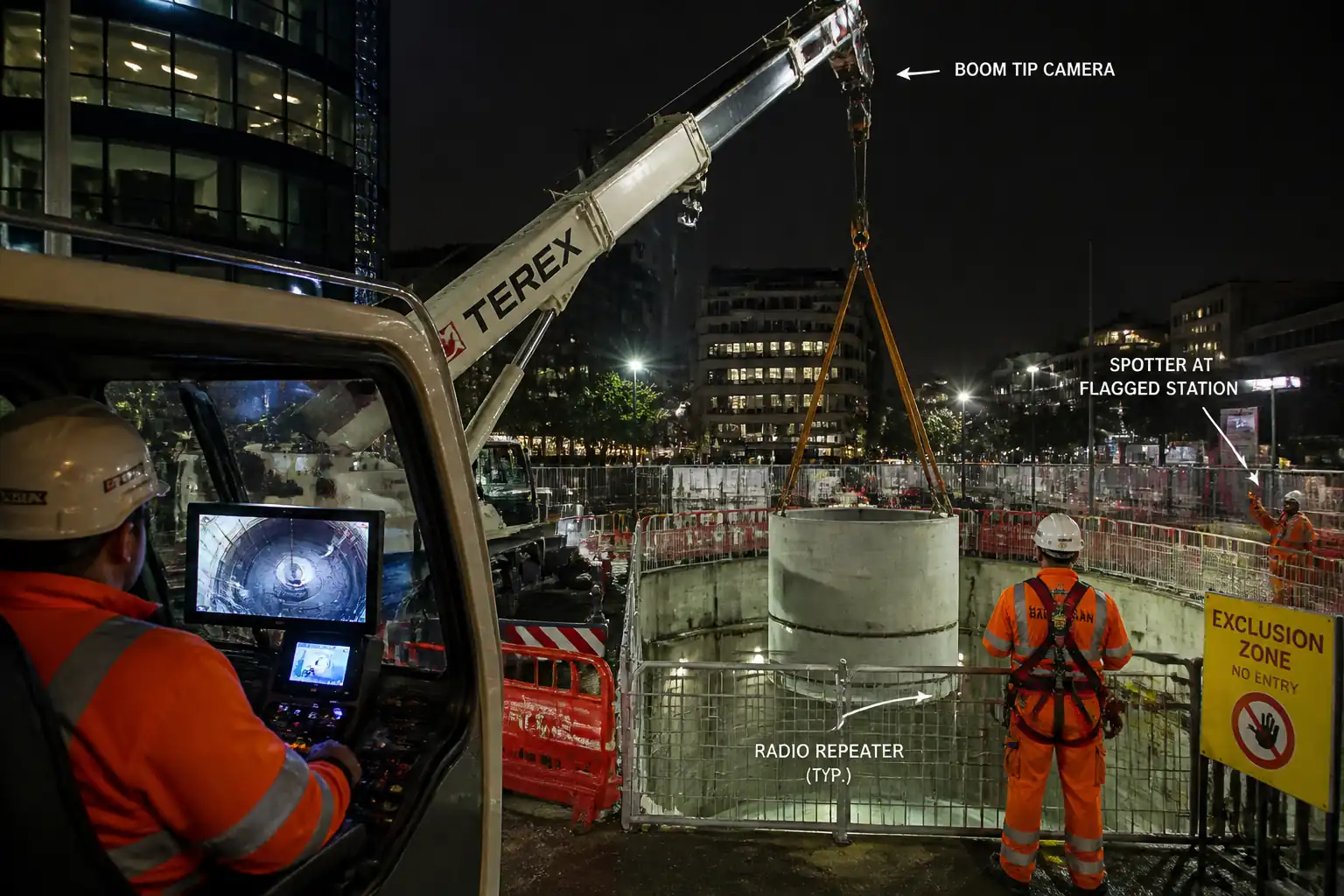

Method Statement: Blind Lifting Operations into Deep Shafts or Building Interiors – Method Statement
Method Statement: Blind Lifting Operations into Deep Shafts or Building Interiors method statement and inspection test plan example.

Method Statement: Blind Lifting Operations into Deep Shafts or Building Interiors – Method Statement

AI-assisted method statement with matching ITP, PDF download, and Excel export.

Published 09 Oct 2026 Rev. 00 2 views
About this method statement: This method statement details safe execution of blind lifting into shafts or interiors. It covers radio repeater systems, boom-tip camera calibration, spotter flag stations, tag line handling, and anti-collision monitoring with a full ITP.

More than a static template

Unlike a downloadable Word or PDF template, this method statement is an AI-assisted editable starting point connected directly to a matching Inspection and Test Plan. Every section is structured, project-adaptable, and ready to export.

  • AI-assisted drafting — Customize every section with AI for your specific project scope.
  • Linked ITP — A matching inspection and test plan is generated alongside the method statement.
  • Multiple export formats — Download as a formatted PDF or editable Excel spreadsheet.
  • Editable starting point, not a final document — Review, verify, and adjust all content against your project requirements before use.

Static template vs. Quollnet workflow

FeatureStatic templateQuollnet
Project-specific contentManual fill-in requiredAI-assisted customization
Linked ITPSeparate document, no linkMatching ITP included
Export formatsUsually PDF onlyPDF and Excel
Structured sectionsFree-form layout13 standardized sections
Saved to your accountLocal file onlyCloud-saved, reusable
Content accuracyYou verify everythingAI-assisted, you still verify
CostOften free but time-intensiveFree to customize and download

What you can customize

When you save this method statement to your account, every section becomes editable. The following 13 sections are included:

  • Scope — Defines the activity and its boundaries.
  • References — Standards, specifications, and drawings.
  • Responsibilities — Roles and accountabilities.
  • Resources — Labour, plant, and equipment summary.
  • Materials — Materials and compliance requirements.
  • Equipment — Tools and equipment details.
  • Prerequisites — Hold points and pre-conditions.
  • Method sequence — Step-by-step construction sequence.
  • Safety controls — HSE risk controls and PPE.
  • Environmental controls — Environmental mitigation measures.
  • QA/QC — Quality inspection and test requirements.
  • ITP — Inspection and Test Plan table (has its own page).
  • Attachments — Referenced drawings and documentation.

Why this method statement is used

This method statement is used to define and communicate the approved procedure for carrying out method statement: blind lifting operations into deep shafts or building interiors on site. It ensures the work is planned in advance, the correct resources and controls are in place, and all personnel understand responsibilities, sequence, quality requirements, and safety controls before work begins. It aligns site execution with the documented scope and acceptance expectations.

Who uses this method statement

This method statement is used by contractors, site supervisors, project engineers, QA/QC engineers, HSE officers, consultants, and client representatives. It serves as a shared reference for planning, execution, supervision, inspection, and approval of the activity on site.

When it is prepared and submitted

The method statement is prepared before the work activity starts and submitted as part of the pre-construction documentation package for review and approval.

Who reviews or approves it

The method statement is usually submitted to the client representative, consultant, resident engineer, or project management consultant for review and approval before the work commences.

Important approval note

This method statement is an AI-assisted editable starting point, not a pre-approved document. Before use on any project, all content must be reviewed and approved by the relevant parties (superintendent, principal contractor, or client representative) in accordance with your contract and project quality plan.

For example: if your specification requires a departure from a referenced standard, that departure must be documented and approved separately — this method statement will not capture that automatically. Always verify against your applicable drawings, specifications, and regulatory requirements.

Method statement content

Scope

Purpose

Provide a complete method to plan and execute blind lifting operations into deep shafts or building interiors where direct line-of-sight between crane operator and load is obstructed. Includes design and use of multi-stage radio signaling repeaters, crane boom-tip video camera installation and calibration, secondary spotter flag stations, tag line handling, and crane operator anti-collision monitoring.

Work Included

  • Engineering lift planning, risk assessment, and permits.
  • Crane setup, ground bearing arrangements, and exclusion zones.
  • Rigging selection and inspection.
  • Deployment and testing of multi-stage radio communication repeaters for signal relay into shafts/interiors.
  • Installation and calibration of crane boom-tip video camera and operator cab monitor.
  • Establishment of primary signaller and secondary spotter flag stations.
  • Tag line preparation and handling rules for controlled rotation and orientation.
  • Anti-collision system configuration and monitoring (A2B, LMI, virtual walls, zoning).
  • Trial lift, controlled blind lift execution, landing, and de-rigging.

Out of Scope

  • Structural modification of shafts or permanent works (to be provided by Temporary Works Designer where required).
  • Electrical isolation/relocation of live services outside the lift zone.

Interfaces

  • Temporary Works for shaft edge protection and lifting points [Verify per project specifications].
  • Traffic management and logistics for delivery/egress.
  • Confined space protocols if personnel enter shaft/interior [Verify per project HSE plan and local regulations].

References

Document TypeReference / NumberRevisionNotes
Standard BS 7121-1
Standard BS 7121-3
Standard BS 7121-5
Standard ISO 12480-1
Standard ISO 9927
Standard ISO 4309
Standard ASME B30.5
Standard ASME B30.3
Standard ASME B30.9 / B30.26
Standard EN 13000+A1
Regulation OSHA 1926 Subpart CC [Verify per jurisdiction]

Responsibilities

RoleResponsibilityName / Party
Client Representative Review/Approval Client
PC/PM Management Principal Contractor
AP Engineering and Planning Contractor
Supervisor Supervision Contractor
Operator Operation Contractor/Subcontractor
Slinger/Signaller Rigging/Signalling Contractor
Spotter Spotting/Relaying Contractor
RF Technician Comms Setup Specialist Vendor/Contractor
Technician Camera Setup Specialist Vendor/Contractor
HSE HSE Oversight Principal Contractor
TWC/TWD Engineering Approval Principal Contractor/Designer

Resources

Resource TypeDescriptionQuantityRemarks
Personnel Engineering calculations, lift plan, ground bearing assessment 1 Competent per BS 7121
Personnel Site control, permits, briefings 1
Personnel Operate crane and safety systems 1 Certified
Personnel Rigging, signalling, attach/detach loads 2-4
Personnel Visual relay and verification 2
Personnel Repeaters setup, testing, maintenance 1
Personnel Boom-tip camera system installation and calibration 1
Personnel Manage site access/egress 1
Personnel Immediate response 1 On shift

Materials

MaterialSpecification / GradeQuantityRemarks
Tag line UV resistant, low stretch As required No metal wire tag lines
Shackles/Swivels ASME B30.26 compliant As per rigging plan
Slings B30.9 As per lift
Edge protection As required
Comms As designed

Equipment

EquipmentCapacity / TypeQuantityInspection Required
Crane Per plan 1 Yes
Mats As required Yes
Camera kit 1 set Yes
Radios Sets as plan Yes
Anemometer 1 Yes
Load cell As required Yes
LOLER/ASME compliant As required Yes
Lights As required Yes

Prerequisites

  • Approved lift plan and risk assessment (incl. radio repeater design, camera use, anti-collision configuration, tag line rules).
  • Permits: Lifting Permit, Work at Height Permit (for spotter stations), Hot Work if any, Confined Space Permit if entry required [Verify per project HSE plan and local regulations].
  • Temporary works approvals for shaft edge protection, lifting lugs/anchors, and any platform.
  • Ground bearing verification and mat design approved.
  • Crane load chart, configuration, radius, and pick/set locations confirmed and marked.
  • Utilities clearance for crane pads and swing path; overhead power line risk assessed with exclusion distances [Verify per local law].
  • Logistics and traffic management in place; exclusion zones barricaded and signed.
  • Comms protocol agreed: channel plan, call signs, primary/backup, emergency word (“STOP”), hand signal set (as per BS 7121/ASME B30.5).
  • Emergency and rescue plan: dropped-load response, medical, recovery from shaft; rescue kit staged; first aider on shift.
  • Toolbox talk completed with all involved; competency and certification verified; fatigue management and shift length confirmed.
  • Weather forecast within limits; lighting plan approved for low-light operations.
  • Inspection of rigging, crane, LMI/A2B, anti-collision, cameras, radios; certificates current.
  • Lift trial area cleared; set-down area prepared and level.

Method Sequence

StepActivityDescriptionResponsibilityInspection / Hold Point
1 Engineering Lift Planning Define load weights, CoG, rigging arrangement, crane selection/configuration, radii, slew path, and ground bearing. Develop comms and anti-collision strategy. Appointed Person Design review
2 Pad Layout & Ground Preparation Survey pad locations; install mats/crane pads per design; verify level and bearing. Supervisor/Surveyor Pad inspection
3 Crane Assembly & Functional Checks Assemble/configure crane; verify LMI, A2B, slew/boom limiters; install anemometer. Crane Operator Pre-use inspection
4 Rigging Inspection & Staging Lay out slings, shackles, spreader; fit edge protectors; check certification. Slinger/Signaller Visual inspection
5 Boom-tip Camera Installation Mount camera at boom tip; route cables/wireless; set cab monitor and power. Camera Technician Mounting inspection
6 Camera Calibration Use target board at 3 depths/radii to align visual marker to hook. Record offsets. Camera Technician/AP Calibration witness
7 Radio Repeater Deployment Install primary and mid-shaft repeaters; fix to structure; assign channels; power/battery check. RF Technician Installation inspection
8 Secondary Spotter Flag Stations Establish two elevated stations with fall protection; confirm sightlines to hook/load zone; issue flags/paddles. Supervisor/HSE Access/edge protection check
9 Anti-collision Configuration Program LMI limits, virtual walls, height/swing/zoning; set proximity alarms; verify A2B; define no-go envelopes. AP/Operator Functional witness
10 Tag Line Preparation Attach non-conductive tag lines to load corners with swivels; brief handlers on rules. Slinger/Signaller Attachment check
11 Exclusion Zone & Signage Barricade drop/swing path; assign banksman; check lighting. Supervisor/HSE Barrier inspection
12 Pre-lift Briefing & Comms Drill Conduct toolbox talk; confirm roles, channels, call signs, STOP word, escalation; rehearse hand signals. Lifting Supervisor Attendance check
13 Trial Lift (Proof of Control) Hoist load 100–200 mm; hold; slew/boom slightly; verify rigging, camera image, comms, tag line control. Operator/Slinger Supervisor witness
14 Blind Lift Descent/Placement Proceed at controlled speed; continuous comms; spotters confirm clearances; pause at waypoints for checks. Operator/Signaller Ongoing supervision
15 Landing & Detachment Set down on prepared dunnage; neutralize load movement; detach rigging safely; retrieve tag lines. Slinger/Operator Visual check
16 Post-lift Review & Demobilization Debrief; inspect equipment; download camera footage if required; demobilize repeaters/flags; update records. Supervisor/AP Equipment inspection

Health, Safety and Environment (HSE) – Safety Controls

Key Hazards, Consequences, and Controls

1) Crane overturn due to inadequate ground bearing
- Hazard: Pad settlement or ground failure under outriggers.
- Consequence: Crane collapse, fatal injuries, asset damage.
- Engineering/Procedural Control: Geotechnical verification; engineered mats; verify allowable bearing vs. outrigger reaction; monitor settlement gauges.
- PPE: Safety boots, helmet with chin strap, gloves, hi-vis.
- Collective Measure: Exclusion zones; barriers 360° around crane swing radius.
- Inspection/Permit: Ground bearing calc approved; pad inspection signed by AP/Supervisor.

2) Suspended load striking structure in shaft/interior
- Hazard: Blind travel causing collision with walls/MEP.
- Consequence: Structural damage, dropped objects, injury.
- Engineering/Procedural Control: Boom-tip camera with calibrated overlay; secondary spotters; waypoints; anti-collision virtual walls; maintain slow hoist/slew speeds.
- PPE: Helmet with chin strap, eye protection, gloves.
- Collective Measure: Physical bumpers or softeners on sharp edges; exclusion zone below.
- Inspection/Permit: Camera calibration record; anti-collision functional test; lift permit.

3) Loss of communications (radio dropout/interference)
- Hazard: Operator cannot receive commands.
- Consequence: Uncontrolled movement, collision.
- Engineering/Procedural Control: Multi-stage repeaters; backup channel; communication heartbeat; agreed STOP word triggers immediate neutral/hold.
- PPE: Standard site PPE with hearing protection as needed.
- Collective Measure: Secondary hand/flag signals by spotters.
- Inspection/Permit: RF coverage test; batteries ≥ 80% charge; radio checks each shift; [Verify per project HSE plan and local regulations].

4) Falls from height at spotter stations/shaft rim
- Hazard: Spotters at elevated edges.
- Consequence: Serious injury/fatality.
- Engineering/Procedural Control: Guardrails, toe-boards; fixed anchor points; fall arrest if within fall risk zone; secure access.
- PPE: Full body harness with lanyard where required; helmet with chin strap.
- Collective Measure: Engineered edge protection to TWD; rescue plan and equipment staged.
- Inspection/Permit: Work at Height permit; weekly inspection of protection.

5) Dropped objects from load/rigging
- Hazard: Loose items fall into shaft.
- Consequence: Injury to personnel below; equipment damage.
- Engineering/Procedural Control: Positive securing of accessories; pre-lift check of loose parts; use tool lanyards.
- PPE: Helmet with chin strap, safety footwear.
- Collective Measure: Exclusion zone; debris nets where feasible.
- Inspection/Permit: Rigging checklists; spotter confirmation of clear zone.

6) Electrical contact/induced voltage
- Hazard: Proximity to overhead lines or energized plant; conductive tag lines.
- Consequence: Electrocution.
- Engineering/Procedural Control: Non-conductive tag lines; maintain statutory clearances; isolate/de-energize where possible.
- PPE: Dielectric gloves only if required by task SOP; otherwise standard PPE.
- Collective Measure: Barriers and look-up signage.
- Inspection/Permit: Powerline risk assessment and permit; [Verify per local regulations].

7) Wind and weather effects
- Hazard: Sway/rotation of suspended load.
- Consequence: Impact with structure; loss of control.
- Engineering/Procedural Control: Operational wind limits per lift plan; anemometer at boom tip or crane sensor; postpone if gusts exceed limits.
- PPE: Weather-appropriate PPE.
- Collective Measure: Additional tag line handlers or orientation control frame.
- Inspection/Permit: Weather log and threshold approval.

8) Pinch/crush during attach/detach
- Hazard: Hands between load and structure while positioning.
- Consequence: Crush injuries.
- Engineering/Procedural Control: “Hands clear” rule; use push sticks; land load fully before detaching.
- PPE: Cut-resistant gloves; eye protection.
- Collective Measure: Supervisor control of detach sequence.
- Inspection/Permit: Toolbox talk; observation audits.

9) Noise and communication clarity
- Hazard: High background noise masks commands.
- Consequence: Miscommunication.
- Engineering/Procedural Control: Noise-cancelling headsets; standardized phraseology; repeat-back protocol.
- PPE: Hearing protection where levels > 80 dB(A) [Verify].
- Collective Measure: Quiet zone near signaller where practicable.
- Inspection/Permit: Comms check before each lift.

10) Confined space atmosphere (if entry occurs)
- Hazard: Hazardous gases, low oxygen.
- Consequence: Asphyxiation, poisoning.
- Engineering/Procedural Control: Gas testing; ventilation; entry permits; standby rescue.
- PPE: As per gas test; harness for retrieval.
- Collective Measure: Rescue tripod/winch.
- Inspection/Permit: Confined Space Permit; calibrated gas monitor.

11) RF exposure or equipment failure
- Hazard: Improperly mounted repeaters, battery fires.
- Consequence: Burns, equipment drop.
- Engineering/Procedural Control: Mount repeaters to rated points; secure lanyards; battery management; no hot charging on edge.
- PPE: Gloves, eye protection.
- Collective Measure: Fire extinguisher nearby (CO2/dry powder).
- Inspection/Permit: RF technician inspection; PAT where applicable.

Environmental Controls

  • Noise: Schedule lifts in permitted hours; use noise-reducing mats; engine at low RPM where safe; monitor dB(A) near receptors.
  • Air/Emissions: Avoid idling; maintain crane per OEM; use low-sulfur fuel or electric options where available.
  • Spills: Drip trays under hydraulic connections; spill kits at crane and near shaft rim; brief response procedure.
  • Waste: Collect packaging from rigging/camera/repeaters; segregate for recycling; dispose batteries per hazardous waste rules.
  • Lighting: Orient lights to minimize glare and spill to neighbors; use shields.
  • Dust: If shaft generates dust, deploy local extraction or misting; cover openings when not in use.
  • Wildlife/Community: Control light/noise near sensitive receptors; notify stakeholders before night works.
  • RF Compliance: Operate radios within licensed bands; avoid interference with site systems; maintain log of channels used. [Verify per project HSE plan and local regulations].

QA/QC Requirements

  • Certifications: Crane (annual/periodic per ISO 9927/BS 7121), rigging gear (ASME B30.9/30.26), spreaders/frames, load cells (≤12 months calibration) [Verify per project].
  • Pre-use Inspections: Daily crane checklist; rigging visual; tag lines integrity; camera mounts; radios and batteries; anti-collision self-test.
  • Calibration & Tests:
  • Boom-tip camera: 3-point calibration at representative depths with recorded offsets; acceptable error ≤ ±50 mm [Verify].
  • Radio repeaters: Coverage and latency test; intelligibility ≥ 95%; dropout <1 s; recorded map.
  • Anti-collision: Functional test of virtual walls and A2B; retain screenshots/parameters.
  • Weather & Wind: Record wind during lift; suspend at threshold exceedance.
  • Trial Lift: 100–200 mm hover; confirm rigging angles, load readings within ±5% of plan [Verify].
  • Records & Traceability: Maintain Lift Plan, TBT, permits, inspection sheets, calibration records, RF logs, anti-collision setup sheet, crane data logger if available.
  • Nonconformance: Stop-work on defects; record NCR, corrective action; re-test before resuming.

Attachments

  • Lift Plan and Calculations (with radii, load path, load chart extracts)
  • Ground Bearing Calculations and Pad Layout Drawing
  • Rigging Arrangement Drawing and Rigging Gear Certificates
  • Crane Certification (annual), Daily Checklists
  • Anti-collision/LMI Configuration Sheet and Screenshots
  • Boom-tip Camera Installation Photos and Calibration Sheet
  • Radio Repeater Layout, Channel Plan, RF Coverage Map, Test Logs
  • Edge Protection/Temporary Works Approvals and Inspections
  • Permits: Lifting, Work at Height, Confined Space (if applicable), Hot Work (if applicable)
  • Toolbox Talk Attendance, Competency/Cert Records
  • Weather Logs, Anemometer Readings
  • Post-lift Debrief and NCR/Corrective Actions (if any)

This content is a read-only public reference. Download or customize to get an editable version.

ITP preview

The first inspection activities from the linked ITP for Method Statement: Blind Lifting Operations into Deep Shafts or Building Interiors:

ActivityInspection / TestAcceptance CriteriaResponsibilityRecord
Lift Plan and Risk Assessment ApprovalDocument review and sign-offApproved plan with calculations and drawingsAppointed Person / Client RepApproved Lift Plan, RA/MS
Ground Bearing & Pad InstallationLevel survey; bearing verification/plate test if requiredLevel within ±10 mm; allowable bearing ≥ designAP / SupervisorPad Inspection Report
Crane Certification & Pre-use CheckVisual and functional tests per OEMNo defects; certificates validCrane Operator / HSEDaily Checklist, Certs

Showing 3 of 14 inspection activities. View full ITP →

Related Inspection and Test Plan

An Inspection and Test Plan (ITP) is available for Method Statement: Blind Lifting Operations into Deep Shafts or Building Interiors. The ITP defines the inspection activities, acceptance criteria, hold and witness points, responsible parties, and records required to verify the work described in this method statement.

View the Method Statement: Blind Lifting Operations into Deep Shafts or Building Interiors ITP →

Frequently asked questions

Use limits defined in the lift plan and crane manual. Typical operational limit is ≤ 10 m/s for general lifts, lower for large surface area loads. [Verify per project specifications].

Position a target at multiple depths/radii, align the visual marker to the hook center, and record residual error. Acceptable error typically ≤ ±50 mm. Recheck if boom angle/configuration changes.

Coverage must provide ≥ 95% intelligible communications in the shaft/interior with no dropouts > 1 s during a 3-minute test, and PTT latency ≤ 300 ms. [Verify per project specifications].

Yes. Secondary spotter flag stations provide redundancy and verification, especially during radio loss or video latency, aligning with best practice and BS 7121 principles.

Before each blind lift or configuration change, perform a 100–200 mm hover to confirm rigging integrity, communications, camera image, and control effectiveness.

Related resources
