G
Guest

Method Statement: Nighttime Asphalt Paving Operations for Highway Rehabilitation inspection and test plan example.

Inspection and Test Plan for Method Statement: Nighttime Asphalt Paving Operations for Highway Rehabilitation

AI-assisted inspection and test plan connected to a method statement, with PDF and Excel export.

Published 18 Jun 2026 Rev. 00 1 views
About this ITP: This ITP defines inspections, tests, and records for nighttime asphalt paving, covering lighting verification, traffic control, paving/compaction, and materials QC.

More than a static template

Unlike a downloadable Word or PDF template, this ITP is an AI-assisted editable starting point directly connected to its method statement. Every inspection activity, hold point, and acceptance criterion is structured and ready to adapt to your project.

  • AI-assisted customization — Tailor inspection activities and acceptance criteria to your specific project scope.
  • Linked method statement — This ITP is connected to the corresponding method statement describing the work sequence.
  • Multiple export formats — Download as a formatted PDF or editable Excel spreadsheet.
  • Editable starting point, not a final document — Review and verify all content against your project specifications and standards before use.

What you can customize

When you save this ITP to your account, every inspection row becomes editable. You can add, remove, or modify:

  • Inspection activity — Description of what is being inspected.
  • Inspection type — Hold point (H), Witness point (W), Review (R), or Monitor (M).
  • Responsibility — Contractor, subcontractor, engineer, or client.
  • Frequency — How often the inspection occurs.
  • Acceptance criteria — Referenced standard or specification requirement.
  • Records — Forms, test reports, or checklists required as evidence.

Why this ITP is used

To ensure each activity in night paving meets safety, quality, and permit requirements through planned inspections and tests.

Who uses this inspection and test plan

Contractor’s QC team, Site Engineer, HSE Officer, Traffic Management Supervisor, and the Engineer/Client Representative.

When this ITP is prepared and submitted

Before, during, and after each night shift of paving to control quality and safety at hold and witness points.

Who receives or approves this ITP

Engineer/Client Representative per contract.

Inspection scope

Pre-start permits and lighting checks, surface/tack verification, mix temperatures, paving/compaction controls, joint quality, density, thickness, and smoothness.

Typical hold, witness, and review points

Hold: Lighting verification; First sub-lot compaction pattern; Opening to traffic. Witness: Tack coat application; Paver setup trial strip.

Typical inspection records

ITP checklist, temperature and lux logs, compaction and density records, lab test reports, delivery tickets, photos, and approvals.

Important approval note

This ITP is an AI-assisted editable starting point, not a pre-approved document. Before use on any project, all inspection activities, hold points, and acceptance criteria must be reviewed and approved by the relevant parties (superintendent, principal contractor, or client representative) in accordance with your contract and project quality plan.

Always verify acceptance criteria against your applicable drawings, specifications, and regulatory requirements. Hold points must be confirmed with the relevant authority before work proceeds past that point.

Inspection and test plan

Activity Inspection / Test Acceptance Criteria Responsibility Record
Pre-start approvals and permits Verify approved MS/ITP, TTM plan, night work permit, lighting plan All approvals in place; permit conditions embedded in shift plan PM / TMS / HSE Permit pack; pre-start checklist

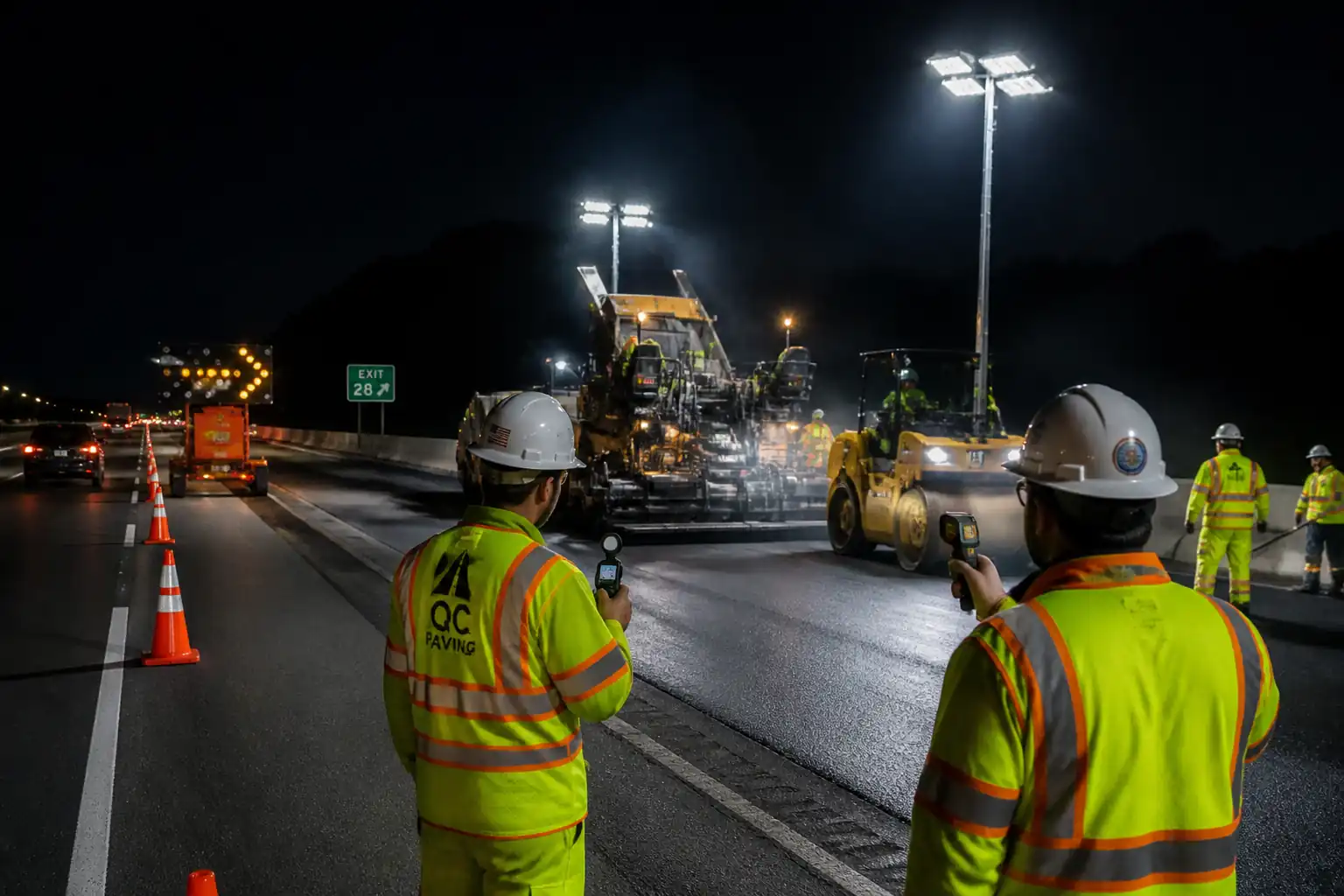

Lighting setup and verification (Hold) Lux measurements at task, roller, and general zones; glare check from traffic view Task 100–150 lux; roller 50–100 lux; general 20–50 lux; uniformity ≤10:1; no direct glare [Verify] Lighting Tech / HSE / Engineer Lighting verification log; photos
Surface condition Cleanliness/dryness check; repairs complete Clean, dry, sound; temperature ≥ minimum per spec Site Engineer / Foreman Prep checklist
Tack coat application (Witness) Tray test for residual rate; break check Residual binder 0.25–0.45 kg/m² (milled) [Verify]; fully broken before paving Foreman / QC Spray log; tray test sheet
Asphalt delivery temperature Probe temperature at truck center and quarter points Arrival ≥135°C HMA (typ.); WMA per TDS [Verify] QC / Foreman Temperature log; tickets
Paver setup and initial 30 m (Witness) Layer thickness and crossfall checks; screed settings Thickness −5/+10 mm; crossfall ±0.3%; grade within tolerance [Verify] Engineer / Site Engineer Setup sheet; survey record
Thermal profiling IR camera scan immediately behind screed Thermal differential ≤10–15°C across mat [Verify] QC Thermal map
Compaction (Hold for first sub-lot) Establish/verify roller pattern; density gauge readings Achieve target density (e.g., ≥94% of Gmm) on trial locations before release [Verify] QC / Engineer / Roller Ops Compaction log; gauge correlation sheet
Longitudinal joint quality Joint straightness and density (cores/gauge) Straightness ≤10 mm in 3 m; joint density within 1–2% of mat [Verify] QC / Foreman Joint inspection form; test results
Materials compliance Binder content (ignition); gradation (sieve); Gmm; Gmb of cores; air voids Within JMF tolerance bands [Verify] QC Lab Lab test reports; lot summary
Thickness and smoothness Core thickness; 3 m straightedge Thickness −5/+10 mm; smoothness ≤6 mm in 3 m [Verify] Surveyor / QC Core logs; straightedge records
Opening to traffic (Hold) Final inspection; temperature of surface; TTM changeover sequence Surface ≤60°C; clean; no loose material; approvals granted CM / Engineer / TMS Opening authorization; photos

This table is a read-only public reference. Download the PDF or Excel version, or customize this ITP to edit it for your project.
