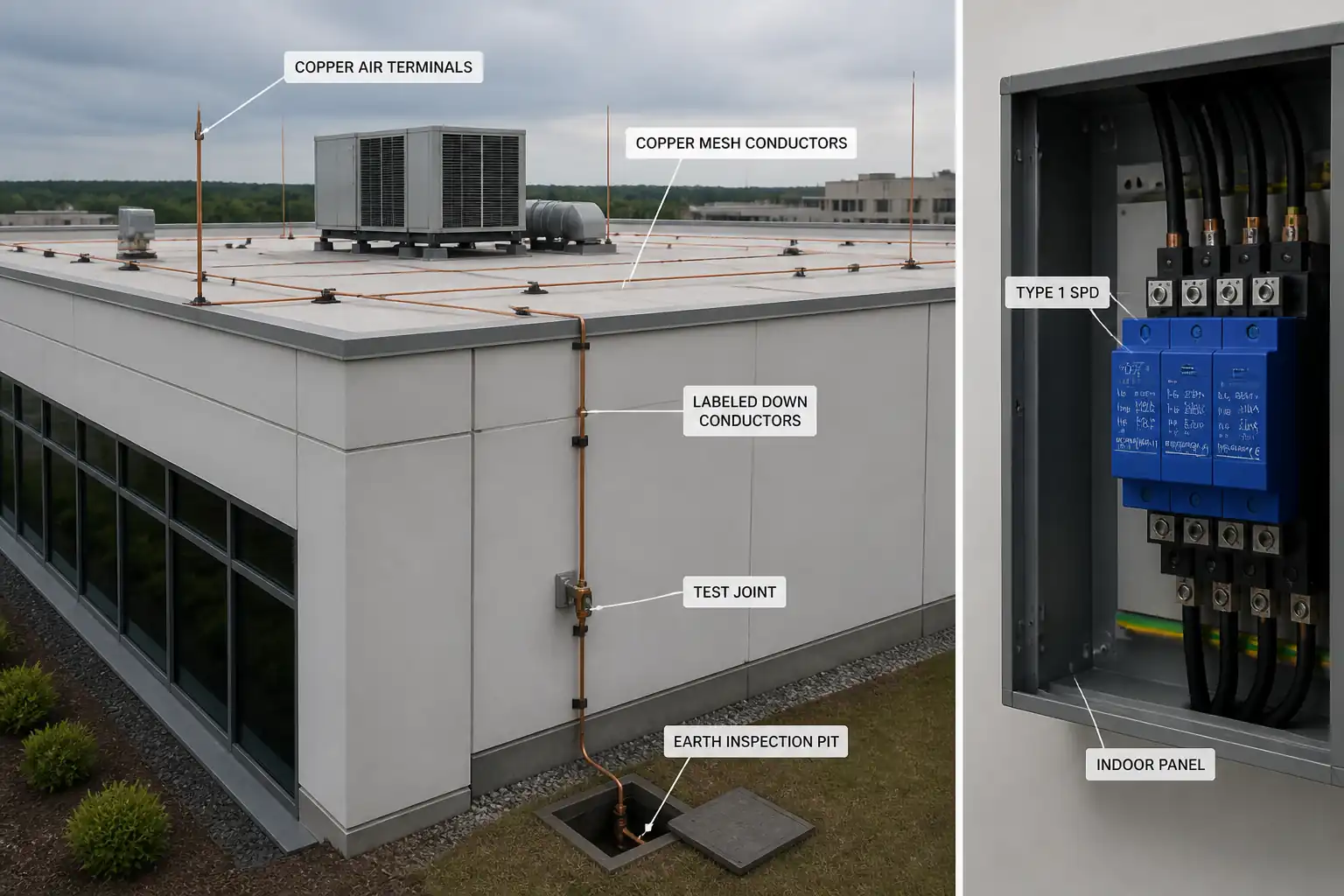

Method Statement – Lightning Protection System (LPS) Installation, Bonding, Surge Protection, and Testing inspection and test plan example.

Inspection and Test Plan for Method Statement – Lightning Protection System (LPS) Installation, Bonding, Surge Protection, and Testing

AI-assisted inspection and test plan connected to a method statement, with PDF and Excel export.

Published 02 Sep 2026 Rev. 00 266 views 96 downloads
About this ITP: This ITP defines inspections, tests, and records for LPS installation: earthing, air terminals, down conductors, bonding, SPDs, and final testing with hold points.

More than a static template

Unlike a downloadable Word or PDF template, this ITP is an AI-assisted editable starting point directly connected to its method statement. Every inspection activity, hold point, and acceptance criterion is structured and ready to adapt to your project.

  • AI-assisted customization — Tailor inspection activities and acceptance criteria to your specific project scope.
  • Linked method statement — This ITP is connected to the corresponding method statement describing the work sequence.
  • Multiple export formats — Download as a formatted PDF or editable Excel spreadsheet.
  • Editable starting point, not a final document — Review and verify all content against your project specifications and standards before use.

What you can customize

When you save this ITP to your account, every inspection row becomes editable. You can add, remove, or modify:

  • Inspection activity — Description of what is being inspected.
  • Inspection type — Hold point (H), Witness point (W), Review (R), or Monitor (M).
  • Responsibility — Contractor, subcontractor, engineer, or client.
  • Frequency — How often the inspection occurs.
  • Acceptance criteria — Referenced standard or specification requirement.
  • Records — Forms, test reports, or checklists required as evidence.

Why this ITP is used

To control quality and verification of LPS installation against standards and project specifications with defined hold/witness points.

Who uses this inspection and test plan

Contractor QA/QC, Site Engineers, HSE staff, third-party testers, and the Engineer/Client for inspections and approvals.

When this ITP is prepared and submitted

From material receipt through installation, pre-closure checks, final testing, and handover.

Who receives or approves this ITP

Engineer/Client Representative

Inspection scope

Materials verification, geometry and routing checks, joint integrity, SPD compliance, continuity and earth resistance testing.

Typical hold, witness, and review points

Hold: pre-closure of test links; final connectivity/impedance test. Witness: earth electrode installation, initial and final earth resistance, routing and coverage checks.

Typical inspection records

Material inspection reports, ITRs, joint logs, continuity and earth resistance test reports, SPD checklists, as-built drawings, calibration certificates.

Important approval note

This ITP is an AI-assisted editable starting point, not a pre-approved document. Before use on any project, all inspection activities, hold points, and acceptance criteria must be reviewed and approved by the relevant parties (superintendent, principal contractor, or client representative) in accordance with your contract and project quality plan.

Always verify acceptance criteria against your applicable drawings, specifications, and regulatory requirements. Hold points must be confirmed with the relevant authority before work proceeds past that point.

Inspection and test plan

Activity Inspection / Test Acceptance Criteria Responsibility Record
Material receiving and verification Check standards compliance (IEC/EN 62561, 61643-11); dimensions; finish Materials match approved submittals; no damage/corrosion QA/QC + Engineer Material inspection report
Set-out and separation distance check Measure offsets and proximity to metalwork Separation distance s achieved or intentional bonding details shown Site Engineer + LPS Specialist Setting-out sheet
Earth electrodes and ring installation Depth/spacing; joint methods Depth 0.6–0.8 m; spacing per design; correct joints LPS Specialist / QA/QC ITR – Earthing
Exothermic/mechanical joints Visual + sample resistance check Sound joint; resistance ≤0.1 Ω [Benchmark – Verify] QA/QC Joint log
Initial earth resistance (per electrode/system) 3-point fall-of-potential ≤10 Ω electrode typical; as specified [Verify] Tester + QA/QC Earth test report
Air terminals installation Geometry vs. rolling sphere/mesh Full coverage per class I–IV design LPS Specialist + QA/QC Air terminal ITR
Down conductors and test points Continuity 200 mA; bend radius; spacing Radii ≥8× thickness; spacing per design; test joints at 1.5–1.8 m AGL LPS Specialist + QA/QC Down conductor ITR
Equipotential bonding (services/steel) Continuity 200 mA; visual Resistance at joint ≤0.05 Ω [Benchmark – Verify]; correct clamps/materials Electrician + QA/QC Bonding ITR
SPD installation Ratings (Uc, In/Imax, Up), polarity, lead length ≤0.5 m total where practicable, OCPD/back-up Matches schedule and vendor data; indicators OK Electrician + QA/QC SPD checklist
Pre-closure inspection of test links Visual + sample resistance All remedials closed; authorization to proceed QA/QC + Engineer/Client Hold point release
Final connectivity and impedance test Continuity per path; optional DLRO 10 A on main bonds [Verify] Continuity confirmed; resistance consistent with design; joints ≤0.1 Ω [Benchmark – Verify] QA/QC + Third-Party (if specified) Final continuity/impedance report
Final overall earth resistance 3-point test; clamp-on verification if applicable Within project target (e.g., ≤1–5 Ω) [Verify] Tester + QA/QC Final earth test report
Documentation and handover N/A All ITRs, test certificates, as-builts complete PM/QA Handover file

This table is a read-only public reference. Download the PDF or Excel version, or customize this ITP to edit it for your project.

Frequently asked questions

Clamp-on methods are suitable only when multiple parallel grounding paths exist. The 3-point fall-of-potential test remains the primary method per IEEE Std 81.

Each path must be continuous from air terminal to earth with resistance consistent with the conductor length and CSA; joint resistance should be minimal (benchmark ≤0.1 Ω, verify with project).
