Method Statement – Horizontal Data Cabling Installation (Office Floors) inspection and test plan example.

Inspection and Test Plan for Method Statement – Horizontal Data Cabling Installation (Office Floors)

AI-assisted inspection and test plan connected to a method statement, with PDF and Excel export.

Published 23 Jul 2026 Rev. 00 3 views
About this ITP: Comprehensive ITP defining inspections from material receipt to final handover for horizontal data cabling, with measurable acceptance criteria and records.

More than a static template

Unlike a downloadable Word or PDF template, this ITP is an AI-assisted editable starting point directly connected to its method statement. Every inspection activity, hold point, and acceptance criterion is structured and ready to adapt to your project.

  • AI-assisted customization — Tailor inspection activities and acceptance criteria to your specific project scope.
  • Linked method statement — This ITP is connected to the corresponding method statement describing the work sequence.
  • Multiple export formats — Download as a formatted PDF or editable Excel spreadsheet.
  • Editable starting point, not a final document — Review and verify all content against your project specifications and standards before use.

What you can customize

When you save this ITP to your account, every inspection row becomes editable. You can add, remove, or modify:

  • Inspection activity — Description of what is being inspected.
  • Inspection type — Hold point (H), Witness point (W), Review (R), or Monitor (M).
  • Responsibility — Contractor, subcontractor, engineer, or client.
  • Frequency — How often the inspection occurs.
  • Acceptance criteria — Referenced standard or specification requirement.
  • Records — Forms, test reports, or checklists required as evidence.

Why this ITP is used

To ensure each installation step is inspected and tested against applicable standards and project requirements before proceeding.

Who uses this inspection and test plan

Contractor site teams, QA/QC engineers, consultants/clients, and commissioning agents.

When this ITP is prepared and submitted

From material delivery through installation, testing, firestopping, documentation, and final handover.

Who receives or approves this ITP

Client/Consultant for review and approval prior to commencement.

Inspection scope

Materials verification, pathway readiness, pulling quality, terminations, labeling, firestopping, field certification testing, and documentation completeness.

Typical hold, witness, and review points

HP-1 Pre-install walkdown; HP-2 Firestopping before concealment; HP-3 As-built package before handover; WP-1 Initial cable pulls; WP-2 Patch panel termination; WP-3 Field certification testing.

Typical inspection records

MIRs, WIRs, checklists, calibration certificates, firestop logs, as-built drawings, cable schedules, native tester files, and approval transmittals.

Important approval note

This ITP is an AI-assisted editable starting point, not a pre-approved document. Before use on any project, all inspection activities, hold points, and acceptance criteria must be reviewed and approved by the relevant parties (superintendent, principal contractor, or client representative) in accordance with your contract and project quality plan.

Always verify acceptance criteria against your applicable drawings, specifications, and regulatory requirements. Hold points must be confirmed with the relevant authority before work proceeds past that point.

Inspection and test plan

Activity Inspection / Test Acceptance Criteria Responsibility Record
Material delivery and MIR Check cable drums, passive components, certificates Materials match approved submittals; damage-free; certificates available QA/QC Engineer / Consultant MIR, photos
Pre-install walkdown (HP-1) Verify routes, tray condition, fill limits, separations Routes clear; separations achievable; trays bonded; supports per spec Site Engineer / Consultant Walkdown checklist, WIR approval
Containment preparation Edge protection, bonding continuity, cleanliness No sharp edges; earth continuity verified; area clean Site Engineer / QA/QC Inspection report
Cable pulling (WP-1) Monitor tension, radii, lubricant compatibility, pathway fill No jacket damage; radii maintained; fill within limits Supervisor / Consultant WIR, photos
Outlet termination Check pinout per 568A/568B; untwist limits; service loop Correct pinout; untwist within limits; neat installation Supervisor / QA/QC In-process checklist
Patch panel termination (WP-2) Termination quality; shield continuity (if applicable); bonding Correct pinout; bonds secure; no cable weight on jacks Supervisor / Consultant WIR, photos
Labeling and administration Audit 10% sampling or as specified Identifiers per TIA-606-C; end-to-end traceability QA/QC Engineer Label register, audit sheet
Firestopping (HP-2) Verify tested system ID, annular space, tag Installed per listed system; neat, continuous seal; tagged Firestop Installer / Consultant Firestop log, WIR

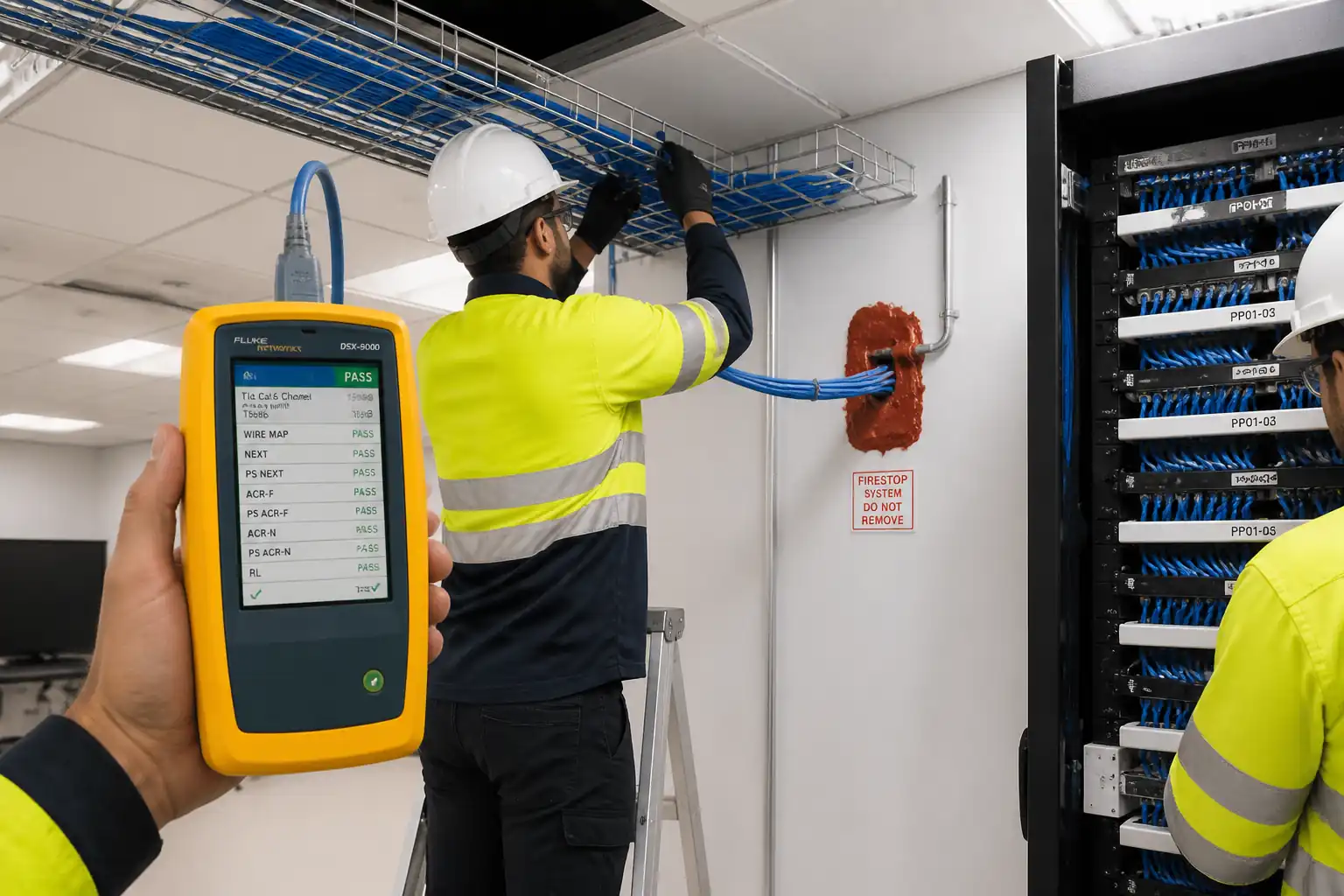

Field certification testing (WP-3) Fluke DSX PL/Channel test to TIA-568.2-D limits PASS on wiremap, length, IL, NEXT/PSNEXT, ACR-F/PSACR-F, RL, delay, skew Tester / QA/QC / Consultant Native files (.flw), PDF summary, tester calibration cert
As-built documentation (HP-3) Cross-check drawings, schedules, and test reports 100% links documented; IDs consistent; records complete QA/QC / Consultant As-built set, transmittal
Final inspection and handover Handover inspection, sample re-checks All NCRs closed; approvals obtained PM / Client Completion certificate

This table is a read-only public reference. Download the PDF or Excel version, or customize this ITP to edit it for your project.

Frequently asked questions

100% of installed links must be certified to the specified TIA limit. Sampling is not acceptable for certification.

Yes, if specified by the Employer. Channel testing includes patch cords and requires compliant test adapters and cord sets.

Contractor raises WIR before each HP/WP. Work cannot proceed beyond a Hold Point without the Consultant's approval; Witness Points require attendance invitation and documented outcome.
