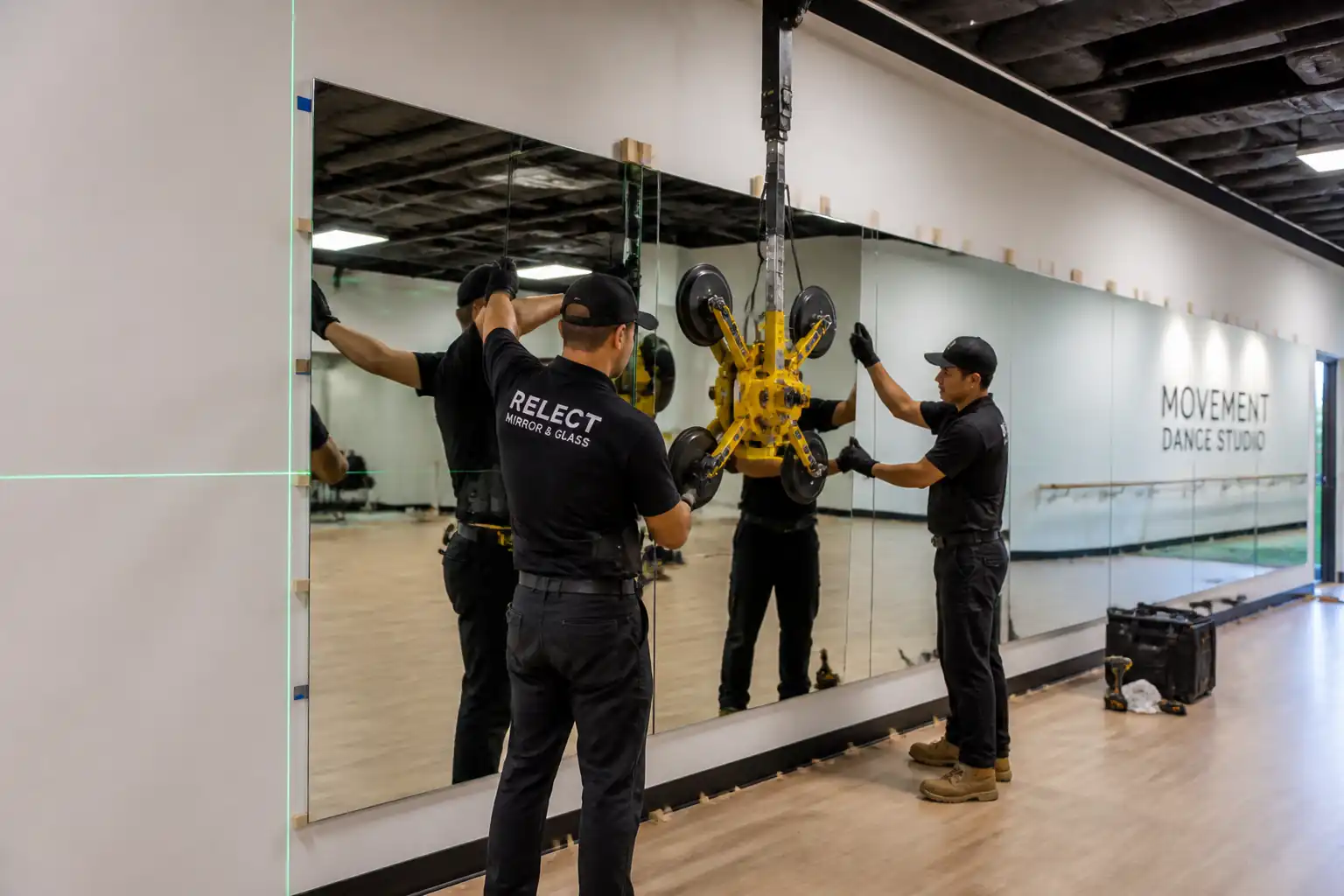

Method Statement – Installation of Large-Format Mirrored Wall Panels in Commercial Gymnasium Dance Studios – Method Statement
Method Statement – Installation of Large-Format Mirrored Wall Panels in Commercial Gymnasium Dance Studios method statement and inspection test plan example.

Method Statement – Installation of Large-Format Mirrored Wall Panels in Commercial Gymnasium Dance Studios – Method Statement

AI-assisted method statement with matching ITP, PDF download, and Excel export.

Published 03 Sep 2026 Rev. 00 331 views 96 downloads
About this method statement: This method statement details how to install large-format mirrored wall panels in gym dance studios. It covers substrate prep, safety film, adhesive combing, J-channel fixing, alignment checks, QA/QC, and a full ITP.

More than a static template

Unlike a downloadable Word or PDF template, this method statement is an AI-assisted editable starting point connected directly to a matching Inspection and Test Plan. Every section is structured, project-adaptable, and ready to export.

  • AI-assisted drafting — Customize every section with AI for your specific project scope.
  • Linked ITP — A matching inspection and test plan is generated alongside the method statement.
  • Multiple export formats — Download as a formatted PDF or editable Excel spreadsheet.
  • Editable starting point, not a final document — Review, verify, and adjust all content against your project requirements before use.

Static template vs. Quollnet workflow

FeatureStatic templateQuollnet
Project-specific contentManual fill-in requiredAI-assisted customization
Linked ITPSeparate document, no linkMatching ITP included
Export formatsUsually PDF onlyPDF and Excel
Structured sectionsFree-form layout13 standardized sections
Saved to your accountLocal file onlyCloud-saved, reusable
Content accuracyYou verify everythingAI-assisted, you still verify
CostOften free but time-intensiveFree to customize and download

What you can customize

When you save this method statement to your account, every section becomes editable. The following 13 sections are included:

  • Scope — Defines the activity and its boundaries.
  • References — Standards, specifications, and drawings.
  • Responsibilities — Roles and accountabilities.
  • Resources — Labour, plant, and equipment summary.
  • Materials — Materials and compliance requirements.
  • Equipment — Tools and equipment details.
  • Prerequisites — Hold points and pre-conditions.
  • Method sequence — Step-by-step construction sequence.
  • Safety controls — HSE risk controls and PPE.
  • Environmental controls — Environmental mitigation measures.
  • QA/QC — Quality inspection and test requirements.
  • ITP — Inspection and Test Plan table (has its own page).
  • Attachments — Referenced drawings and documentation.

Why this method statement is used

This method statement is used to define and communicate the approved procedure for carrying out method statement – installation of large-format mirrored wall panels in commercial gymnasium dance studios on site. It ensures the work is planned in advance, the correct resources and controls are in place, and all personnel understand responsibilities, sequence, quality requirements, and safety controls before work begins. It aligns site execution with the documented scope and acceptance expectations.

Who uses this method statement

This method statement is used by contractors, site supervisors, project engineers, QA/QC engineers, HSE officers, consultants, and client representatives. It serves as a shared reference for planning, execution, supervision, inspection, and approval of the activity on site.

When it is prepared and submitted

The method statement is prepared before the work activity starts and submitted as part of the pre-construction documentation package for review and approval.

Who reviews or approves it

The method statement is usually submitted to the client representative, consultant, resident engineer, or project management consultant for review and approval before the work commences.

Important approval note

This method statement is an AI-assisted editable starting point, not a pre-approved document. Before use on any project, all content must be reviewed and approved by the relevant parties (superintendent, principal contractor, or client representative) in accordance with your contract and project quality plan.

For example: if your specification requires a departure from a referenced standard, that departure must be documented and approved separately — this method statement will not capture that automatically. Always verify against your applicable drawings, specifications, and regulatory requirements.

Method statement content

Scope

Overview

This method statement covers the complete installation of large-format mirrored wall panels in commercial gymnasium dance studios, including:

  • Substrate (gypsum board/drywall) inspection, sanding/skim coating for flatness, dust control, and priming/sealing.
  • Survey, layout, and mechanical fixing of bottom support J-channels/edge trims, including setting blocks and soft liners.
  • Safety-shatter backing film application to mirror panels (where not factory laminated), edge finishing/arris, and inspection.
  • Specialized mirror-approved mastic adhesive comb application to the substrate and/or mirror back as per adhesive manufacturer, with defined coverage and thickness tolerances.
  • Controlled lifting/placement of large-format mirrors, spacer-based joint management, and alignment to achieve distortion-free reflection.
  • Perimeter/joint sealant application (mirror-safe neutral cure), cleaning, protection, and cure time management.
  • Integrated QA/QC checks, ITP hold/witness points, and safety sign-off logs for handover.

Inclusions

  • Wall surveys, flatness and plumb checks, and moisture/environmental condition verification.
  • Fixings into studs or engineered backing per approved shop drawings.
  • Optical quality checks per BS EN 1036 visual inspection guidance.
  • Safety records, daily equipment checks (vacuum lifters), and final documentation.

Exclusions

  • Structural wall framing alterations beyond minor backing verification.
  • Electrical or AV relocations concealment works (unless stated in contract).
  • Supply/installation of dance barres or other fixtures (unless noted in drawings).

Typical Extents [Verify per project specifications]

  • Mirror thickness: 6 mm silvered float mirror (tempered if required by risk assessment or local code).
  • Panel sizes: up to approx. 3.0 m high x 1.2–1.8 m wide.
  • Joint gap targets: 2–3 mm uniform.
  • Substrate flatness targets: ≤ 2 mm under a 2 m straightedge; ≤ 3 mm under 3 m.

References

Document TypeReference / NumberRevisionNotes
Standard BS EN 1036-1/-2: Glass in building — Mirrors from silver-coated float glass Optical/visual quality, dimensional tolerances, and evaluation methods for silvered mirrors.
Standard BS 6262 (series): Glazing for buildings General glazing practice and safety guidance. [Verify applicable parts per project]
Standard EN 12150-1: Thermally toughened soda lime silicate safety glass If toughened safety mirrors are specified or required by code/risk assessment.
Standard EN 12600: Glass in building — Pendulum test — Impact performance classification Safety classification for glazed elements and films; target Class 2B2 for internal mirrors [Verify].
Standard ANSI Z97.1 / CPSC 16 CFR 1201 US safety glazing standards if jurisdiction requires compliance. [Verify per local code]
Standard ASTM C1036: Standard Specification for Flat Glass Base flat glass quality reference for float substrate mirrors.
Standard ASTM C1048: Heat-Treated Flat Glass If heat-strengthened/toughened mirror glass is used or required.
Standard ASTM C840 / GA-214: Application and Finishing of Gypsum Board Drywall finishing levels and substrate tolerances for flatness/wave control.
Guideline Adhesive and Sealant Manufacturers’ TDS/SDS (Mirror-Safe) Adhesive compatibility with mirror silvering; application thickness, coverage, curing times.
HSE Project HSE Plan; Local Regulations; Permit-to-Work System Working at height, manual handling, drilling/hidden services scans, VOCs, dust, glass handling. [Verify per project HSE plan and local regulations]

Responsibilities

RoleResponsibilityName / Party
Project Manager Ensure compliance with contract documents, standards, and HSE. Main Contractor
Site Engineer / Supervisor Maintain red-line drawings, RFI management, and as-builts. Main Contractor
Glazing Subcontractor Lead Provide qualified glaziers; tools and lift plans; equipment inspections. Specialist Subcontractor
Drywall Finisher Deliver substrate to tolerance and cleanliness. Main/Subcontractor
QA/QC Engineer Issue NCRs, close-out punch list, maintain records. Main Contractor
HSE Officer Verify PPE, equipment certifications, and exclusion zones. Main Contractor
Surveyor / Setting-Out Engineer Provide survey reports and benchmarks. Main Contractor
Storekeeper Check deliveries against approvals; keep SDS on site. Main Contractor
Third-Party Inspector (if applicable) Issue reports and witness statements. Independent

Resources

Resource TypeDescriptionQuantityRemarks
Manpower Glaziers (certified) 3–6 per crew [Verify per panel size/weight] Vacuum-lifter competent persons only.
Manpower Drywall finisher(s) 1–3 Level 4+ finish capability (GA-214).
Manpower Site supervisor / engineer 1
Manpower HSE officer 1 (shared) Critical lift oversight as needed.
Manpower QA/QC engineer 1 (shared) ITP implementation and records.

Materials

MaterialSpecification / GradeQuantityRemarks
Silvered float mirror panels BS EN 1036 compliant; base float per EN 572; toughened per EN 12150 where required [Verify] Factory polished edges preferred.
Safety-shatter backing film Meets EN 12600 Class 2B2 or ANSI Z97.1 Cat II when applied [Verify] Back film sized to mirror; trimmed near edges.
Mirror mastic adhesive (comb/trowel grade) Manufacturer-certified mirror-compatible adhesive; application by 4–6 mm V-notched trowel [Verify per TDS] TDS to confirm compatibility with mirror silvering.
Perimeter/joint sealant (mirror-safe) Neutral cure silicone or approved mirror-safe sealant [Verify per TDS] Colour matched; tooling within open time.
Aluminium J-channel and trims Alloy and finish per specification; wall fixings SS A2/A4 [Verify] Powder-coated/clear anodized.
Setting blocks / soft liners (EPDM/neoprene) Shore A ~70, solvent-resistant [Verify]
Hard spacers/shims (2–3 mm) Plastic/Nylon; compressible <10% at load [Verify]
Primer/sealer for gypsum board Acrylic/PVA compatible with mirror adhesive [Verify per TDS]
Cleaning and protection materials pH-neutral glass cleaner; protection sheets/tape

Equipment

EquipmentCapacity / TypeQuantityInspection Required
Vacuum glass lifter (suction frame) ≥ 2x panel weight safety factor [Verify] Yes
A-frame glass racks and dollies Rated for panel load Yes
Rotary laser level, targets, and 2 m straightedge Calibration cert current
Stud/pipe/AC cable detector (multi-scanner) Functional check
Drills, drivers, countersink with dust extraction PAT/inspection current
Mobile scaffold/step-ups or MEWP (indoor) As required by height Tagged/inspected
V-notched trowels (4–6 mm), sealant guns Clean, undamaged
Squeegees, mist sprayers, lint-free wipes, HEPA vac Cleanliness prior to use
Diamond hand pads/glass edge tools Use guards; check condition
Thermo-hygrometer and surface moisture meter Calibration/zero check

Prerequisites

Approvals and Documentation

  • Approved shop drawings, layout elevations, details of J-channel/backing, jointing, and sealant.
  • Approved material submittals: mirrors, safety film, adhesive, sealant, trims, setting blocks, primers (include TDS/SDS).
  • Method statement and ITP approved before start.

Training and Permits

  • Toolbox talk on glass handling, vacuum lifting, pinch/crush hazards, and drilling controls.
  • Permit-to-work for drilling/penetrations and work at height [Verify per project HSE plan and local regulations].
  • Equipment certifications (vacuum lifter, scaffold/MEWP) current and logged.

Site Readiness

  • Substrate complete, services behind wall verified and marked (multi-scanner/GPR where needed) with as-built confirmation.
  • Environmental conditions: temperature 18–27°C; RH 30–65%; ventilation in place. [Verify per adhesive TDS].
  • Substrate dryness: gypsum board dry with moisture meter reading within device “drywall” safe range; no visible dampness [Record value, Verify per device manual].
  • Illumination 300–500 lux minimum for visual/optical checks.
  • Access routes clear; A-frame storage area level and protected from traffic; exclusion zones established.

Mock-up

  • Execute one full-height mirror bay mock-up (≥2 panels where feasible) demonstrating J-channel, adhesive comb, joint, sealant, and final finish for acceptance prior to full works. Retain as quality benchmark.

Materials Handling

  • Inspect mirrors on delivery for chips/scratches; store vertically on A-frames at 6–10° lean with edge protectors; segregate by size and ID tags.
  • Condition adhesives/sealants to room temperature 24 hours prior to use.

Coordination

  • Confirm sequencing with flooring/baseboard trades and any barre/AV fixtures to avoid rework. Lock-in joint lines with architectural grid/lighting for reflection alignment.

Method Sequence

StepActivityDescriptionResponsibilityInspection / Hold Point
1 Setting-out and Wall Survey Establish control lines with laser; mark mirror datum at finished floor level (FFL). Check plumb and level of walls; mark stud/backing locations. Record flatness using 2 m straightedge in orthogonal directions; note high/low spots. Site Engineer / Surveyor Yes
2 Drywall Preparation Sand/skim low/high areas to achieve target flatness; repair joints/fasteners. HEPA vacuum to remove dust. Apply compatible primer/sealer; allow to dry per TDS. Drywall Finisher Yes
3 Services Scan and Permit Scan wall with multi-scanner to locate studs, electrical/pipe services. Mark no-drill zones. Obtain permit-to-drill as applicable. Site Engineer / HSE Yes
4 Install J-Channel and Trims Cut and dry-fit J-channel; install soft liner. Fix into studs/backing with SS screws. Maintain level using laser. Install setting blocks in channel at 300–500 mm spacing. Glazing Subcontractor Yes
5 Mirror Edge Preparation Verify factory polished edges. Where permitted, lightly arris micro-chips with diamond hand pad (≤1 mm arris). Clean edges with approved solvent (no ammonia). Glazing Subcontractor Yes
6 Safety Backing Film Application (if required) On clean bench, mist-clean mirror back; apply film wet per TDS; squeegee out air/water from center to edges. Trim film to within ~2 mm of glass edge [Verify]. Allow initial cure per TDS (≥24 h) before lift. Glazing Subcontractor Yes
7 Dry-Fit and Alignment Trial Position panel without adhesive using J-channel and spacers; verify joint gaps (2–3 mm) and alignment with adjacent panels/room grid. Mark top alignment points. Glazing Subcontractor Yes
8 Adhesive Comb Application Mask perimeters. Apply mirror-approved mastic to primed substrate using 4–6 mm V-notched trowel in vertical ribbons; maintain 10–20 mm clear from mirror edges. Ensure final bed thickness ~1.5–2.5 mm and 70–85% contact after placement. Glazing Subcontractor Yes
9 Panel Lifting and Placement Pre-use check of vacuum lifter; attach to mirror (face protected). Lift panel, lower into J-channel on setting blocks; use spacers at vertical joints/top. Press uniformly to seat adhesive without over-compression. Temporary retention with tape/clips as required. Glazing Subcontractor Yes
10 Alignment and Distortion Check Verify plumb/level with laser. Conduct reflection check using vertical/horizontal grid or plumb lines at 1 m viewing distance at 90°. Adjust before adhesive set within open time. QA/QC + Glazing Subcontractor Yes
11 Curing and Supports Maintain temporary supports/tape. Protect area from impact/vibration. Observe adhesive cure time (min 24 h; full cure 48–72 h) and temperature/RH per TDS. Glazing Subcontractor Yes
12 Joint and Perimeter Sealing Remove spacers; mask edges. Apply neutral-cure mirror-safe sealant to 2–3 mm joints; tool smooth; remove masks after skinning. Glazing Subcontractor Yes
13 Cleaning and Protection Remove surface films/tapes carefully. Clean face with pH-neutral, non-ammonia cleaner and lint-free cloth. Install protective barriers/signs to prevent early use. Glazing Subcontractor Yes
14 Handover and Records Complete ITP, snag rectification, and safety glazing compliance log. Provide O&M manuals, cleaning/maintenance guidance, warranties, and as-built drawings/photos. Project Manager / QA/QC Yes

Health, Safety, and Environment – Safety Controls

Principal Task-Specific Hazards and Controls

  • Hazard: Handling large glass panels; loss of control or breakage
  • Consequence: Severe cuts/lacerations, crush injuries, panel shatter
  • Engineering/Procedural Control: Use certified vacuum lifters with pre-use checks; plan lift path and exclusion zones; minimum two trained glaziers per panel side; use A-frames and edge protectors; install temporary barriers
  • Required PPE: Cut-resistant gloves (EN 388 level appropriate), forearm guards, safety footwear with toe protection, long sleeves, eye/face protection
  • Collective Preventive Measure: Physical barriers and spotters; dedicated lifting plan; limit occupancy in zone
  • Inspection/Permit/Supervision: Daily vacuum lifter inspection log; lifting plan briefing; supervisor present during lifts

  • Hazard: Drilling into walls (J-channel fixings) with concealed services

  • Consequence: Electric shock, flooding, service damage
  • Engineering/Procedural Control: Multi-scanner/GPR prior to drilling; mark no-go zones; lock-out/tag-out if needed; use depth stops
  • Required PPE: Safety glasses, dielectric gloves as appropriate, hearing protection
  • Collective Preventive Measure: Permit-to-drill system; supervision during first-of-type
  • Inspection/Permit/Supervision: Permit-to-work; inspection of scans and sign-off by engineer/HSE

  • Hazard: Work at height (top alignments/sealant)

  • Consequence: Falls from height
  • Engineering/Procedural Control: Use inspected mobile scaffold or MEWP; 3-point contact; do not overreach; maintain guardrails/toeboards
  • Required PPE: Fall protection per equipment SOP, non-slip footwear
  • Collective Preventive Measure: Edge protection on platforms; exclusion below
  • Inspection/Permit/Supervision: Daily scaffold tag/MEWP checks; operator certification verification

  • Hazard: Adhesive/sealant VOCs and skin contact

  • Consequence: Respiratory/skin irritation, sensitization
  • Engineering/Procedural Control: Select low-VOC, mirror-safe products; provide cross-ventilation; avoid skin contact; follow SDS for handling and cure
  • Required PPE: Nitrile gloves, safety glasses; respirators if indicated by SDS
  • Collective Preventive Measure: Local ventilation; restrict area occupancy until initial cure
  • Inspection/Permit/Supervision: SDS available; HSE to verify ventilation plan [Verify per project HSE plan and local regulations]

  • Hazard: Drywall sanding dust and silica-containing residues

  • Consequence: Respiratory irritation
  • Engineering/Procedural Control: Use HEPA vac-attached sanders; wet wipe; contain area
  • Required PPE: FFP2/FFP3 or N95 respirator (as required), safety glasses
  • Collective Preventive Measure: Dust curtains/negative air if needed
  • Inspection/Permit/Supervision: HSE inspection of controls; housekeeping checks

  • Hazard: Pinch/crush between mirror and wall/channel during seating

  • Consequence: Finger/hand injuries
  • Engineering/Procedural Control: Use spacers; designated hand positions; verbal commands by lift lead
  • Required PPE: Cut-resistant gloves; knuckle protection
  • Collective Preventive Measure: Exclusion of non-essential personnel
  • Inspection/Permit/Supervision: Supervisor oversight during placement

  • Hazard: Noise/vibration from drilling and cutting

  • Consequence: Hearing damage; nuisance to occupants
  • Engineering/Procedural Control: Use low-noise drill modes, maintain bits; schedule noisy tasks off-hours
  • Required PPE: Hearing protection as needed
  • Collective Preventive Measure: Signage and barriers
  • Inspection/Permit/Supervision: HSE monitoring; compliant hours of work

  • Hazard: Glass edge finishing (hand diamond pads)

  • Consequence: Flying shards/abrasion
  • Engineering/Procedural Control: Perform only minor arris; use guards and bench with restraints; capture debris
  • Required PPE: Face shield or safety glasses, cut-resistant gloves
  • Collective Preventive Measure: Screen off workbench area
  • Inspection/Permit/Supervision: Supervisor authorization for any on-site edge work

  • Hazard: Housekeeping and trip hazards (spacers, offcuts, tapes)

  • Consequence: Slips, trips, falls
  • Engineering/Procedural Control: Clean-as-you-go; tool lanyards at height
  • Required PPE: Safety footwear
  • Collective Preventive Measure: Waste bins at point of use
  • Inspection/Permit/Supervision: Daily HSE walkdown

Note: Where exact controls depend on local law or the project HSE plan, implement and verify: [Verify per project HSE plan and local regulations].

Environmental Controls

  • VOC Management: Select low-VOC adhesives/sealants; maintain ventilation during and after application until initial cure. Keep containers closed when not in use.
  • Dust Control: Use HEPA-extracted sanding; vacuum surfaces; avoid dry sweeping. Bag and seal dust waste.
  • Waste Segregation: Segregate glass offcuts, film liners, cardboard, and plastics. Recycle where facilities exist. Dispose of adhesive/sealant waste and contaminated wipes per SDS.
  • Noise: Schedule drilling during permitted hours; use quieter tools and maintain bits to reduce noise.
  • Spill Prevention: Store adhesives/sealants on drip trays; keep spill kits nearby; clean spills immediately with approved materials.
  • Energy/Lighting: Use LED task lights; switch off equipment when idle.
  • Transport/Storage: Store mirrors indoors on level A-frames with edge protectors to prevent damage (waste). Protect from temperature extremes and moisture.
  • Nuisance Containment: Screen off work area to prevent dust migration to gym spaces; maintain good housekeeping.
  • Compliance: Follow ISO 14001-aligned project environmental plan and local waste regulations. [Verify per project specifications].

Quality Assurance and Quality Control

Controls and Measurements

  • Substrate Flatness/Plumb: Check every 2 m along wall with 2 m straightedge; record maximum deviation. Re-check after skim/prime.
  • Environmental Conditions: Record temperature/RH start/end of each shift; verify within adhesive TDS limits.
  • Adhesive Application: First-of-type inspection/approval of comb pattern; periodic checks every panel thereafter. Target: 4–6 mm V-notch; 70–85% contact; 1.5–2.5 mm bed thickness; 10–20 mm clear of edges [Verify per TDS].
  • Joint Gaps: Measure every joint at top/mid/bottom; tolerance 2–3 mm ±0.5 mm.
  • J-Channel Fixing: Verify fixings into studs/backing at ≤300 mm c/c [Verify]; level within ±1 mm over 3 m; setting blocks installed.
  • Optical Quality: BS EN 1036 visual inspection at 1 m, perpendicular view under 300–500 lux. Use reflected line/grid method; benchmark straightness deviation ≤2 mm over 2 m [Verify per project].
  • Film Application: Visual check for adhesion/defects >5 mm; record batch/lot; confirm safety classification after cure where test evidence available.
  • Curing and Support: Record cure times; do not remove supports <24 h or before achieving handling strength per TDS.
  • Sealant: Verify neutral cure (no acetoxy); adhesion and finish uniform; no contamination of mirror backing.

Records

  • ITP checklists, survey/flatness logs, adhesive/film/sealant batch records, equipment inspection logs, lift checklists, as-built drawings, photo records, NCRs/CPARs if any, and final client sign-off.

Tolerances [Verify per project specifications]

  • Flatness: ≤2 mm/2 m; ≤3 mm/3 m.
  • Plumb: ≤2 mm full height.
  • Joint width: 2–3 mm ±0.5 mm.
  • Level of J-channel: ±1 mm/3 m.
  • Panel offset between adjacent faces: ≤1 mm.

Attachments

  • Approved shop drawings and elevation layouts
  • Product data sheets (TDS) and Safety Data Sheets (SDS) for: mirrors, safety film, adhesive, sealant, primer
  • Equipment certificates: vacuum lifter, scaffold/MEWP tags, PAT where applicable
  • Pre-install survey and flatness reports
  • Mock-up approval record
  • ITP forms and completed checklists; daily lift/inspection logs
  • As-built drawings and photo records
  • Manufacturer installation guidelines and warranties
  • Safety sign-off logs and permits (drilling, work at height)

This content is a read-only public reference. Download or customize to get an editable version.

ITP preview

The first inspection activities from the linked ITP for Method Statement – Installation of Large-Format Mirrored Wall Panels in Commercial Gymnasium Dance Studios:

ActivityInspection / TestAcceptance CriteriaResponsibilityRecord
Pre-install survey and flatness check2 m straightedge mapping; plumb check with laserFlatness ≤2 mm/2 m; plumb ≤2 mm full height [Verify]Site Engineer / QA/QCSurvey report with photos and marked drawings
Substrate moisture/cleanlinessSurface moisture meter reading; visual dust-free checkWithin device 'drywall' safe range; surface sealed/cleanQA/QCSubstrate moisture/cleanliness checklist
Services scan and permitMulti-scanner/GPR; permit-to-drill verificationServices mapped; permit approved prior to drillingSite Engineer / HSEScan output; permit-to-work form

Showing 3 of 11 inspection activities. View full ITP →

Related Inspection and Test Plan

An Inspection and Test Plan (ITP) is available for Method Statement – Installation of Large-Format Mirrored Wall Panels in Commercial Gymnasium Dance Studios. The ITP defines the inspection activities, acceptance criteria, hold and witness points, responsible parties, and records required to verify the work described in this method statement.

View the Method Statement – Installation of Large-Format Mirrored Wall Panels in Commercial Gymnasium Dance Studios ITP →

Frequently asked questions

A recognized benchmark is ≤2 mm deviation under a 2 m straightedge and ≤3 mm under 3 m. Verify and adopt project-specific tolerances.

Follow the adhesive manufacturer’s TDS. This method specifies a combed application to the primed substrate using a 4–6 mm V-notch, with vertical ribbons for venting.

Safety film is used when not factory-laminated or where required to achieve EN 12600/ANSI Z97.1 classification. Verify with the designer and code authority.

Provide uniform 2–3 mm joints (±0.5 mm) to accommodate thermal movement and alignment with sealant.

Use BS EN 1036 visual inspection at ~1 m perpendicular view and a reflected line/grid method. Lines should appear straight without local ripples (benchmark ≤2 mm over 2 m).
