Method Statement for Installation of Concrete‑Encased Duct Banks (LV, HV, Telecom & Fibre Optic) with Draw Pits inspection and test plan example.

Inspection and Test Plan for Method Statement for Installation of Concrete‑Encased Duct Banks (LV, HV, Telecom & Fibre Optic) with Draw Pits

AI-assisted inspection and test plan connected to a method statement, with PDF and Excel export.

Published 30 Jun 2026 Rev. 00 635 views 283 downloads 1 uses
About this ITP: Defines inspection activities, hold/witness points, and records for duct bank installation. Covers survey, duct/spacer setup, concrete, pits, mandrel tests, and backfill.

More than a static template

Unlike a downloadable Word or PDF template, this ITP is an AI-assisted editable starting point directly connected to its method statement. Every inspection activity, hold point, and acceptance criterion is structured and ready to adapt to your project.

  • AI-assisted customization — Tailor inspection activities and acceptance criteria to your specific project scope.
  • Linked method statement — This ITP is connected to the corresponding method statement describing the work sequence.
  • Multiple export formats — Download as a formatted PDF or editable Excel spreadsheet.
  • Editable starting point, not a final document — Review and verify all content against your project specifications and standards before use.

What you can customize

When you save this ITP to your account, every inspection row becomes editable. You can add, remove, or modify:

  • Inspection activity — Description of what is being inspected.
  • Inspection type — Hold point (H), Witness point (W), Review (R), or Monitor (M).
  • Responsibility — Contractor, subcontractor, engineer, or client.
  • Frequency — How often the inspection occurs.
  • Acceptance criteria — Referenced standard or specification requirement.
  • Records — Forms, test reports, or checklists required as evidence.

Why this ITP is used

To control and evidence quality and compliance at critical stages of duct bank construction.

Who uses this inspection and test plan

Contractor’s site/QA teams, third‑party labs, and the Engineer/Client for surveillance and acceptance.

When this ITP is prepared and submitted

From survey and excavation through concrete encasement, mandrel testing, pit works, to backfilling and final handover.

Who receives or approves this ITP

Engineer/Client Representative for approval and witnessing.

Inspection scope

Verification of materials, geometry, concrete quality, pit installation, mandrel testing, and backfill compaction across the full construction sequence.

Typical hold, witness, and review points

Pre‑pour checks of ducts/spacers/rebar (Hold), draw pit base/walls (Hold/Witness), and pre‑backfill after mandrel testing (Hold).

Typical inspection records

Inspection requests, concrete test reports, mandrel logs, continuity sheets, density tests, photos, and as‑built surveys.

Important approval note

This ITP is an AI-assisted editable starting point, not a pre-approved document. Before use on any project, all inspection activities, hold points, and acceptance criteria must be reviewed and approved by the relevant parties (superintendent, principal contractor, or client representative) in accordance with your contract and project quality plan.

Always verify acceptance criteria against your applicable drawings, specifications, and regulatory requirements. Hold points must be confirmed with the relevant authority before work proceeds past that point.

Inspection and test plan

Activity Inspection / Test Acceptance Criteria Responsibility Record
Setting out and survey control Check benchmarks; verify line/level Within tolerances: line ±20 mm; level ±5–10 mm [Verify] Surveyor / QA/QC Setting‑out record/IR
Utility detection and trial pits GPR/EML and hand‑dig verification All crossings proven; no mechanical excavation within 1 m until confirmed clear Site Engineer / HSE Trial pit report; photos
Trench excavation, shoring, and bedding Visual; level checks Width/depth per IFC; bedding thickness/levels within ±10 mm QA/QC / Engineer IR; checklist

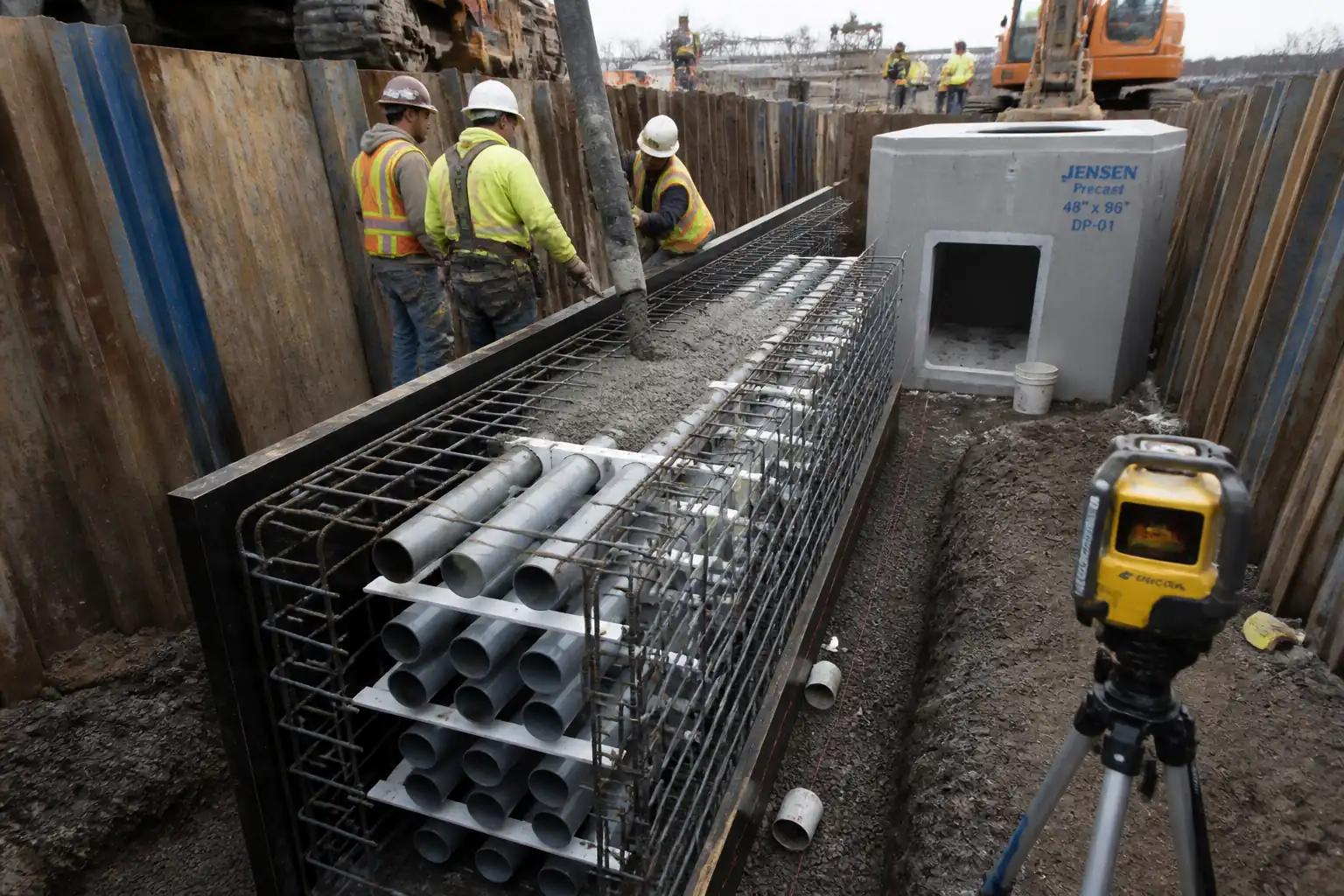

Ducts, spacers, restraints, reinforcement (Hold Point) Visual, measurement of separation/cover Separation/cover as per IFC; restraints ≤1.5 m; rebar per design QA/QC + Engineer IR (Hold) with photos
Concrete pre‑pour (Hold Point) IR review; cleanliness; end caps; levels Ducts clean/dry; alignment ok; checklists complete QA/QC + Engineer IR (Hold)
Concrete supply and placement Slump, temperature, cylinders; placement observation Results within approved limits; no duct displacement QA/QC / Lab Batch tickets; test reports
Curing inspection Visual; curing duration Curing maintained per spec (≥7 days or as approved) Site Engineer / QA Site diary
Draw pit base and wall installation (Hold/Witness) Dimensions, levels, water‑tight joints, pulling eyes Within ±5 mm; joints sealed; hardware installed QA/QC / Engineer IR; photos
Mandrel and swab test; roping; tracer wire continuity Mandrel 80–90% ID; continuity meter 100% ducts pass; continuity verified end‑to‑end Electrical Supervisor / QA/QC Mandrel log; continuity sheet
Pre‑backfill inspection (Hold Point) Visual; check warning tape depth; confirm tests complete All inspections passed; records available; site clean QA/QC + Engineer IR (Hold)
Backfill and compaction testing FDT per lot/lift ≥95% MDD (general) or ≥98% under pavements [Verify] QA/QC / Lab FDT reports; IR
Final inspection and as‑built Survey check; visual of reinstatement As‑built within tolerance; reinstatement per authority standard Engineer/Client + Contractor Signed IR; as‑built drawings

This table is a read-only public reference. Download the PDF or Excel version, or customize this ITP to edit it for your project.

Frequently asked questions

Yes, 100% of ducts between pits must be swabbed and mandrelled with records kept for each duct ID.

Typically ≥95% MDD in verges and ≥98% under pavements, unless project specifications state otherwise.

The Contractor’s QA/QC raises the IR; the Engineer/Client witnesses and signs prior to proceeding.

Related method statement

This Inspection and Test Plan is associated with the Method Statement for Installation of Concrete‑Encased Duct Banks (LV, HV, Telecom & Fibre Optic) with Draw Pits method statement, which describes the step-by-step construction sequence, resources, materials, equipment, safety controls, and environmental controls for this activity.

View the Method Statement for Installation of Concrete‑Encased Duct Banks (LV, HV, Telecom & Fibre Optic) with Draw Pits method statement →
