G
Guest

quality assurance · 24 checks

Review dynamic façade control intent and environmental response logic

Review dynamic façade control intent and environmental response logic to ensure automated shading and louver systems behave exactly as the design narrative specifies. This checklist focuses on control sequence verification, daylight and solar gain response, sensor calibration, and integration with building management systems. By aligning the sequence of operations to real environmental inputs—illuminance, irradiance, wind speed, temperature—and occupant states, teams prevent glare, hunting, and energy waste. We keep the scope tightly on dynamic façade automation, covering louvers, blinds, and their control logic; envelope performance modeling, structural glazing, or static shading details are out of scope. The outcome is predictable comfort, reduced cooling loads, and resilient safety responses to wind and fire events. The checklist emphasizes acceptance criteria, response times, and documented evidence so owners can trust seasonal performance and operators can tune confidently without breaking safeguards. Start the interactive checklist to tick items, add comments, and export PDF/Excel with a secure QR.

Review dynamic façade control intent, environmental response

Review dynamic façade control intent and environmental response logic for commissioning teams validating automated shading, louvers, and sensor-driven behavior against design intent, safety interlocks, and BMS integration across seasons and occupancy states.

  • Clarifies control sequence, zoning, and environmental trigger hierarchy.
  • Verifies sensor calibration, setpoints, and actuator response tolerances.
  • Confirms overrides, fail-safes, and integration with BMS and FAS.
  • Interactive, commentable, export, QR code evidence for accountability.

The checklist

Control Intent Documentation

  1. Confirm the approved control intent and sequence of operations match shop drawings and I/O schedules; cross-check revision dates and approvals; acceptance: no discrepancies; evidence: annotated comparison, document numbers, and signatures.
  2. Verify façade zones, devices, and groupings align with floor plans; method: mark up as-built drawings; acceptance: 100% device-to-zone mapping; evidence: redlined PDFs and zone index.
  3. Review time schedules for occupied/unoccupied and cleaning modes; method: controller/GUI screenshots; acceptance: schedules reflect approved occupancy calendar; evidence: dated screenshots and calendar reference.
  4. Validate naming conventions and BACnet object IDs; method: export point list; acceptance: unique names, correct units (lx, W/m², m/s, °C), and writable flags per intent; evidence: CSV export.

Sensor Inputs and Calibration

  1. Calibrate exterior vertical illuminance sensor beside a calibrated lux meter under stable sky; acceptance: ±10% over 5-minute average; evidence: side-by-side photo and time-stamped readings.
  2. Verify pyranometer/solar sensor orientation; method: compass and inclinometer; acceptance: azimuth due south ±5°, tilt within latitude ±5°; evidence: photos with readings and as-built note.
  3. Check interior daylight sensor placement; method: measure horizontal offset from glazing and ceiling obstructions; acceptance: clear of luminaires ≥0.6 m, representative zone, mounting height per design; evidence: measurements and photos.
  4. Function-test wind and temperature sensors via BMS simulation/inject; acceptance: wind alarm triggers at ≥15 m/s and clears with 2 m/s hysteresis; evidence: trend log and alarm screenshot.

Response Logic and Setpoints

  1. Glare control test: raise vertical illuminance at eye to ~2000 lx; acceptance: blinds/louvers move to glare setpoint within 60 s without hunting; evidence: lux trend and actuator status timeline.
  2. Sun-tracking verification: compare controller-calculated louver angle to astronomical model; method: angle gauge; acceptance: angle error ≤±3°; evidence: timestamped photos and computed vs actual table.
  3. Solar gain mode: inject irradiance ≥300 W/m² for 5 min; acceptance: partial close to heat-reduction setpoint within 90 s and deadband prevents oscillation; evidence: irradiance and position trends.
  4. Night/sunrise transitions: simulate sunrise via sensor override; acceptance: single transition with deadband ≥10% irradiance and minimum position dwell ≥10 min; evidence: trend plot showing stable behavior.

Overrides, Fail-safes, and Modes

  1. Local manual override: activate wall switch or app; acceptance: local control for 120 ± 5 min, then auto-resume with visual status; evidence: event log and GUI indicator screenshot.
  2. High-wind safety: simulate 20 m/s input; acceptance: all shades stow to safe position ≤30 s and alarm raised; evidence: video clip, alarm record, and restored-normal confirmation.
  3. Fire alarm interlock: trigger from FAS test key; acceptance: move to specified safe state ≤60 s, manual control locked out until reset; evidence: FAS printout and joint sign-off per approved project specifications and authority requirements.
  4. Power loss recovery: de-energize controller circuit; acceptance: system returns to last safe/default state within 2 min after power-up; evidence: video, UPS runtime record, and post-restore trend.

Integration, Alarms, and Trending

  1. BACnet mapping review: network scan vs I/O schedule; acceptance: 100% points exposed with correct units, COV settings, and write priorities; evidence: scan report and approved point list.
  2. Alarm text and priorities: force sensor fault and actuator stall; acceptance: clear, unique messages, priority per approved project specifications and authority requirements; evidence: screenshots with timestamps and acknowledgment records.
  3. Trend configuration: enable 1 min intervals for key sensors and positions; acceptance: ≥7 days retention and exportable CSV; evidence: downloaded sample file and storage setting screenshot.
  4. Occupied/unoccupied logic: simulate occupancy sensor and schedule; acceptance: unoccupied daytime opens shades unless solar/glare protection active; evidence: position trend and occupancy state log.

Commissioning Evidence and Handover

  1. As-built control diagrams: update schematics to reflect final wiring and logic; acceptance: issued revision with approvals; evidence: uploaded PDF/DWG to CDE and transmittal record.
  2. Setpoint and deadband register: compile table with rationale; acceptance: reviewed by design engineer; evidence: signed register and controller backup file.
  3. Operator training: deliver 60 min session covering tuning and alarms; acceptance: attendance sheet and quiz ≥80% pass rate; evidence: slides, recording link, and signed roster.
  4. Seasonal performance plan: define KPIs (glare complaints/month, kWh cooling, override hours); acceptance: quarterly review schedule with responsible party assigned; evidence: monitoring plan and meeting minutes.

Preview the printable checklist

Preview page one below. Open the image or download the PDF for all pages.

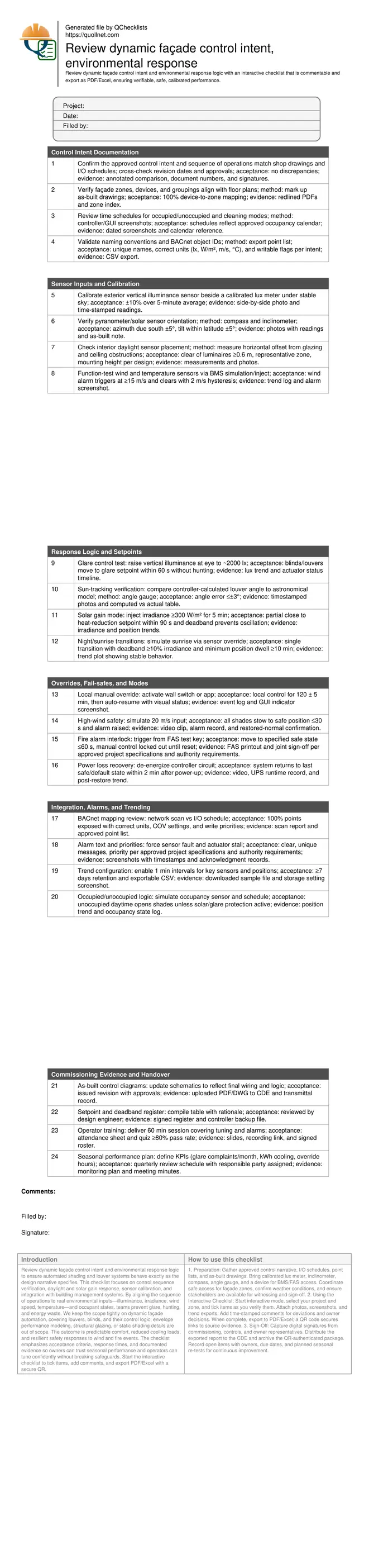

First-page preview of the Dynamic Façade Control Intent Review printable checklist template.
Dynamic Façade Control Intent Review · Page 1 preview · Open image with all pages

At a glance

  • Establishes a traceable link between the approved control narrative, point lists, and real device behavior, preventing scope creep and missed interlocks. Defined tolerances for sensors, timings, and angles keep logic stable and reduce nuisance overrides.
  • Focuses on environmental sensing quality—lux, irradiance, wind, and temperature—so shading responds to real conditions without hunting. Calibrations, deadbands, and trend reviews help maintain comfort, protect façades, and limit HVAC loads across seasons.
  • Drives reliable safety and integration: high-wind stow, fire alarm responses, power-loss recovery, and BACnet mapping. Clear alarms, trend retention, and operator training build confidence and speed up root-cause analysis during live operations.
  • Interactive online checklist with tick, comment, and export features secured by QR code.

How to Use This Interactive Dynamic Façade Review Checklist

  1. Preparation: Gather approved control narrative, I/O schedules, point lists, and as-built drawings. Bring calibrated lux meter, inclinometer, compass, angle gauge, and a device for BMS/FAS access. Coordinate safe access for façade zones, confirm weather conditions, and ensure stakeholders are available for witnessing and sign-off.
  2. Using the Interactive Checklist: Start interactive mode, select your project and zone, and tick items as you verify them. Attach photos, screenshots, and trend exports. Add time-stamped comments for deviations and owner decisions. When complete, export to PDF/Excel; a QR code secures links to source evidence.
  3. Sign-Off: Capture digital signatures from commissioning, controls, and owner representatives. Distribute the exported report to the CDE and archive the QR-authenticated package. Record open items with owners, due dates, and planned seasonal re-tests for continuous improvement.

Translate Control Intent into Verifiable Sequences

A robust review starts by converting the design narrative and sequence of operations into concrete, testable behaviors. Map every façade zone to its sensors, actuators, and overrides, then tie each behavior to a measurable input and a timestamped output. Use a consistent naming convention so engineering units and write priorities are unambiguous. This prevents logic gaps where multiple triggers compete—glare, solar gain, cleaning mode—causing oscillation. Practical acceptance hinges on documentation parity: drawings, I/O schedules, and live points must match. On site, request controller screenshots and exported point lists, not just verbal confirmation. A real example: a south curtain-wall zone failing to respond due to a mislabeled irradiance point; the fix emerged only after reconciling the point list with the GUI. Embed deadbands and minimum dwell times to stop hunting during partly cloudy conditions, and document them in a setpoint register operators can maintain without breaking safeguards.

  • Tie each behavior to input, output, and time stamp.
  • Use unique names with correct SI units and priorities.
  • Resolve trigger conflicts with hierarchy and deadbands.
  • Demand screenshots and exports, not verbal confirmation.
  • Maintain a signed, update-controlled setpoint register.

Calibrate Environmental Sensing and Validate Responses

Dynamic façade performance lives or dies on sensing quality. Calibrate exterior illuminance against a reference meter and verify solar sensor orientation with an inclinometer and compass. Interior daylight sensors must avoid luminaires and reflections to prevent false highs. With reliable inputs, test core responses: glare suppression by vertical illuminance, sun-tracking louver angles, and heat-reduction setpoints, each with explicit timing and deadbands. Trend at 1-minute resolution to prove stability over varying cloud cover and low sun. Exercise occupied/unoccupied and cleaning modes to ensure the hierarchy yields predictable outcomes. Typical pitfalls include open-loop angle tables that ignore seasonal altitude shifts, or glare thresholds set so low that blinds never open. Close the loop with astronomical checks and field angle gauges, then log before/after curves so tuning decisions remain auditable across seasons.

  • Calibrate with reference meters and document readings.
  • Verify sensor orientation and mounting clearances.
  • Validate timings, angles, and deadbands with trends.
  • Test mode hierarchy under real and simulated inputs.
  • Capture before/after curves to justify tuning changes.

Prove Safety, Integration, and Operability

Safety and integration complete the review. High-wind events must stow shades quickly while logging a clear alarm; fire alarms must drive a safe state and lock out manual commands until reset. Power interruptions should recover to a deterministic, documented condition. On the integration front, confirm BACnet point exposure, engineering units, and priority arrays—misplaced write priorities cause silent failures. Trend retention for at least a week lets you visualize dawn/dusk transitions and intermittent sensor faults. Operators need training and a concise troubleshooting playbook so setpoint edits don’t defeat safeguards. Establish KPIs such as glare complaints per month and override hours per zone to track ongoing performance. With these guardrails, seasonal adjustments become controlled improvements, not risky experiments, and incident investigations are faster and more conclusive.

  • Verify wind, fire, and power-loss behaviors with evidence.
  • Check BACnet exposure, units, and write priorities.
  • Retain 7+ days of 1-minute trends for analysis.
  • Train operators and issue a tuning playbook.
  • Define KPIs to guide seasonal optimization.

Nina Kovacis's photo
Nina Kovacis
6859
272
23
31

Frequently asked questions

What is the difference between control intent and environmental response logic?

Control intent describes what the system should do in each scenario—modes, priorities, and safety. Environmental response logic turns that intent into measurable triggers, deadbands, and actuator actions based on sensors like lux, irradiance, wind, and temperature. Reviewing both ensures documented expectations match real, time-stamped behaviors on site.

How can I simulate sunlight and glare conditions during commissioning?

Use a calibrated lux meter to track vertical illuminance at the eye while testing with natural sun or portable luminaires to exceed thresholds. For sun-tracking, compare controller solar position to an astronomical calculator, and verify louver angles with a mechanical gauge. Always trend at 1-minute intervals to capture transitions and hunting.

What tolerances are acceptable for sensors and louver positioning?

Common acceptance is ±10% for exterior illuminance calibration and solar sensor orientation within ±5° of target. For sun-tracking, louver angle error within ±3° is usually achievable. Time-based responses often target 30–90 seconds with appropriate deadbands. Use project-approved tolerances when specified and document all measured results.

How do we prevent hunting during partly cloudy conditions?

Apply deadbands around irradiance and illuminance thresholds, enforce minimum dwell times before position changes, and filter noisy signals with short averaging windows. Ensure trigger hierarchy is clear so glare suppression or safety states override energy-saving moves. Validate stability in trend logs across variable cloud cover and adjust deadbands as needed.

What ongoing monitoring is needed after handover?

Keep 1-minute trends for key sensors and louver positions, review KPIs such as glare complaints and override hours monthly, and schedule quarterly seasonal tuning. Train operators to update the setpoint register under change control. Use QR-linked evidence in the checklist to trace adjustments back to observations and decisions.
