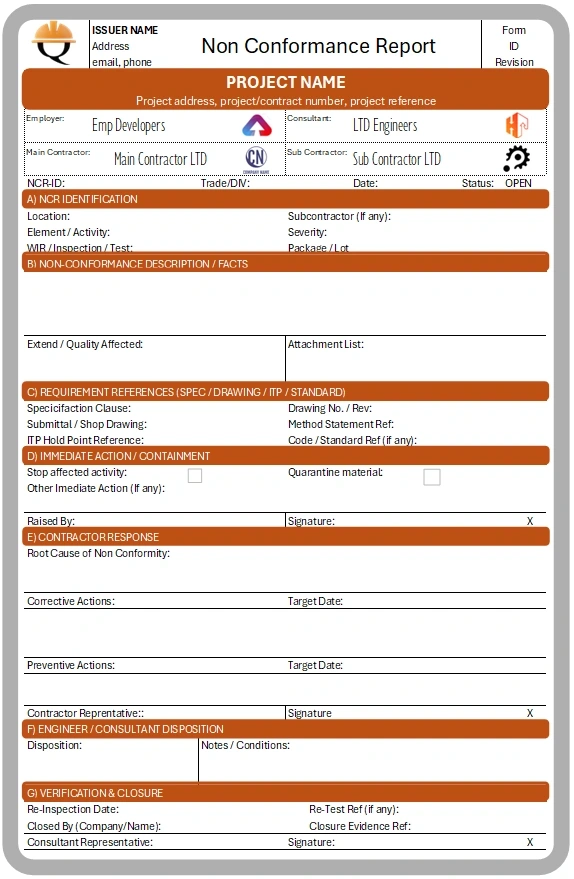

NCR Form Template
Use this NCR (Non-Conformance Report) form template to record and close construction non-conformances consistently, with the minimum fields expected by most QA/QC systems.
Best use: site QA/QC teams, consultants, and contractors who need a clean NCR format with clear references and closure evidence.
Download NCR Form Template
What this NCR form includes (fields)
A) NCR identification
-
Project / package / contract
-
NCR number (unique reference)
-
Date raised
-
Raised by (company + name)
-
Responsible party (main contractor / subcontractor)
B) Location & work description
-
Building / zone / gridline / level / chainage
-
Trade / discipline (civil, architectural, MEP, steel, etc.)
-
Activity / element (slab, column, waterproofing, cable pulling, etc.)
C) Non-conformance description (facts only)
-
What was found (measured/observed/test result)
-
Quantity/extent (how much area affected)
-
Evidence reference (photos, sketches, marked-up drawings)
D) Requirement references (the most important part)
-
Specification section / clause
-
Drawing number + revision
-
Approved shop drawing / method statement reference
-
ITP step / WIR reference (if applicable)
-
Standard/code reference (if applicable)
E) Immediate action / containment
-
Stop affected activity (Yes/No)
-
Quarantine material (Yes/No)
-
Protect from concealment (Yes/No)
-
Temporary measures implemented
F) Contractor response
-
Root cause (why it happened)
-
Corrective action (how it will be fixed)
-
Preventive action (how recurrence is prevented)
-
Target dates
G) Engineer / Consultant disposition
-
Accept as-is (with justification)
-
Repair
-
Remove and replace
-
Accept with concession / technical deviation (if allowed)
H) Verification & closure
-
Re-inspection date
-
Re-test results reference (if applicable)
-
Closure evidence attached (photos/reports)
-
Closed by + date + signature
How to fill an NCR (quick guidance)
-
Write the non-conformance as a measurable fact (not an opinion).
-
Always include at least one hard reference: spec clause or drawing number.
-
Record containment actions immediately (stop/quarantine/protect).
-
Require contractor response with root cause + corrective + preventive action.
-
Close only after verification evidence is submitted and accepted.
Suggested numbering system (simple and scalable)
Use one consistent format, for example:
NCR-Discipline-Year-Sequential
-
NCR-CIV-2026-001
-
NCR-MEP-2026-014
If you manage multiple packages, add package code:
-
NCR-PKG1-CIV-2026-001
Common mistakes (avoid these)
-
No reference to specs/drawings (βnot acceptableβ is not enough)
-
Closing without evidence
-
Using NCRs for minor snags (creates noise and weakens the system)
-
Not controlling the affected work/material (containment)
Related pages (published separately)
-
NCR Meaning in Construction
-
NCR Log Template (Register)
-
Observation vs NCR vs Snag vs Defect
Filled Example NCR (Concrete Works)
A) NCR identification
-
Project: ABC Residential Towers β Package 01
-
NCR No.: NCR-CIV-2026-003
-
Date raised: 06 Jan 2026
-
Raised by: Consultant QA/QC Engineer
-
Responsible party: Main Contractor / RC Subcontractor
B) Location & work description
-
Location: Tower A, Level 05, Grid B-4 to B-6
-
Discipline / Trade: Civil / Reinforced Concrete
-
Element / Activity: Reinforcement fixing for slab S5 prior to concrete pour
C) Non-conformance description (facts only)
During pre-pour inspection, the top reinforcement spacing in the slab strip at Grid B-4 to B-6 was measured at 250 mm c/c, whereas the approved drawing requires 200 mm c/c. The affected area is approximately 18 mΒ².
Evidence: Photo refs NCR-CIV-2026-003-01 to 05 and marked-up sketch SK-NCR-003.
D) Requirement references
-
Structural drawing: S-105 Rev 04 (Top reinforcement spacing @ slab strip = 200 mm c/c)
-
Specification: Section 03 30 00 β Cast-in-Place Concrete, clause (reinforcement installation per drawings)
-
ITP: ITP-RC-01, Hold Point HP-03 (Pre-pour rebar inspection)
-
WIR: WIR-RC-05-147 (submitted for pre-pour inspection)
E) Immediate action / containment
-
Stop affected activity: YES (pour not permitted in affected zone)
-
Prevent concealment: YES (do not place concrete until clearance)
-
Quarantine material: N/A
-
Temporary measures: Affected area tagged and barricaded; foreman instructed not to proceed.
F) Contractor response (root cause + corrective + preventive)
-
Root cause: Fixing crew used an outdated rebar spacing note from an earlier revision and the supervisor did not verify against the latest approved drawing revision.
-
Corrective action: Remove and re-fix top reinforcement in the affected zone to 200 mm c/c as per S-105 Rev 04. Submit re-inspection request.
-
Preventive action: Toolbox talk for rebar crew; supervisor to verify drawing revision on site before start of fixing; drawing revision list to be posted in the rebar yard.
-
Target date: Corrective action completed by 07 Jan 2026; re-inspection on 07 Jan 2026.
G) Engineer / Consultant disposition
-
Disposition: Repair / Rectify
-
Notes: Works may proceed only after re-inspection and acceptance of corrected spacing. No concrete placement permitted in affected zone prior to clearance.
H) Verification & closure
-
Re-inspection date: 07 Jan 2026
-
Verification outcome: Spacing re-measured at 200 mm c/c; accepted.
-
Closure evidence: Photo refs NCR-CIV-2026-003-C1 to C3; updated marked-up sketch attached.
-
NCR status: CLOSED
-
Closed by: Consultant QA/QC Engineer β 07 Jan 2026
