Contractor Mobilization Plan Review Checklist for Consultants

Contractor Mobilization Plan Review Checklist helps consultant and supervision teams scrutinize contractor mobilization submittals before site start. This mobilization review focuses on a construction mobilization plan’s logistics, phasing, and temporary works so the site can activate safely and efficiently. By rigorously assessing crane locations, access routes, laydown sizing, utilities, and staffing, you prevent hidden phasing conflicts and downstream blockages—like a phase 1 crane base that obstructs phase 2 works. The checklist guides a logistics and phasing review using overlays, 4D/time–location analysis, swept-path checks, and quantified acceptance criteria. It emphasizes verifiable evidence, approvals, and signatures per approved project specifications and authority requirements. Outcomes include safer lifts, clearer access, right-sized laydown, compliant permits, and a mobilization that supports—not hinders—the programme. Use this interactive tool to collaborate with contractors, assign actions, and track close-out. Start interactive mode to tick items, add comments, and export PDF/Excel with a secure QR for traceable sign-off.

a guide that consultant / supervision team uses to review the contractor submitted mobilization plan for a construction project.

this should protect the project from contractor's trick that may be used in their submission - eg: installing a crane for phase 1 in a good location that may block the work of phase 2.

Contractor Mobilization Plan Review Checklist equips consultant/supervision teams to forensically audit contractor mobilization submittals, eliminate phasing conflicts, and verify logistics, heavy lifts, temporary utilities, and access before site start.

  • Catch phase-blocking layouts early with overlays and 4D phasing.
  • Demand quantified evidence, tolerances, and approvals before mobilization starts.
  • Control cranes, routes, and utilities to avoid unsafe, costly rework.
  • Interactive, commentable, export, QR code for traceable site sign-offs.

The checklist

Planning & Sequencing

  1. Cross-check mobilization scope across all phases using a WBS-linked logistics matrix (Excel). Acceptance: all activities supported with locations/dates. Evidence: completed matrix signed by contractor PM and consultant.
  2. Review 4D phasing animation or time–location diagram (Navisworks/Powerproject). Acceptance: zero spatio-temporal overlaps between work zones. Evidence: exported clash report PDF and stamped snapshots.
  3. Verify interface handover/handback milestones include ≥72 h buffer between phases. Method: compare integrated programme and logistics release dates. Evidence: baseline programme with buffers highlighted and dual signatures.
  4. Check weather and wind windows for critical lifts using historic data and site anemometer criteria. Acceptance: planned lifts within limit (e.g., ≤10 m/s or per specs). Evidence: metocean summary and lift criteria sheet.
  5. Align procurement deliveries with laydown readiness via 6‑week lookahead. Acceptance: storage areas available ≥7 days before first delivery. Evidence: lookahead schedule and area release memo.

Site Access, Logistics & Phasing

  1. Run swept-path analysis for delivery routes (AutoTURN). Acceptance: lane width ≥4.0 m, turning radius ≥8.0 m, overhead clearance ≥5.0 m. Evidence: annotated route drawings with vehicle envelopes.
  2. Confirm a 3.5 m-wide emergency route remains unobstructed 24/7. Method: overlay access route on all phasing drawings. Evidence: route map, signage schedule, and contractor commitment letter.
  3. Validate pedestrian segregation using rigid barriers. Acceptance: walkway width ≥1.2 m; controlled crossings (flagger or lights). Evidence: layout drawings with dimensions and barrier specification.
  4. Size laydown and storage from material take-off. Acceptance: planned area ≥ calculated requirement +20% buffer. Evidence: area schedule, scaled plan, and marked storage zones.
  5. Plan waste skips and collection paths clear of cranes/exclusion zones. Acceptance: vehicle queuing <15 min at gates. Evidence: waste flow diagram, service contract, and gate operation SOP.

Temporary Works & Utilities

  1. Review temporary power load schedule and single-line diagram. Acceptance: feeders sized per specs with ≥25% spare capacity. Evidence: stamped SLD, load list, and earthing details.
  2. Verify temporary water and firefighting mains routing with backflow protection. Acceptance: hydrant/hose points within ≤50 m of active zones. Evidence: utilities plan and valve/hydrant schedule.
  3. Assess drainage/dewatering capacity using rainfall design data. Acceptance: maintain <50 mm standing water after design storm; discharge per approved specs. Evidence: pump sizing calculations and discharge permits.
  4. Require recent underground utility survey (GPR/vacuum excavation) and permit-to-dig workflow. Acceptance: no-dig zones hatched and authorized. Evidence: survey report, marked drawings, and permit template.
  5. Check traffic management plan for entries/exits. Acceptance: sight distance ≥120 m and compliant signage. Evidence: TMP drawing, sign schedule per approved project specifications and authority requirements.

Plant, Cranes & Heavy Lifts

  1. Overlay crane bases, swing radii, and exclusion zones on combined-phase drawings. Acceptance: zero overlap into future workfaces, roads, or neighbours. Evidence: layered CAD/PDF with consultant mark-up and sign-off.
  2. Verify crane mat design against allowable ground bearing from geotechnical report. Acceptance: design pressure ≤ allowable with FS ≥1.5. Evidence: signed calculations and geotechnical extract.
  3. Review crane erection/dismantle sequence and laydown footprint. Acceptance: tail-swing clearance ≥1.5× counterweight radius. Evidence: method statement, rigging plan, and space layout.
  4. Check lift paths for obstructions and wind stop criteria. Acceptance: ≥600 mm clearance to structures; wind limit defined (e.g., 10–12 m/s) per specs. Evidence: approved lift study.
  5. Confirm delivery booking system and off-site holding area. Acceptance: on-site queue ≤2 vehicles; dwell time ≤15 min. Evidence: slot register, marshalling plan, and gate signage.

HSE & Compliance

  1. Ensure hoarding ≥2.4 m high, lighting on routes ≥50 lx, and wayfinding/safety signage installed. Evidence: lighting calculations, sign legend, and site layout.
  2. Compile permit/approval register (excavation, traffic, utility tie-ins). Acceptance: all pre-start permits approved. Evidence: signed register and copies per approved project specifications and authority requirements.
  3. Confirm 100% induction for site access with turnstile/badge control. Evidence: induction roster, sample badges, and gate SOP with escalation steps.
  4. Plan environmental controls: noise, dust, and water. Acceptance: boundary noise trigger ≤70 dB(A) unless stricter by authority. Evidence: monitoring plan, PM10 monitor locations, silt control details.
  5. Verify emergency preparedness: muster points, spill kits, first aid, extinguishers. Acceptance: response reach ≤2 min from workfaces. Evidence: emergency layout and equipment inventory.

Resources & Controls

  1. Check supervision ratios and roles. Acceptance: ≥1 foreman per 15 operatives; named logistics lead. Evidence: organization chart and key CVs.
  2. Review maintenance plans/spares for critical plant (cranes, pumps, generators). Acceptance: OEM service intervals adopted; critical spares on-site. Evidence: maintenance matrix and delivery notes.
  3. Approve materials receiving ITP with hold/witness points for identity, quantity, damage, storage. Evidence: signed ITP and sample receiving checklist with photos.
  4. Examine mobilization risk register. Acceptance: top 10 risks with owners, due dates, mitigations. Evidence: signed register and review meeting minutes.
  5. Confirm financial securities active: performance bond, advance payment guarantee, and CAR insurance. Evidence: valid certificates covering mobilization period and values.

Preview the printable checklist

Preview page one below. Open the image or download the PDF for all pages.

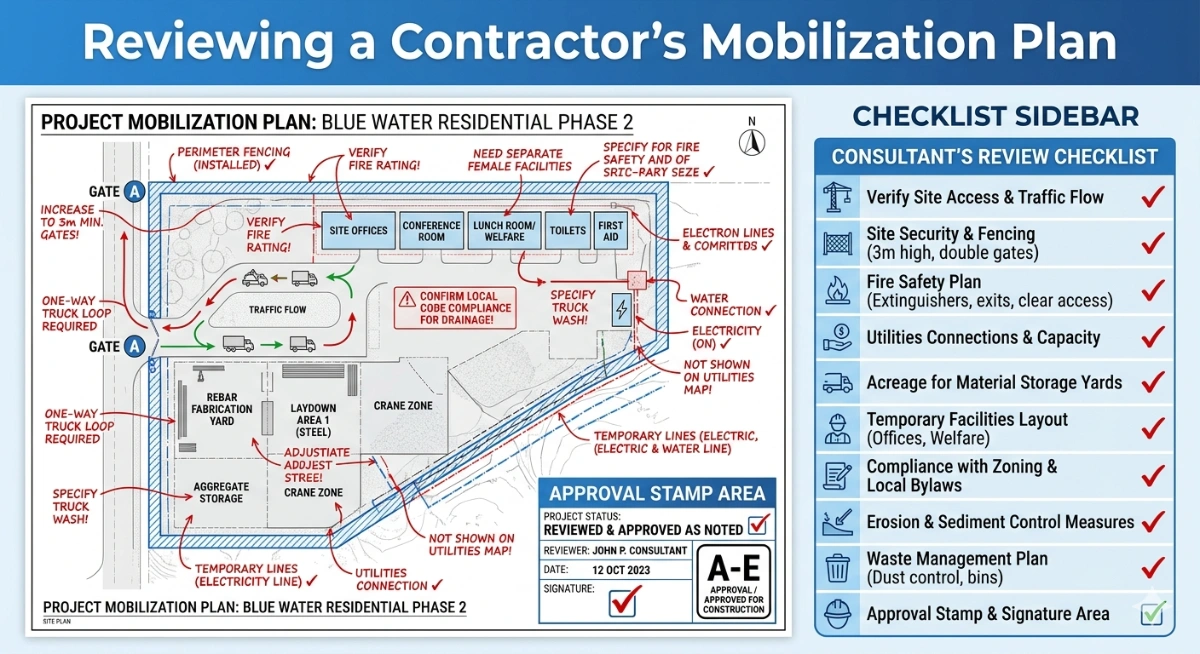

First-page preview of the Contractor Mobilization Plan Review printable checklist template.
Contractor Mobilization Plan Review · Page 1 preview · Open image with all pages

At a glance

  • Use this consultant-focused checklist to interrogate contractor mobilization plans with overlays, 4D phasing, swept-path analysis, and quantified tolerances. Capture evidence, approvals, and signatures to avoid phase clashes, blocked access, and rework before boots hit the ground.
  • Mitigate crane, utilities, and logistics risks by demanding stamped drawings, load schedules, lift studies, and geotechnical bearing checks. The process verifies capacities, clearances, buffers, and permits per approved project specifications and authority requirements.
  • Interactive online checklist with tick, comment, and export features secured by QR code.
  • Drive accountability with action owners, deadlines, and traceable records. Field teams attach photos, mark-ups, and registers; office teams align programme, laydown readiness, and deliveries. The result is a safe, compliant, and phased mobilization that protects schedule and budget.

How to Use This Interactive Mobilization Plan Review Checklist

  1. Preparation: gather combined-phase logistics drawings, 4D model or time–location diagrams, crane lift studies, geotechnical report, swept-path software, temporary works layouts, permit registers, and authority requirements. Brief the team, assign roles, and arrange a joint desk review followed by a site walk. Equip tablets/laptops with the checklist app and camera for evidence capture.
  2. Using the Interactive Checklist: start interactive mode, filter by group (access, cranes, utilities, etc.), and tick items as you review. Attach photos, marked-up PDFs, and calculations. Add comment threads, mention responsible parties, and set due dates. Record approvals and decisions, then export to PDF/Excel for circulation and meeting minutes.
  3. Sign-Off: compile outstanding actions and verify close-out evidence. Obtain digital signatures from contractor PM, consultant RE, and client if required. Issue the signed checklist to stakeholders and archive it. Use the QR-authenticated export so field teams can verify the latest approved mobilization on site.

Why a rigorous mobilization review prevents phase conflicts

Mobilization activates the site’s physical backbone—access, laydown, cranes, power, and controls. If these are placed for today but ignore tomorrow, later phases stall. A consultant-led review interrogates the submittal for spatial and temporal conflicts that typical narratives miss. Overlay crane radii on all phases, confirm access corridors remain open during handbacks, and right-size storage to avoid choke points. Examine how temporary utilities are routed so connections and isolations do not cut off active workfaces. Require evidence, not intentions: stamped drawings, capacity calculations, and interface buffers. This disciplined approach blocks common pitfalls like a phase 1 crane pad stranded in a phase 2 foundation or cabins sitting on future utility trenches. Early detection protects safety, schedule, and cost by removing conflicts before resources mobilize, while still cheap to change.

  • Overlay logistics across all phases, not just phase one.
  • Demand quantified capacities, clearances, and buffers.
  • Keep emergency and public access open at all times.
  • Require signatures on drawings and registers.

Evidence-based methods and acceptance cues for consultants

Use tools that produce verifiable outputs. 4D phasing or time–location diagrams demonstrate when two crews try to share the same space. Swept-path analysis shows whether delivery vehicles can safely negotiate gates and internal turns. Load schedules and single-line diagrams validate power capacity and spare headroom. Geotechnical data justifies crane mat design and bearing pressures. Lift studies define clearances and wind limits. Each method has acceptance cues: minimum widths and radii, buffers between phases, spare capacity percentages, and documented stop criteria. Enforce a consistent rule: if it is not drawn, calculated, scheduled, or signed, it is not approved. Close gaps by marking up combined-phase drawings, attaching calculations, and referencing permit registers. This makes decisions auditable and resistance-proof during execution.

  • Prefer overlays and models to verbal assurances.
  • Tie every item to drawings, calcs, or registers.
  • Define pass/fail thresholds early and visibly.
  • Record comments and decisions with dates.

Common tricks and robust countermeasures

Contractors may position a crane perfectly for early lifts but block later works, propose laydown where future foundations sit, or route temporary power across upcoming excavations. Counter these by demanding combined-phase overlays and dismantle logistics, not just initial setups. Require delivery booking with off-site holding to prevent road congestion. Insist on recent underground surveys before fencing or cabins go in. Validate environmental controls with measurable triggers and monitoring locations. Confirm supervision ratios and named logistics leads so responsibilities are clear. Finally, lock in approvals: permit registers, insurance certificates, and stamped drawings. When everything is evidenced and signed, tactics that rely on ambiguity lose power—and the project stays buildable through every phase.

  • Look for perfect-now, impossible-later equipment positions.
  • Check utility routes against future excavations.
  • Demand dismantle and back-out plans, not only setups.
  • Use booking and monitoring to control variability.

Elie Saad's photo
Elie Saad
9787
900
4
11

Frequently asked questions

What should a contractor mobilization plan review include?

Include logistics and phasing overlays, crane layouts with swing and exclusion zones, access and emergency routes, laydown sizing, temporary power/water/drainage, traffic management, induction and control systems, permit and approval registers, risk and interface schedules, lift studies, and evidence of capacities, buffers, and signatures per approved project specifications and authority requirements.

When should the mobilization plan be reviewed and revalidated?

Review before site establishment, aligned with baseline programme approval. Revalidate at each phase transition, before critical lifts, and whenever access, craneage, or utility routes change. Trigger a focused recheck after design revisions, new permits, or adjacent works start, ensuring overlays, schedules, and permits reflect the latest conditions and approvals.

How can we detect a crane location that will block later phases?

Demand combined-phase overlays of crane bases, swing radii, and dismantle paths. Review tail-swing, ground bearing, and exclusion zones against future workfaces, deliveries, and public roads. Validate lift and back-out logistics during handbacks. Approval requires zero encroachment in later phases and signed drawings confirming clearances and dismantle feasibility.

What evidence must we require before approving mobilization?

Require stamped drawings, capacity calculations, schedules with buffers, permit copies, lift studies with wind limits, geotechnical excerpts for bearing checks, swept-path outputs, monitoring plans, and signed registers. Each approval should include dates, responsible persons, and acceptance thresholds, ensuring traceability and compliance with approved project specifications and authority requirements.
