Inspect sealant adhesion testing and substrate preparation defines a field-ready checklist for QA inspectors and installers to verify clean substrates, correct primers, and reliable hand-pull adhesion results before acceptance.
- Verify clean, dry substrates and correct primer selection for adhesion.
- Control joint geometry, backer rod sizing, and application timing.
- Conduct standardized hand-pull field tests and record failure modes.
- Interactive, commentable checklist with export and QR code verification.
The checklist
Pre-Inspection Setup
- Confirm approved sealant, color, and lot numbers match submittals; photograph cartridge labels and record batch/expiry for traceability.
- Verify PPE and SDS on site: cut-resistant gloves, safety glasses, and respirator if using solvents; attach toolbox talk sign-in sheet.
- Calibrate and stage tools: hygrometer/thermometer, surface moisture meter, depth gauge, steel rule, sharp blades, rollers; upload calibration certificates where applicable.
- Select test locations representative of each substrate type; mark gridlines or coordinates and map them on plan photos for reference.
Substrate Preparation Verification
- Measure substrate moisture content with a compatible meter; confirm within manufacturer limits; record readings (%, °C surface temperature) with timestamped photos.
- Perform solvent wipe test using approved cleaner and lint-free cloth; cloth should show minimal discoloration; photograph before/after and note solvent type.
- Remove laitance, loose particles, and old sealant residues by brushing or grinding; vacuum dust; capture close-up photos of the cleaned profile.
- Verify primer requirement for each substrate per manufacturer literature; if required, apply evenly; log primer product, lot number, coverage estimate (m²/L), and drying time.
Joint Backing and Geometry
- Measure joint width at three points using a steel rule; record values in mm and compare with drawings; attach annotated photos.
- Verify backer rod type (closed-cell, non-gassing) and diameter 25–33% larger than joint width; photograph packaging and installed sample.
- Install backer rod to uniform depth using a roller; confirm depth-to-width ratio per manufacturer guidance (typically 1:2) ±3 mm; record three depth checks.
- Apply bond-breaker tape where backer rod is not feasible to prevent three-sided adhesion; photo evidence of placement.
Adhesion Testing (Hand-Pull Method)
- Record ambient conditions (°C, %RH, wind) before application; confirm within product limits; include instrument photos displaying readings.
- Mask joint edges and gun a continuous bead; tool within open time; log application start/finish times and installer name; take close-up photos.
- Form test tab by inserting a release strip to create a 75 mm pull tail; photograph tab geometry with a ruler for scale.
- Allow cure per manufacturer schedule; record skin-over and minimum cure time (h); optionally record Shore A hardness; verify readiness before testing.
- Cut a 25 mm wide strip with two parallel knife cuts to backing; avoid substrate damage; attach photo showing measured width.
- Pull tab at approximately 180° and steady 50 mm/s rate; note force if using a spring scale; record adhesive vs cohesive failure percentages.
- Repeat hand-pull at a minimum of three locations per substrate type; log each location ID, conditions, and photographic evidence.
Documentation and Acceptance
- Evaluate results against approved project specifications and authority requirements; identify acceptance (e.g., predominant cohesive failure) and flag any adhesive failures.
- Record product and primer batch numbers, backer rod lot, crew, and inspector signatures; compile into a single test report with embedded photos.
- For failures, document root cause (moisture, contamination, geometry); define corrective action (reclean, re-prime, resize backing), cure interval, and retest date; obtain approvals.

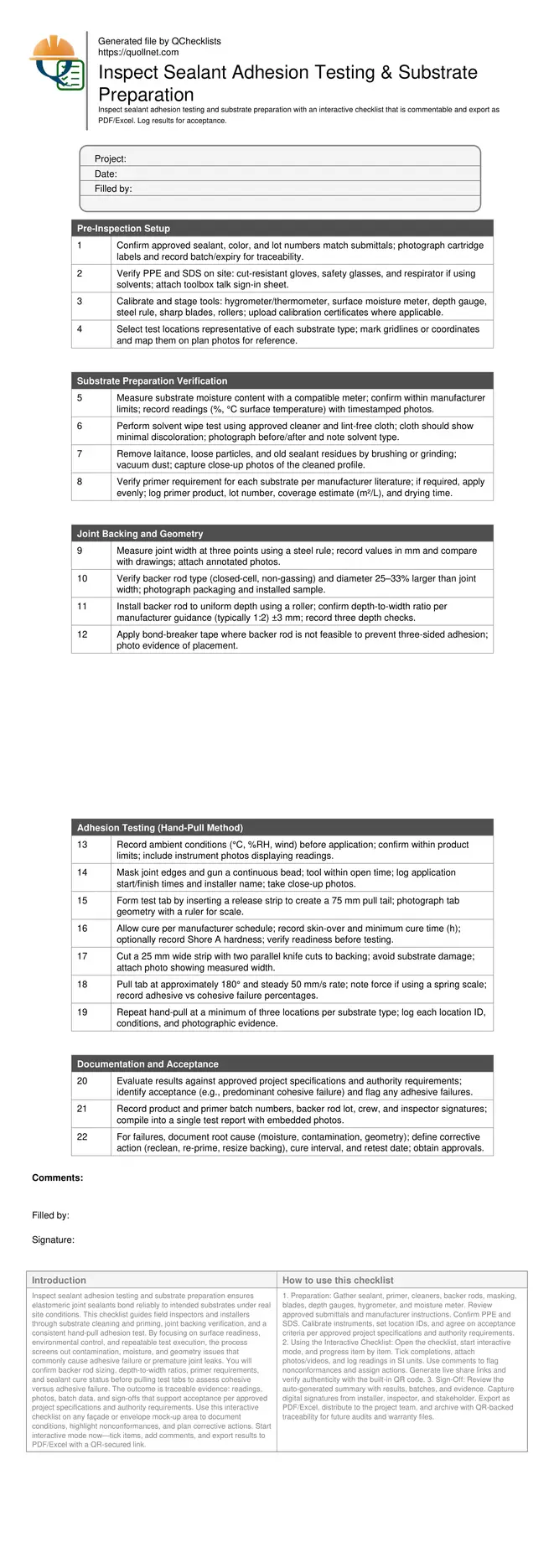

Preview the printable checklist
Preview page one below. Open the image or download the PDF for all pages.
At a glance
- Validate substrate condition, primer selection, and joint geometry before testing to prevent adhesion loss, staining, or cohesive tearing. Record environmental conditions in °C and %RH, confirm moisture limits, and capture photos of cleaning, priming, and backing installations for traceable acceptance.
- Standardize the hand‑pull test by forming repeatable tabs, cutting to a consistent width, and pulling at a steady rate. Log failure mode percentages, force indications when available, and replicate across locations and substrates to build statistically confident results.
- Integrate documentation rigor: batch numbers, cure intervals, wet/dry times, and responsible personnel. When failures occur, link root causes to corrective actions—reclean, re-prime, resize backing—and schedule retests after appropriate cure durations, ensuring durable, leak‑resistant joints.
- Interactive online checklist with tick, comment, and export features secured by QR code.
How to Use This Interactive Checklist
- Preparation: Gather sealant, primer, cleaners, backer rods, masking, blades, depth gauges, hygrometer, and moisture meter. Review approved submittals and manufacturer instructions. Confirm PPE and SDS. Calibrate instruments, set location IDs, and agree on acceptance criteria per approved project specifications and authority requirements.
- Using the Interactive Checklist: Open the checklist, start interactive mode, and progress item by item. Tick completions, attach photos/videos, and log readings in SI units. Use comments to flag nonconformances and assign actions. Generate live share links and verify authenticity with the built-in QR code.
- Sign-Off: Review the auto-generated summary with results, batches, and evidence. Capture digital signatures from installer, inspector, and stakeholder. Export as PDF/Excel, distribute to the project team, and archive with QR-backed traceability for future audits and warranty files.
Why Field Adhesion Testing Matters
Field adhesion testing verifies that sealant bonds to actual project substrates under current site conditions, not just in laboratory scenarios. It reveals real-world issues like residual oils, dust, excessive substrate moisture, or incorrect primers that compromise adhesion and lead to early joint leakage or staining. Executed with consistent geometry and timing, the hand-pull method provides a practical read on bond quality by distinguishing cohesive tearing of the sealant from adhesive separation at the interface. The process also confirms that surface preparation methods, such as solvent cleaning and priming, are compatible with the sealant and the substrate. When combined with reliable documentation—environmental readings, photos, and batch data—results become defensible evidence for acceptance per approved project specifications and authority requirements. This paragraph sets expectations for test frequency, repeatability, and pass/fail cues so teams can plan mock-ups, avoid rework, and achieve durable building envelope performance.
- Use representative locations for every substrate type and finish.
- Record ambient and surface conditions before application and testing.
- Differentiate cohesive tear from adhesive failure with photos.
- Link acceptance to project specifications and authority requirements.
Getting Substrates Ready for Reliable Bonding
Successful adhesion begins with clean, sound, and dry substrates. A solvent wipe test on a white, lint-free cloth should show minimal discoloration, indicating oils or fines have been removed. When laitance or old residues persist, mechanical abrasion followed by vacuuming improves surface profile and cleanliness. Moisture is a common cause of failure, so confirm substrate moisture content and surface temperature are within the manufacturer’s application range before priming or gunning sealant. Not all substrates need primer, but when specified, apply uniformly and respect coverage and drying times. Joint backing must prevent three-sided adhesion, set correct depth, and control geometry; choose closed-cell backer rod sized 25–33% larger than joint width, or use bond-breaker tape where rods cannot be used. Accurate measurements, photos, and batch logs prove compliance and reduce disputes during acceptance reviews.
- Verify moisture levels and surface temperature meet product limits.
- Use correct cleaner, lint-free cloth, and approved primer only.
- Backer rod size 25–33% larger than joint width.
- Prevent three-sided adhesion with rod or bond-breaker tape.
Executing and Interpreting the Hand-Pull Test
A consistent hand-pull test starts with proper bead application and a formed pull tab that cures sufficiently before testing. Cut a 25 mm wide strip back to the backing without scoring the substrate, then pull the tab at approximately 180° and steady speed to observe failure mode. Cohesive tearing within the sealant or substrate tear generally indicates strong adhesion; adhesive separation at the interface signals problems such as contamination, moisture, incompatible primer, or poor geometry. Record ambient conditions, batch numbers, cure times, and failure percentages for each test. Repeat across multiple locations for each substrate to validate repeatability. Where failures appear, tie them to a clear corrective action—recleaning, re-priming, backing adjustment—and schedule a documented retest after the specified cure interval. This disciplined approach drives predictable results and supports transparent acceptance decisions.
- Standardize tab width, angle, and pull rate.
- Capture close-ups showing failure mode clearly.
- Repeat tests across substrates for confidence.
- Define corrective actions and retest windows.
