Excavators in 2026: The King of Construction Goes Electric, Connected, and Intelligent

Summary

Excavators are the most versatile and widely used machines in construction, often performing the first major task on a project: excavation and site preparation. Modern excavators can dig, lift, load, demolish, and grade using a wide range of attachments. In 2026, the excavator industry is evolving rapidly with the introduction of AI-assisted operation, GPS machine control, electric powertrains, and telematics systems that improve productivity and reduce fuel consumption. This article explains how excavators work, the main types and technologies used today, the decision between renting and buying equipment, and the future direction of the excavator market as automation and autonomous systems become more common.

2026 Snapshot: The Excavator Market Is Entering the Intelligent Machine Era

By 2026 the excavator industry is experiencing a major technological transition. Manufacturers are moving beyond basic hydraulic machines toward connected, semi-autonomous construction equipment combining AI-assisted operation, GPS machine control, telematics, and advanced sensors. Some experimental systems are exploring “embodied AI” approaches, where machines interpret visual information and jobsite instructions using advanced models similar to vision-language-action (VLA) systems. While these technologies are still emerging, they illustrate the direction the industry is moving.

At the same time, manufacturers are expanding electric and hybrid excavators, particularly for urban construction where noise, emissions, and space constraints are important. GPS and telematics systems are also evolving from simple tracking tools into predictive maintenance and fleet-optimization platforms, allowing contractors to monitor machine health, reduce downtime, and optimize equipment utilization.

Although fully autonomous excavation remains rare outside controlled environments, the combination of AI assistance, digital machine control, and connected fleet systems is already transforming how excavators operate on modern construction projects.

1. Why the Excavator Is the King of Construction

Almost every construction project begins with excavation. Before foundations are poured, utilities installed, or structures built, the ground must be cleared, shaped, and prepared. The excavator is typically the first heavy machine to arrive on site and often remains one of the most important machines throughout the project.

Excavators are sometimes called the “king of construction equipment” because of their flexibility. A single machine can perform many tasks simply by changing attachments.

Typical tasks performed by excavators include:

  • Site clearing and earthmoving

  • Foundation excavation

  • Trenching for utilities

  • Demolition of structures

  • Material handling and loading trucks

  • Landscaping and grading

With modern attachments and hydraulic systems, an excavator can replace several specialized machines.

hydraulic excavator in soil early construction

2. Basic Components of an Excavator

Although excavators vary widely in size, their basic architecture is similar.

Undercarriage

The undercarriage supports the machine and allows it to move across the construction site.

Two main types exist:

Tracked (crawler) excavators

  • Best stability

  • Suitable for soft or uneven terrain

  • Common in heavy construction

Wheeled excavators

  • Faster movement between locations

  • Better suited to urban environments and road work

The undercarriage contains the tracks or wheels, rollers, drive motors, and travel system.

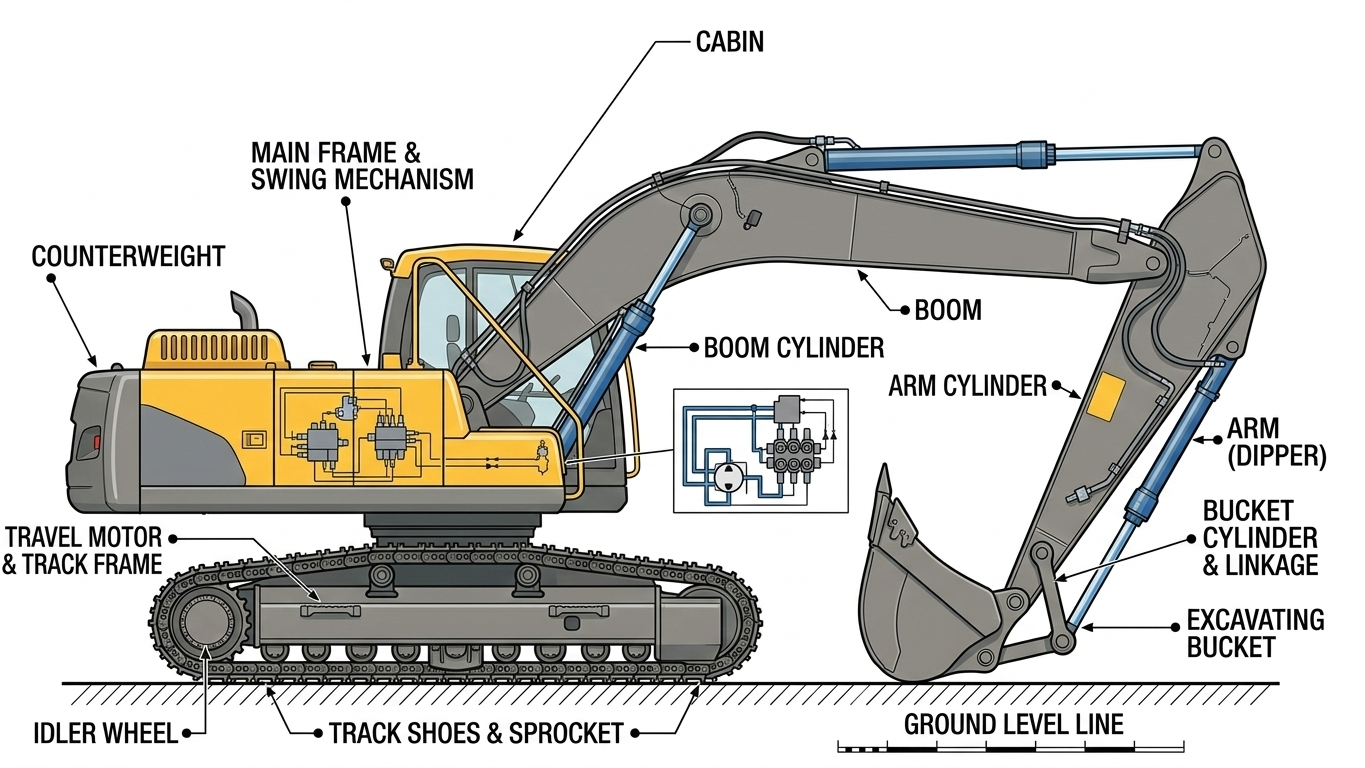

diagram excavator main components

Upper Structure (House)

The upper structure rotates 360° and contains the main operating systems:

  • Engine or electric power unit

  • Hydraulic pumps and valves

  • Operator cabin

  • Fuel tank or battery pack

  • Counterweight for stability

The ability to rotate the upper structure independently from the tracks allows the excavator to dig and load trucks efficiently without moving the entire machine.

Boom, Arm, and Bucket

The digging assembly consists of three main components.

Boom – the large primary arm connected to the machine.
Arm (stick) – the second segment that extends reach and depth.
Bucket – the attachment used to dig and move material.

Hydraulic cylinders control each joint, providing powerful and precise movement.

Hydraulic System

Excavators rely heavily on hydraulics. High-pressure hydraulic pumps convert engine power into mechanical force that moves the boom, arm, bucket, and swing motors.

Hydraulic systems allow excavators to:

  • Generate high digging forces

  • Move heavy loads precisely

  • Operate multiple attachments

The hydraulic system is one of the most critical and maintenance-intensive parts of the machine.

3. Types of Excavators

Different project conditions require different excavator configurations.

Crawler Excavators

These are the most common machines used in construction.

Advantages:

  • Excellent stability

  • High digging force

  • Suitable for rough terrain

Operating weights typically range from 15 tons to more than 90 tons.

Wheeled Excavators

These machines are designed for mobility.

Advantages:

  • Faster travel between work areas

  • Minimal damage to paved surfaces

  • Ideal for city construction and road maintenance

Mini and Compact Excavators

Mini excavators typically weigh between 1 and 10 tons.

Common uses include:

  • Utility installation

  • Landscaping

  • Residential construction

  • Indoor demolition

Their small size allows them to work in confined spaces.

Long-Reach Excavators

These machines use extended booms and arms to reach deeper or farther distances.

Typical applications:

  • Dredging canals and rivers

  • Excavation on slopes

  • Demolition of tall structures

Specialty Excavators

Some specialized machines include:

  • Dragline excavators (used in mining)

  • Suction excavators (used near underground utilities)

  • Amphibious excavators for wetlands

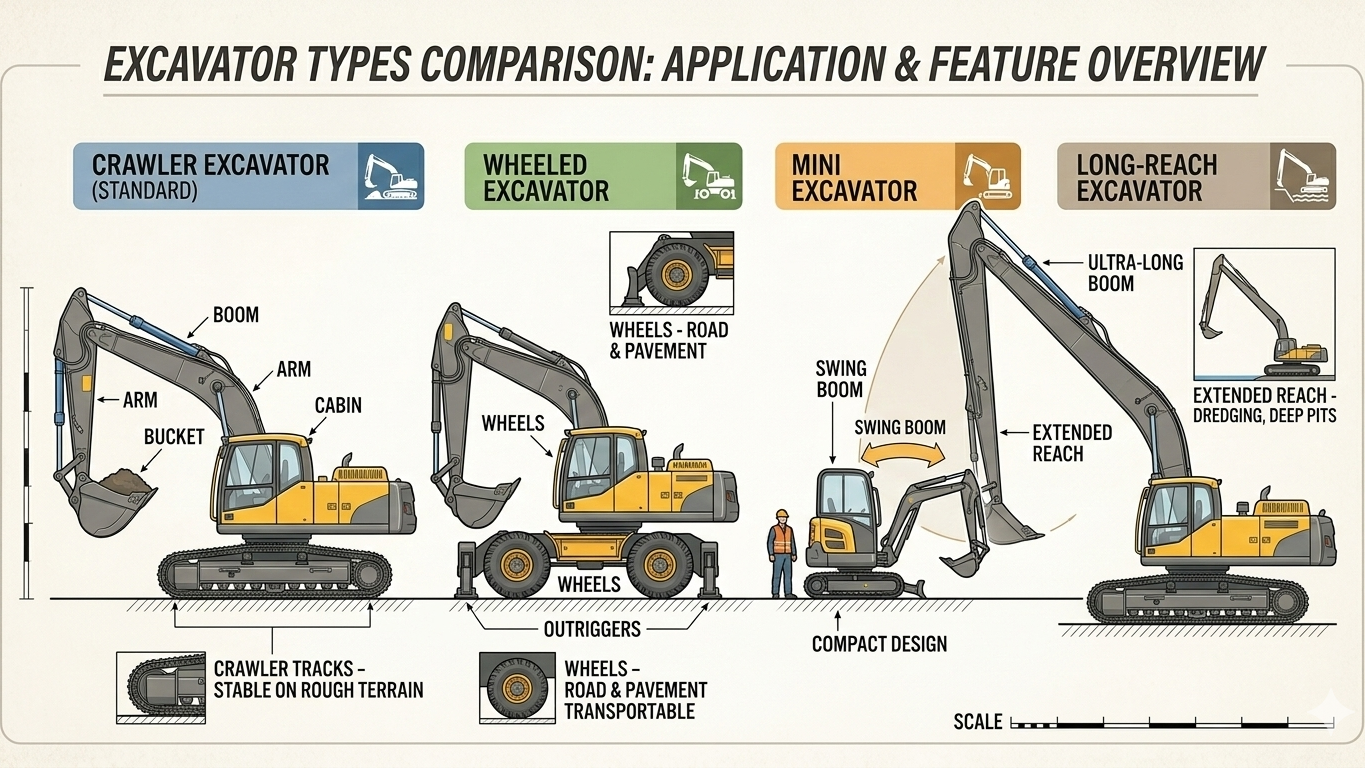

excavator type comparison

4. Excavator Attachments

Attachments dramatically increase the versatility of excavators.

Common attachments include:

Buckets

  • General purpose bucket

  • Trenching bucket

  • Rock bucket

Hydraulic breakers
Used for demolition of concrete and rock.

Augers
Used to drill holes for foundations, fencing, or utilities.

Grapples
Used for handling scrap, logs, or demolition debris.

Compactors
Used for soil compaction in trenches.

Tilt buckets and grading buckets
Used for finishing slopes and grading.

Modern quick-coupler systems allow operators to change attachments in minutes.

excavator multi attachment cataglog

Excavators are available in many size classes, from small machines used in urban construction to very large machines used in mining and heavy earthworks. The table below shows typical bucket capacities, common applications, and approximate productivity ranges used in construction planning. Actual productivity depends on soil conditions, swing angle, truck positioning, operator skill, and machine technology such as GPS machine control.

Excavator Class Operating Weight Typical Bucket Capacity Typical Productivity Typical Uses
Mini Excavator 1 – 6 tons 0.02 – 0.25 m³ 5 – 25 m³/hour Urban work, landscaping, utilities
Compact Excavator 6 – 10 tons 0.25 – 0.45 m³ 20 – 40 m³/hour Small construction sites, trenches
Medium Excavator 10 – 20 tons 0.45 – 0.9 m³ 40 – 90 m³/hour General construction, foundations
Standard Construction Excavator 20 – 35 tons 0.9 – 1.8 m³ 80 – 160 m³/hour Large building projects, roadworks
Heavy Excavator 35 – 50 tons 1.8 – 3.0 m³ 150 – 300 m³/hour Infrastructure, large earthworks
Ultra Heavy Excavator 50 – 90 tons 3.0 – 5.5 m³ 250 – 500 m³/hour Mining, mass excavation

How Many Cubic Meters Can an Excavator Dig Per Hour?

As a rough planning range, mini excavators may produce about 5 to 25 m³/hour, compact excavators about 20 to 40 m³/hour, medium excavators about 40 to 90 m³/hour, standard 20–35 ton excavators about 80 to 160 m³/hour, heavy excavators about 150 to 300 m³/hour, and ultra-heavy excavators about 250 to 500 m³/hour. Actual production depends on material type, bucket fill factor, digging depth, swing angle, truck positioning, cycle time, operator skill, and whether GPS machine control is used.

5. GPS Machine Control and Smart Excavation

In recent years, excavators have become increasingly integrated with machine control systems.

GPS and sensor technology allow excavators to work directly from digital design models.

Two main categories exist.

2D Machine Control

Provides guidance for depth and slope using laser or reference systems.

3D Machine Control

Uses GNSS (satellite positioning) combined with sensors on the boom and bucket to track the exact position of the bucket relative to the design model.

Benefits include:

  • Reduced staking and surveying work

  • Increased excavation accuracy

  • Less over-excavation

  • Faster project completion

Many major manufacturers now offer factory-installed grade control systems.

excavator at work digital precision

6. Artificial Intelligence and Operator Assistance

Artificial intelligence is beginning to play a larger role in construction equipment. Current implementations are mostly operator-assist systems rather than fully autonomous machines.

In many cases these systems are described as “intelligent excavators”, a term increasingly used by manufacturers to describe machines combining AI-assisted control, digital grade guidance, telematics, and automated digging features.

Examples include:

  • Automatic bucket leveling

  • Grade assist systems that stop the bucket at the correct depth

  • Intelligent swing control to avoid collisions

  • Automated digging cycles

AI systems analyze machine movement, terrain data, and bucket position to assist operators in real time. In most current machines the goal is augmented operation rather than full autonomy — helping operators dig more accurately, avoid obstacles, and maintain consistent productivity. When combined with GPS machine control and telematics data, these systems can improve grading precision, reduce rework, and provide valuable performance insights for fleet managers.

7. Electric Excavators

Another major trend in the industry is the transition to electric construction equipment.

Electric excavators replace the diesel engine with battery-powered electric motors.

Advantages include:

  • Zero local emissions

  • Lower noise levels

  • Reduced maintenance

  • Lower fuel costs in some regions

Electric machines are particularly attractive for:

  • Urban construction sites

  • Indoor demolition

  • Projects with strict environmental regulations

However, challenges remain:

  • Battery charging infrastructure

  • Limited operating hours compared to diesel machines

  • Higher initial purchase cost

As battery technology improves, electric excavators are expected to become more common.

electric excavator charging

8. How AI and GPS Help Reduce Fuel Consumption

Fuel is one of the largest operating costs for excavators. In practice, “fuel savings” from AI and GPS usually come from less wasted work (rework, over-digging, extra passes, and idling) rather than a magical improvement in engine efficiency alone.

Modern digital technologies can reduce fuel use through the following mechanisms:

  1. Reduced over-excavation
    GPS/machine control helps operators dig to the required depth and slope more consistently. This reduces unnecessary digging, minimizes over-break, and cuts the number of cycles needed to reach final formation.

  2. Fewer correction cycles (less rework)
    When excavation is accurate the first time, there is less backtracking to fix levels, fewer additional passes, and less time spent “chasing grade.” That directly reduces operating hours and fuel consumption.

  3. More efficient machine movement (cycle optimization)
    Operator-assist features can improve swing patterns, bucket control, and general digging rhythm—especially in repetitive operations such as trenching or mass excavation. Small reductions in cycle time, repeated thousands of times, become meaningful.

  4. Idle management and operator behavior insights
    Telematics and jobsite analytics highlight idle time and inefficient operating patterns. Contractors can use this data for coaching, better truck positioning, and improved jobsite planning, which often delivers fuel savings without changing the machine.

In some documented OEM comparisons, grade-control systems have shown material time reductions on specific tasks (for example, one Caterpillar case shows roughly 23% faster completion with grade technology in that setup). Actual savings vary widely depending on soil type, truck cycle time, operator skill, site layout, and the quality of the design data—but the direction is consistent: better accuracy and fewer wasted cycles generally mean less fuel burned.

9. Rent vs Buy: A Key Equipment Decision

Contractors frequently face the decision of renting or purchasing excavators.

When Renting Makes Sense

Renting is usually preferred when:

  • The project duration is short

  • Machine utilization is uncertain

  • Specialized equipment is needed temporarily

  • Contractors want to avoid maintenance responsibilities

Rental companies also handle storage, transport, and major repairs.

When Buying Makes Sense

Purchasing equipment may be better when:

  • Excavators are used continuously across projects

  • Utilization rates are high

  • Contractors want full control over equipment availability

  • Long-term costs are lower than rental fees

Many contractors perform a cost per hour analysis comparing rental rates with ownership costs such as depreciation, maintenance, insurance, and financing.

10. Maintenance and Inspection

Excavators operate in harsh environments and require regular maintenance.

Excavator Maintenance Checklists (Free Tools)

To help contractors, operators, and fleet managers implement proper equipment inspections, Quollnet provides a set of excavator maintenance checklists that can be used directly on site.

Each checklist is available in multiple formats:

  • Interactive online checklist

  • Downloadable PDF version

  • Excel version for internal reporting

  • Printable HTML format

Choose a checklist below (interactive, PDF, or Excel) for excavator daily inspections, preventive maintenance, hydraulics, undercarriage, wheeled systems, and GPS/AI calibration.

Tip: The interactive checklists allow operators to complete inspections directly on their phone or tablet and generate inspection records automatically.

11. Standards, Codes, Calibration and Testing Plans for Excavators

Excavators are not governed by a single “excavator code.” Instead, compliance and safe operation come from a mix of machine safety standards, performance test standards, and site procedures (inspection + calibration + verification). In practice, contractors and fleet managers typically focus on four areas: safety compliance, lifting verification, hydraulic performance, and machine-control (GPS/AI) validation.

11.1 Safety standards contractors actually rely on

These standards define baseline safety expectations for hydraulic excavators, including guarding, access, controls, stability, and information for use.

  • ISO 20474-1: General safety requirements for earth-moving machinery (applies across machine families).

  • ISO 20474-5: Excavator-specific safety requirements (hydraulic excavators).

  • EN 474-5 (Europe): Safety requirements for hydraulic excavators (harmonized EN in the EU context).

On real sites, this translates into checks like:

  • emergency stops / shutoffs present and functional

  • audible alarms, lights, mirrors/cameras working

  • safe access (steps/handrails), guards in place

  • stability rules followed (slope limits, swing zone control)

11.2 Lifting operations: lift charts and “can we lift this safely?”

Excavators often lift pipes, manholes, precast items, and small loads. When lifting becomes part of the planned work method, the minimum expectation is:

  • Use the manufacturer lift chart (including radius, height, bucket/attachment configuration, counterweight, and undercarriage position).

  • Verify the machine’s rated lift capacity method aligns with ISO 10567 (how lift capacity is calculated and verified).

Typical project testing / verification:

  • confirm the correct lift chart for the exact configuration (boom/arm, coupler, attachment, counterweight)

  • verify load radius on the ground (simple marked radii or machine-control display)

  • do a controlled “trial lift” at low height to confirm stability margin before routine lifting

11.3 Quick couplers and attachments: the biggest preventable hazard

A large portion of serious incidents comes from attachment release or incorrect coupler engagement. If you use quick couplers, treat them as a controlled safety system.

  • ISO 13031: Safety requirements for quick couplers on earth-moving machinery.

Practical site checks contractors implement:

  • coupler engagement verification step in the daily pre-start

  • visual confirmation of locking indicator (and secondary locking where applicable)

  • “shake test” / curl-and-extend test at low height before work begins

  • hose routing and protection checks (pinch points, abrasion points)

11.4 Visibility and operator protection: what gets tested on machines

OEMs certify designs, but contractors still verify functionality and site readiness.

  • ISO 5006: Operator field-of-view test method (visibility).

  • ISO 3471: ROPS performance requirements and lab test method.

  • ISO 12117: TOPS for compact excavators (tip-over protective structure).

What contractors actually do:

  • ensure mirrors/cameras are clean and functional at shift start

  • confirm seatbelt condition/use (small step, huge impact)

  • check ROPS/TOPS structure has no unauthorized drilling/welding/modifications

11.5 Hydraulic performance checks: “is the machine healthy?”

Most fleet downtime is hydraulics (leaks, overheating, contamination, hose failure). Contractors typically don’t run full lab tests, but they do structured field checks.

Common verification items:

  • leak mapping (hoses, fittings, cylinder seals)

  • abnormal pump noise / temperature rise

  • slow/jerky movement symptoms (air ingress, valve issues)

  • basic fluid condition checks and contamination prevention

(If you want to reference a performance test standard in your references list, tool force testing methods are covered in ISO 6015 documents).

11.6 Machine control (GPS/AI) calibration and validation plan

Machine-control accuracy is not “set and forget.” Contractors should treat it like surveying equipment: calibrate, validate, then monitor drift.

A practical calibration + testing plan:

  • Calibration: bucket tip calibration + boom/arm sensor checks at start of project and after transport/repairs

  • Corrections check: GNSS corrections/base connection confirmed before production digging

  • Model verification: confirm the correct surface/model version is loaded (avoid digging to the wrong revision)

  • Accuracy validation (“test dig”): cut a small test section and verify depth/slope with independent measurement

  • Ongoing checks: repeat quick validation after hard impacts, sensor replacement, or abnormal readings

11.7 Regulations (example: U.S. OSHA) — site rules still apply

Even with ISO/EN standards, local regulation and site safety procedures govern operations.

For U.S. readers:

  • OSHA construction standard for earthmoving equipment (Material handling equipment) includes items like seat belts and equipment condition requirements.

  • OSHA excavation/trenching rules affect how equipment works around excavations.

ISO Standards for Excavators

  • ISO 20474-1:2017 – General Safety Requirements: Outlines the primary safety specifications and common hazards for all types of earth-moving machinery.
  • ISO 20474-5:2017 – Hydraulic Excavator Safety: Specifies requirements specifically for hydraulic excavators, including stability and protection systems.
  • ISO 10567:2007 – Lift Capacity: Provides the uniform method for calculating and verifying the rated lift capacity of hydraulic excavators.
  • ISO 13031:2016 – Quick Couplers: Focuses on the safety systems required to prevent the unintended release of attachments from the excavator arm.
  • ISO 5006:2017 – Operator's Field of View: Defines the testing method and performance criteria to ensure the operator has adequate visibility around the machine.
  • ISO 3471:2008 – ROPS Standards: Detailed laboratory tests and performance requirements for Roll-Over Protective Structures.
  • ISO 12117:1997 – TOPS for Compact Excavators: Specifically addresses Tip-Over Protective Structures for mini/compact excavators.
  • ISO 6165:2022 – Vocabulary & Classification: The industry-standard guide for terminology and the basic classification of all earth-moving equipment.

OSHA Regulations & Safety

  • OSHA 29 CFR 1926.602 – Material Handling & Earthmoving: The federal regulation governing the safe operation and maintenance of earthmoving equipment on construction sites.
  • OSHA Trenching and Excavation Safety – Official Safety Guide (PDF): A comprehensive manual covering soil classification, sloping, benching, and protective systems for excavation work.

12. Major Excavator Manufacturers and Notable 2026 Models

The global excavator market is led by a handful of major OEMs, and competition is accelerating innovation in automation, fuel efficiency, electrification, and digital machine control.

12.1 Notable 2026 “trend” models to watch

  • Volvo EC560 (56-ton class) — Volvo CE debuted the all-new EC560 at CONEXPO 2026, positioning it as part of its next-generation lineup aimed at mass excavation and material transport.

  • Kubota KX040-5 (mini excavator) — Kubota’s KX040-5 is widely discussed as a top-selling mini excavator in the U.S., with industry coverage calling it “top-selling” and highlighting its next-generation updates.

12.2 Leading brands (with official product pages)

  • Caterpillar
  • Komatsu
  • Hitachi
  • Volvo Construction Equipment
  • Liebherr
  • Hyundai
  • Kobelco
  • SANY
  • JCB
  • Develon (formerly Doosan)

Volvo EC560

Kubota KX040-5

Manufacturer Lineups

13. The Future of the Excavator Market

The excavator industry is entering a period of rapid technological transformation.

Several major trends are shaping the future of the market.

Autonomous Excavators

Autonomous operation is one of the most significant developments.

Future excavators may be capable of:

  • Autonomous digging cycles

  • Automated truck loading

  • Remote operation from control centers

  • AI-based terrain analysis

These technologies are already being tested in mining operations, where equipment operates in controlled environments.

Fully Connected Construction Sites

Excavators will increasingly be connected to digital construction platforms.

Machines will share data with:

  • project management software

  • BIM models

  • surveying systems

  • fleet management platforms

This integration allows contractors to monitor productivity and progress in real time.

Electrification and Sustainability

Environmental regulations are pushing manufacturers toward:

  • electric powertrains

  • hybrid machines

  • hydrogen technologies

Sustainability goals are becoming an important driver in equipment procurement decisions.

autonomous excavators future quollnet

Conclusion

Excavators remain the backbone of construction projects. Their ability to perform multiple tasks with high efficiency makes them indispensable on modern job sites.

However, the excavator of today is very different from the machines used decades ago. With the integration of GPS machine control, artificial intelligence, telematics, and electric power systems, excavators are becoming smarter, cleaner, and more productive.

As automation and autonomous technologies continue to evolve, the excavator will likely remain the king of construction equipment, but it will increasingly operate as part of a connected and intelligent construction ecosystem.

Lena Miller's photo
Lena Miller
Mar 08, 2026
2
6
6.31k+
9.02k+

Excavators 2026 Trend: AI-Powered, Electric, and GPS-Controlled Construction Machines

Frequently Asked Questions

FAQ

Q: What does “AI excavator” actually mean in 2026?

A: In most real construction sites, “AI” means operator-assist features such as grade assist, auto-leveling, swing assist, payload/telematics analytics, and safety alerts. Fully autonomous excavation is still limited to controlled or highly managed environments.

FAQ

Q: Is GPS/machine control worth it for small contractors?

A: It can be, especially for repetitive work like trenches, formation levels, and backfill grading. The value usually comes from reduced rework, less over-excavation, faster production, and easier quality control. The ROI depends on utilization and how often you work to tight levels.

FAQ

Q: How much fuel can GPS and AI features actually save?

A: Savings mainly come from reducing wasted cycles (over-digging, correction passes, and idling). Results vary by job and operator, but projects with frequent grade corrections or tight tolerances typically benefit most.

FAQ

Q: What excavator size should I choose for foundations and general building works?

A: For typical building projects, contractors often use 10–20 ton excavators for general excavation and foundations, and mini/compact machines for confined areas and utilities. The right size depends on dig depth, access, production targets, and truck size.

FAQ

Q: Mini excavator vs wheeled excavator for urban work—what’s better?

A: Mini excavators win in tight access and low ground disturbance. Wheeled excavators win when you need frequent moves between locations, road travel, and fast repositioning on paved areas.

FAQ

Q: Are electric excavators practical in 2026?

A: They are most practical where noise and emissions matter (urban sites, indoor demolition, night work) and where charging logistics are manageable. For remote sites or long continuous duty cycles, diesel still dominates due to refueling speed and range.

FAQ

Q: Rent vs buy—what’s the simplest rule of thumb?

A: Renting usually wins for short projects, uncertain utilization, or specialized machines. Buying tends to win when utilization is high across multiple projects and you can control maintenance, storage, and operator consistency.

FAQ

Q: What are the most critical daily checks to prevent breakdowns?

A: Hydraulic leaks/hoses, fluid levels, track or tire condition, bucket/linkage wear, safety alarms, and cooling pack cleanliness. Catching small leaks and wear early prevents major downtime.

FAQ

Q: Do excavators have standards for lifting loads?

A: Yes. Excavator lifting should follow the manufacturer’s lift charts for the exact configuration, and lift capacity testing methods are covered by standards such as ISO 10567. Always treat lifting as a planned operation with proper radius control and spotter discipline.

FAQ

Q: Do machine-control systems require calibration?

A: Yes. Bucket tip calibration, sensor checks, GNSS corrections verification, and a small “test dig” validation are best practice—especially after transport, repairs, hard impacts, or when design models change.

Related Checklists

Excavator Daily Pre-Start Walkaround Safety Checklist
✅ 26 items
Excavator Daily Pre-Start Walkaround ensures every machine begins the shift safe, compliant, and fit for purpose. This daily pre-operation inspection, often called an excavator walk-around or prestart checklist, focuses on visible defects that cause downtime and incidents: hydraulic leaks, chafed hoses, worn pins, broken bucket teeth, missing guards, obscured mirrors or cameras, faulty alarms, out-of-date fire extinguishers, low fluids, and general damage. The scope covers all excavator types—crawler and wheeled—conducted on level ground with the engine off (unless function-testing). It excludes maintenance repairs and deep diagnostics, which must be escalated to qualified technicians per approved project specifications and authority requirements. By capturing measurements, photos, and comments, this checklist reduces unplanned stoppages, protects people and assets, and documents compliance. Begin outside-in, verify safety systems first, then undercarriage, structures, hydraulics, attachments, and fluids, finishing with a short start-up check. Use this interactive checklist to tick items, add comments, attach photos, and export PDF/Excel with a secure QR.
Hydraulic System Inspection & Leak Control for Excavators
✅ 30 items
Hydraulic System Inspection & Leak Control (All Excavators + Attachments) equips field crews and fleet managers to systematically assess excavator hydraulics and attachment circuits. This practical guide covers hose and fitting condition, cylinder seal integrity, pump pressures and temperatures, contamination indicators, quick coupler lines, and attachment flow/pressure checks. By focusing on leak prevention, cavitation avoidance, and cleanliness control, you reduce environmental incidents, fire hazards, unplanned downtime, and costly component failures. The scope is limited to mobile excavator hydraulic systems and auxiliary/quick-coupler circuits, including common attachments such as breakers, tiltrotators, grapples, and augers; it excludes electronic controls, engine systems, and structural inspections. Outcomes include verified setpoints, stable temperatures under load, clean fluid, secure connections, and documented evidence for maintenance and compliance. Use this interactive checklist on any device: tick off steps, add comments, capture photos and gauge readings, and export results to PDF/Excel with a secure QR link for verification.
Machine Control / GPS / AI System Check & Calibration Guide
✅ 20 items
Machine Control / GPS / AI System Check & Calibration (2026 Tech) helps excavator teams verify guidance accuracy before digging. This practical workflow covers machine control sensors, GNSS base/rover corrections, bucket tip calibration, 3D design model verification, and on-site test dig validation. By systematically checking IMU health, antenna setup, and communication links, you prevent cumulative errors that create overdig, service strikes, and rework. Verifying design versions and localization ensures your machine guidance aligns with the survey coordinate system and adjacent equipment. A short accuracy validation confirms vertical and slope tolerances under real ground conditions, while telematics connectivity and fault-code review keep data flowing and issues visible. The checklist is focused on excavator machine control; dozer/blade workflows are out of scope. Use it at shift start, after hardware changes, or when results drift. Open interactive mode to tick items, add comments, and export as PDF/Excel with a QR-secured sign-off.
Preventive Maintenance (Weekly / 50h) (All Excavators)
✅ 26 items
Preventive Maintenance (Weekly / 50h) (All Excavators) supports consistent service across brands and sizes with a single, practical workflow. This weekly excavator maintenance routine—often called a 50-hour service—focuses on greasing points, air intake checks, cooling pack cleaning, undercarriage cleaning, loose bolt verification, battery health, and basic fluid condition. By standardizing methods and evidence capture, the checklist prevents common failures such as overheating from clogged cores, dust ingestion through leaking ducts, track damage from improper tension, and electrical issues from corroded terminals. Acceptance cues and SI-based tolerances help operators and mechanics make fast, correct decisions on the job. The scope stops at light preventive tasks suited to field service; major repairs, diagnostics, and component overhauls must follow OEM manuals and be executed per approved project specifications and authority requirements. Use the interactive features to tick items, add comments, attach photos, and instantly export PDF/Excel with a secure QR link.
Tires, Steering & Brakes Inspection (Wheeled Excavators)
✅ 22 items
Tires, Steering & Brakes Inspection (Wheeled Excavators) provides a focused, job-ready process for confirming tire condition, steering responsiveness, and brake performance on roadable excavators. This practical guide also covers a wheeled excavator brake test, steering system check, road lights verification when applicable, and checks for axle and drivetrain leaks. The scope is limited to mobile safety-critical systems; it excludes boom, upperstructure hydraulics, and electrical diagnostics unrelated to roading. Following it reduces puncture-related downtime, irregular tire wear, steering wander, and hazardous rollaway or insufficient stopping. You will capture readings in kPa, N·m, MPa, and mm, with photos and signatures that stand up to audits. Acceptance cues emphasize manufacturer specifications, visual evidence of no fresh wetting, controlled stopping characteristics, and dependable signaling for on-road moves per approved project specifications and authority requirements. Start the interactive mode to tick items, add comments, and export results to PDF or Excel using the built-in QR code for verification.

Related Articles

Ai In Construction Delay Forecasting
⏳ 4 min read
Ai In Construction: Predicting And Preventing Project Delays With Predictive Analytics
Learn how AI in construction is transforming project management by using predictive analytics, real-time data, and machine learning to forecast and prevent delays, improve scheduling accuracy, optimize resources, and reduce costly overruns and assist in Delay Claims and EOT's using DelayClaim GPT
Advanced Fire Safety Solution For High Rise Buildings
⏳ 5 min read
Advanced High-rise Fire Safety: Drones & Modern Equipment
Learn how integrating firefighting drones, AI, thermal cameras & modern fire trucks enhances high-rise fire safety, reducing risks for occupants & responders.
Excavators 2026 Ai Electric Gps
⏳ 23 min read
Tendance Des Excavatrices En 2026 : Machines De Construction Alimentées Par L’ia, Électriques Et Contrôlées Par Gps
Un guide complet des excavatrices en 2026 couvrant l’excavation assistée par IA, les excavatrices électriques, le guidage machine GPS, l’optimisation de la consommation de carburant, les décisions location vs achat, les normes de maintenance et l’avenir des équipements de construction autonomes.
2025 Firefighting Tech Revolution Advanced Systems
⏳ 3 min read
2025 Firefighting Tech Revolution: 21 Advanced Systems Every Department Needs (free Download)
Discover 21 cutting-edge firefighting technologies for 2025, from AI drones to eco-suppression systems. Get the free guide to future-proof your department
Safety Construction Safety Checklists
⏳ 5 min read
Safety In Construction: The Role Of Periodic Safety Checklists
Discover how implementing daily, weekly, and monthly safety checklists can improve compliance and reduce accidents on construction sites.
