Test façade movement joints for opening range and seal continuity with a structured, field-ready checklist for façade inspectors and QA teams to verify movement capability, seal adhesion, and watertight continuity on mock-ups and installed sections.
- Verify design movement range with controlled displacement and measurements.
- Confirm sealant continuity, adhesion, and watertightness under spray testing.
- Capture photos, measurements, and batch data for traceable QA acceptance.
- Interactive, commentable checklist; export results with QR code verification.
The checklist
Pre-Test Documentation and Setup
- Confirm latest drawings/specifications show joint schedule (nominal width, design movement in mm/%) and sealant system; record document titles, revisions, and approvals.

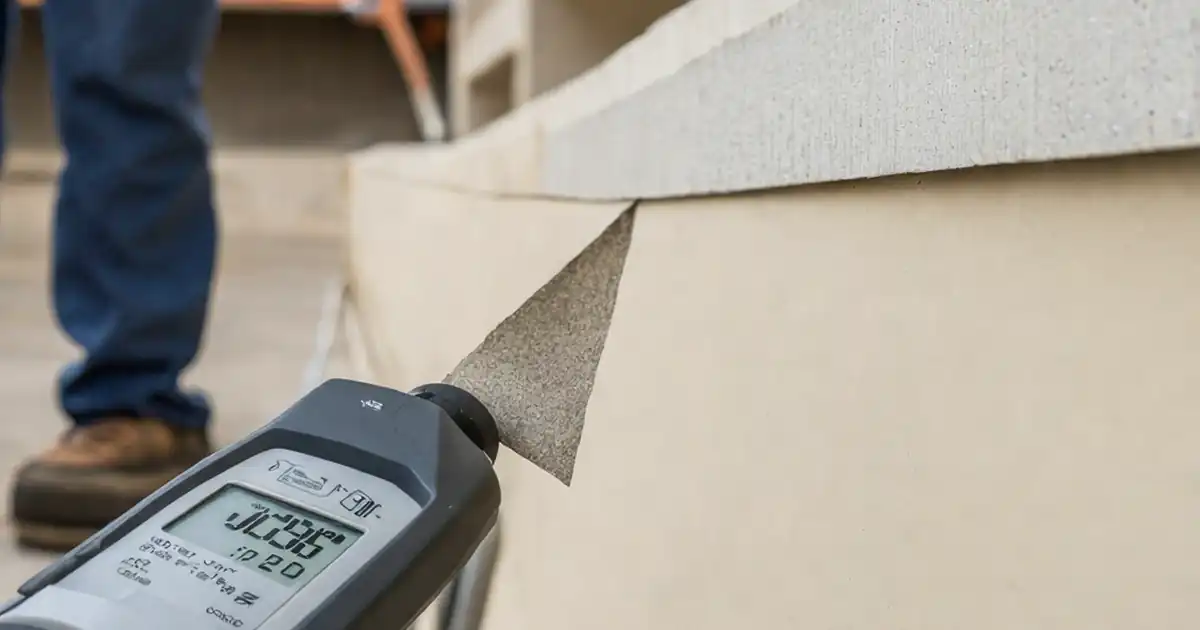

- Verify tool calibration: digital caliper (0.01 mm), crack gauge, displacement gauge (±25 mm, 0.1 mm), thermohygrometer, pressure gauge; upload current calibration certificates.
- Select test locations (mock-up plus representative installed joints at mid-span, corners, and interfaces); create a location plan with unique IDs and overview photos.
Access and Safety
- Confirm access (MEWP/scaffold) and fall protection are inspected and tagged; record permits to work and toolbox talk attendance with signatures and photos.
Environmental and Substrate Conditions
- Measure ambient and substrate temperature and RH; confirm within manufacturer service range (e.g., 5–35 °C); log readings and time-stamp.
- Verify sealant cure status per manufacturer guidance (e.g., thickness/time); perform tack-free or durometer spot check; record batch/lot numbers and expiry dates.
- Confirm joint flanks are clean and dry; perform white-cloth wipe test; photograph cloth and joint edges to evidence cleanliness.
Visual Inspection of Sealant System
- Measure joint width at 1 m intervals and transitions using a digital caliper; compare with schedule; acceptable within specified tolerance (e.g., ±2 mm); record table.
- Check sealant depth/profile using a pin depth gauge at discreet points; target per specification (often ~50% of width); neatly patch and photo-document.
- Verify backer rod diameter is 25–30% larger than joint width; confirm closed-cell type or bond-breaker tape where required; retain offcut sample and photos.
- Inspect bead for voids, pinholes, poor tooling, or contamination; no visible adhesion gaps; mark defects on elevation and photograph close-ups with scale.
Opening Range Test (Controlled Segment/Mock-up)
- Install displacement gauge across the joint using stable bases; zero the instrument; photograph setup with gauge reading visible.
- Extend the joint to the design maximum opening (e.g., +25% or stated mm) using a screw jack/spreader with soft pads; hold 60 s; record displacement and observations.
- Compress the joint to the design minimum (closing) without substrate contact; hold 60 s; note any bulging, extrusion, or debonding; record displacement achieved.
- Cycle between min and max openings 10 times (5–10 s per cycle); acceptable if no adhesive failure, tearing, or cracking; capture video/photos each cycle.
- After cycling, allow 10 min recovery; measure permanent set; acceptable recovery per specification (e.g., ≥90% original width); log values and photo evidence.
Seal Continuity and Water Verification
- Gently probe the bead with a rounded spatula along its length; uniform resistance with no soft voids; flag and photograph any suspect spots.
- Conduct water-spray test at 200 ± 20 kPa for 10 min, nozzle 300–500 mm away; no interior dampness or drips; record pressure and video.
- Use a borescope at accessible cavities to view back-of-seal; no daylight or gaps; save stills with location IDs.
- Perform field adhesion peel test on a 150 mm tab at a non-critical area or mock-up; cohesive or substrate failure acceptable; document failure mode; repair cut.
Documentation and Close-out
- Compile readings, photos, calibration certs, product datasheets, and batch records; complete pass/fail checklist entries with inspector and contractor signatures.
- Assign corrective actions for defects with responsible party and target dates; link items to locations; attach marked-up elevations.
- Retest rectified joints using the same procedures; attach before/after media; record acceptance per approved project specifications and authority requirements.
- Apply QR code label at approved joints linking to the final report; verify scan works from site and archive in project system.
Preview the printable checklist
Preview page one below. Open the image or download the PDF for all pages.
At a glance
- Validate that movement joints achieve the scheduled opening range without debonding or tearing, and confirm sealant continuity under controlled cycling and water-spray. Capture dimensions, cure status, batch numbers, and defects with photo evidence for traceable quality assurance and clear acceptance decisions aligned with project specifications.
- Reduce leakage and warranty risks by verifying the complete sealant system—joint geometry, backer rod, bond-breaker tape, tooling, and adhesion—before, during, and after movement testing. Representative sampling at mid-spans, corners, and interfaces highlights worst-case conditions and improves confidence in long-term façade performance.
- Interactive online checklist with tick, comment, and export features secured by QR code.
- Close out efficiently with a structured report: calibration certificates, environmental conditions, displacement records, spray pressures, and pass/fail outcomes. Assign corrective actions with deadlines, retest evidence, and digital sign-offs so owners and consultants can archive authenticated documentation for future audits and maintenance planning.
How to use this interactive checklist
- Preparation: gather drawings/specs, joint schedule, manufacturer datasheets, and calibration certificates. Mobilize tools (calipers, displacement gauge, thermohygrometer, spray rig), access equipment, PPE, and a borescope for concealed views.
- Create test locations: assign unique IDs to mock-ups and representative joints, upload overview photos, and set acceptance criteria per approved project specifications and authority requirements.
- Switch to interactive mode: open the digital checklist, select the location, and begin logging measurements. Attach photos/videos and note environmental readings directly in the fields.
- Tick items as completed and add comments for any variance or defect. Tag responsible parties and propose corrective actions with target dates.
- Export mid-test snapshots to PDF/Excel for coordination meetings. Share the link or QR code with stakeholders for quick access to current records.
- After rectification, duplicate the test run and perform retests. Attach before/after evidence and mark items as passed when acceptance cues are met.
- Sign-Off: capture digital signatures from the inspector, contractor, and consultant. Finalize the report, archive it to the project system, and verify QR authentication on-site.
Why opening range and seal continuity matter
Movement joints allow façades to expand, contract, and drift without concentrating stress. If the joint cannot open and close to the design range, the sealant may tear or debond, leading to water ingress, staining, and hidden damage. Seal continuity completes the barrier; even a small void or adhesion gap can channel water into insulation or interiors. This checklist helps teams verify joint geometry, backer rod fit, sealant cure, and adhesion prior to controlled cycling. It then validates watertightness with targeted water-spray and visual/borescope checks. Acceptance hinges on achieving the specified movement without loss of continuity and no leaks, all documented with calibrated measurements and media. The result is predictable performance, fewer call-backs, and strong warranty posture for owners and contractors.
- Design movement achieved without tearing or adhesive failure.
- Uniform seal continuity; no voids, skips, or daylight paths.
- No water ingress under defined spray pressure and duration.
- Calibrated tools and recorded conditions build traceability.
Practical methods and acceptance cues in the field
On-site testing focuses on representative joints and mock-ups where controlled cycling is safe. Use a displacement gauge with a screw jack or spreader to reach the scheduled maximum and minimum openings, holding each position to observe the seal. Record permanent set after cycling to gauge recovery. Visual checks should confirm proper depth, hourglass profile, and flank cleanliness, with backer rod size 25–30% larger than joint width. Continuity probing with a rounded spatula identifies soft spots without damaging the bead. Water-spray testing at a documented pressure and distance verifies the weather seal; observe interior faces continuously. For adhesion, a small peel test on mock-ups or sacrificial zones should produce cohesive rather than adhesive failure. Acceptance is always per the approved specification and project requirements.
- Measure widths and depth; compare against joint schedule.
- Cycle min-to-max with recorded displacement and dwell times.
- Probe continuity, then verify with controlled water-spray.
- Adhesion peel: cohesive failure is acceptable evidence.
Typical defects, their causes, and fixes
Common failures include adhesive debonds at contaminated flanks, cohesive tears from underfilled joints, and voids caused by poor gun technique or oversized beads. Excessive bulging or extrusion during compression suggests incorrect backer rod or insufficient depth. Daylight behind the bead points to discontinuities at corners or substrate steps. To fix, remove defective sealant to sound edges, clean and prime where specified, install correctly sized backer rod or bond-breaker tape, and re-apply sealant with proper tooling. Recheck cure status before retesting. Reinforce craft quality by reviewing batch numbers, expiry dates, and environmental limits. Close out only after retesting shows the design opening range is met and no water ingress occurs, with all evidence attached to the checklist and signed by responsible parties.
- Debonding: contamination or missing primer at flanks.
- Voids/pinholes: poor application or trapped debris.
- Bulging/extrusion: wrong backer rod size or depth.
- Discontinuities: corners, interfaces, or step changes.
