G
Guest

construction · 24 checks

Apply Horizontal Spray-Applied Membranes: Coverage, Adhesion, Protection

Apply horizontal spray-applied membranes is a focused field activity requiring disciplined verification of coverage, rebound control, adhesion, and protection on horizontal substrates. This checklist supports spray-applied waterproofing and horizontal membrane application workflows—excluding liquid-applied roll-on or brush coatings—to deliver a uniform, durable barrier. It guides users through pre-application controls, equipment setup, application sequencing, overspray and rebound capture, adhesion pull-off testing, curing verification, and final protection. By emphasizing substrate readiness, dew point and temperature windows, controlled spray passes, and pinhole detection, it helps avoid premature failures, delamination, punctures, and costly rework. The result is a membrane applied to the specified thickness with consistent bond, free of unbonded rebound and surface defects, and appropriately protected before construction traffic or backfilling. Use this interactive checklist to tick tasks, leave clarifying comments, upload photo evidence, and export as PDF/Excel with an embedded QR for secure traceability.

Apply Horizontal Spray-Applied Membranes Checklist: QA Guide

Apply horizontal spray-applied membranes checklist for site supervisors and inspectors, defining coverage, rebound control, adhesion, curing, and protection on horizontal substrates; excludes liquid-applied systems.

  • Confirm design thickness and uniform coverage across all horizontal areas.
  • Control rebound and overspray to prevent defects and material waste.
  • Verify adhesion and curing before protection or opening to traffic.
  • Interactive, commentable, export options with QR code record security.

The checklist

Pre-Application Controls

  1. Confirm the selected system is spray-applied (not roll-on liquid). Attach product datasheet and approval.
  2. Verify substrate is clean, sound, and dry; no standing liquid. Photograph surface and record moisture readings per manufacturer.
  3. Confirm surface profile matches specification (e.g., ICRI CSP range). Document comparator reading and location grid.
  4. Record ambient/substrate temperatures and relative humidity; ensure ≥ 3 °C above dew point. Attach hygrometer/IR thermometer readings.
  5. Mask terminations, drains, and adjacent finishes; install wind screens. Photo evidence of controls before spraying.

Equipment & Nozzle Setup

  1. Calibrate pump and nozzle per manufacturer; record pressures, component temperatures, and hose heat settings with a calibration photo.
  2. Spray test panel; confirm uniform fan and atomization. Measure wet film thickness at five points using a comb gauge; log results.
  3. Set nozzle distance 300–500 mm and 90° angle to substrate. Capture a short video and note operator name.
  4. Stage rebound/overspray collection: trays, tarps, and labeled waste bins. Photo location plan with capacities.

Application & Coverage Control

  1. Apply first pass to 50–60% of target thickness. Verify wet film at 1 m grid; acceptance within ±10% of target.
  2. Apply cross-pass to eliminate ridges; maintain overlap 50% with steady traverse speed. Photo showing overlap pattern.
  3. Record coverage yield (m² per kg/L) versus plan; acceptance within −5% to +10%. Attach calibrated scale or batch reconciliation sheet.
  4. Detail edges, penetrations, and terminations with continuous wrap ≥ 100 mm beyond interface. Close-up photos confirming no pinholes.
  5. Confirm total dry thickness not less than specified using magnetic/ultrasonic gauge after cure; 10 readings per 100 m² logged.

Rebound & Overspray Management

  1. Collect rebound immediately; do not re-use. Weigh and log waste mass per 100 m²; meet project limit (target ≤ 10% if unspecified).
  2. Inspect surface for embedded rebound; remove loose material and re-spray. Acceptance: sound surface verified by coin-tap; photo evidence.
  3. Monitor wind with anemometer; stop spraying if wind speed exceeds 8 m/s. Attach readings and hold-point sign-off.
  4. Clean adjacent finishes within 15 minutes using approved method. Photos before/after and waste disposal note.

Adhesion & Curing Verification

  1. Perform pull-off adhesion tests (minimum 3 per 500 m²). Acceptance: ≥ specified MPa; record failure mode and gauge trace.
  2. Conduct pinhole/holiday detection using low-voltage wet sponge on cured membrane. Acceptance: zero holidays; attach marked layout.
  3. Verify minimum cure time achieved before protection; no liquid exposure during cure. Timestamped photos and curing log attached.

Protection & Handover

  1. Install protection boards or geotextile; full contact without wrinkles. Photos showing overlaps and edge restraint.
  2. Check final surface slopes with laser/2 m straightedge; no depressions > 5 mm. Upload level screenshots and grid map.
  3. Establish exclusion zone and signage; restrict traffic and point loads. Post QR-linked QA board and capture sign-off photos.

Preview the printable checklist

Preview page one below. Open the image or download the PDF for all pages.

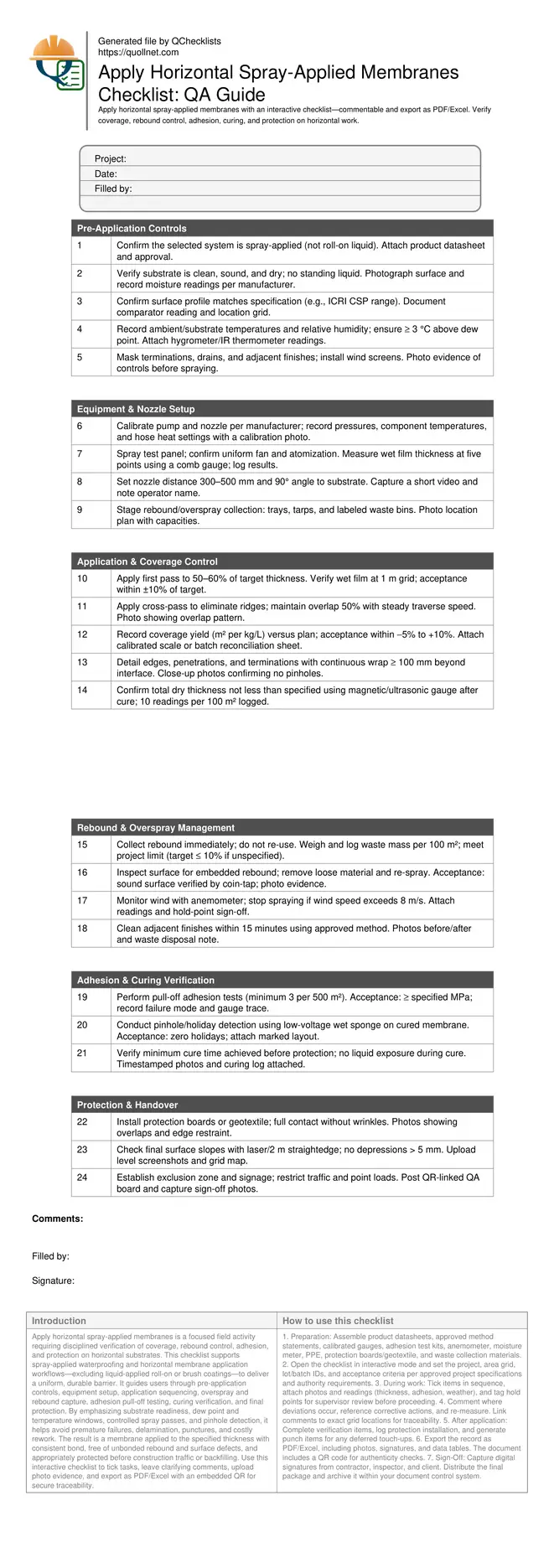

First-page preview of the Horizontal Spray-Applied Membranes (Application QA) printable checklist template.
Horizontal Spray-Applied Membranes (Application QA) · Page 1 preview · Open image with all pages

At a glance

  • Ensure specified thickness and coverage using grid-based measurements and calibrated gauges, then verify adhesion with representative pull-off tests. The process reduces variability, catches early defects such as pinholes and weak bond, and documents evidence for client acceptance per approved project specifications and authority requirements.
  • Manage rebound and overspray using screens, collection trays, and real-time housekeeping. Capturing waste, stopping work under excessive wind, and prohibiting re-use of rebound prevent embedded debris, ridges, and thin spots. Logging waste and environmental readings creates transparent, auditable quality records across each pour or daywork section.
  • Protect the membrane promptly with geotextile or protection boards and enforce exclusion zones to prevent point loading, UV exposure, and premature wetting. Curing and protection milestones—time, temperature, and coverage—are timestamped with photos, batch IDs, and signatures, ensuring the assembly’s long-term waterproofing performance and warranty integrity.
  • Interactive online checklist with tick, comment, and export features secured by QR code.

How to Use This Interactive Checklist

  1. Preparation: Assemble product datasheets, approved method statements, calibrated gauges, adhesion test kits, anemometer, moisture meter, PPE, protection boards/geotextile, and waste collection materials.
  2. Open the checklist in interactive mode and set the project, area grid, lot/batch IDs, and acceptance criteria per approved project specifications and authority requirements.
  3. During work: Tick items in sequence, attach photos and readings (thickness, adhesion, weather), and tag hold points for supervisor review before proceeding.
  4. Comment where deviations occur, reference corrective actions, and re-measure. Link comments to exact grid locations for traceability.
  5. After application: Complete verification items, log protection installation, and generate punch items for any deferred touch-ups.
  6. Export the record as PDF/Excel, including photos, signatures, and data tables. The document includes a QR code for authenticity checks.
  7. Sign-Off: Capture digital signatures from contractor, inspector, and client. Distribute the final package and archive it within your document control system.

Coverage and Thickness: Getting Uniform Results

Uniform coverage on horizontal substrates starts with environmental control and a disciplined pass strategy. Grid the area at 1 m intervals and measure wet film thickness immediately after each pass using a calibrated comb gauge. Use cross-direction passes at 50% overlap to eliminate ridges and shadows behind penetrations. Record actual yield against planned consumption to catch thin spots early. After curing per manufacturer guidance, verify dry film thickness with a magnetic or ultrasonic gauge at a statistically representative frequency (e.g., 10 readings per 100 m²), marking outliers for targeted repair. Acceptance cues include continuous film at edges and terminations, no visible pinholes, and thickness at or above the specified minimum. Document everything—photos with a steel ruler, gauge screenshots, and batch IDs—so your quality evidence is unambiguous and repeatable across pours or daywork sections.

  • Grid at 1 m for repeatable measurements.
  • Use cross-passes to remove ridges.
  • Record yield and reconcile consumption.
  • Verify dry thickness after full cure.
  • Photograph edges and terminations closely.

Adhesion, Curing, and Defect Detection

Adhesion is the decisive performance metric. Conduct pull-off tests at representative locations, avoiding known weak zones and recording failure modes to demonstrate substrate or cohesive membrane failure rather than adhesive failure. Maintain ambient and substrate temperatures within the product window, with a ≥ 3 °C dew point margin. Do not expose the uncured membrane to liquids or traffic. After curing, perform a low-voltage wet-sponge holiday test to locate pinholes, mark them visibly, and repair per the manufacturer’s method. Curing records—time, temperature, humidity—support both performance and warranty discussions. Before protection boards or geotextile go down, confirm adhesion meets the specification and the membrane is defect-free across penetrations and terminations. These controls deliver a bonded, continuous barrier ready for protection without risking delamination or moisture entrapment.

  • Pull-off tests with logged failure modes.
  • Respect dew point and cure windows.
  • No liquid exposure before full cure.
  • Holiday test and mark repairs.
  • Verify before installing protection.

Rebound, Overspray, and Protection Measures

Rebound and overspray are predictable by-products of spraying; plan to capture them and prevent re-incorporation. Install wind screens, trays, and tarpaulins, and track waste mass by area. Stop spraying when wind exceeds safe limits to avoid drift and thin zones. Inspect for embedded rebound using a coin-tap or scrape test; remove loose material and re-spray locally to the specified thickness. Clean adjacent finishes promptly to avoid staining. After quality checks and cure, install protection boards or geotextile to prevent point loading and UV/weather exposure, and establish exclusion zones until the assembly is covered or backfilled. Maintain as-built documentation—photos, readings, waste logs, and signatures—so any future investigation has a complete and trusted record per approved project specifications and authority requirements.

  • Capture and log rebound waste by area.
  • Suspend work during high winds.
  • Remove embedded rebound before touch-up.
  • Protect membrane before traffic.
  • Keep full, signed QA records.

Yuki Takahashi's photo
Yuki Takahashi
18107
562
29
45

Frequently asked questions

What counts as acceptable coverage and thickness for spray-applied membranes on horizontal surfaces?

Acceptable coverage means achieving at least the specified minimum dry thickness uniformly, verified by a grid of measurements and reconciled material yield. Measure wet film during application and dry film after curing. Investigate outliers and repair to specification. Document locations, readings, photos with a scale, and batch IDs to support acceptance.

How do I control and document rebound during spray application?

Plan containment with wind screens, tarps, and collection trays before starting. Weigh and log rebound waste by area, and do not re-use it. Inspect for embedded rebound with a tap or scrape test; remove and re-spray locally to the target thickness. Attach waste logs, photos of bins, and corrective action notes to the checklist.

When and how should adhesion be verified?

Perform pull-off tests after curing at representative locations per project specifications. Record the peak force, calculate adhesion (MPa), and document the failure mode. Adhesion should meet or exceed the specified value. Conduct tests before installing protection layers so any deficiency can be repaired and re-tested without rework.

What does “exclude liquids” mean in this checklist?

This checklist excludes liquid-applied roll-on or brush coatings from scope and requires avoiding standing water or liquid exposure during curing. It is designed for spray-applied membrane systems on horizontal substrates. If you are using a liquid-applied system, follow the dedicated liquid-applied membrane checklist and acceptance criteria.

What environmental limits should I observe during spraying?

Keep substrate and ambient temperatures within the manufacturer’s range and ensure the substrate temperature stays at least 3 °C above the dew point. Monitor wind; suspend spraying when wind causes drift or exceeds your project limit. Record all readings with time, location, and instrument IDs for auditability.
